Citizen’s Energy has successfully bored a new 8-inch gas main along 96th Street. This vital infrastructure project ensures a reliable gas supply to The Ridge on Williams Creek, paving the way for future development and growth.

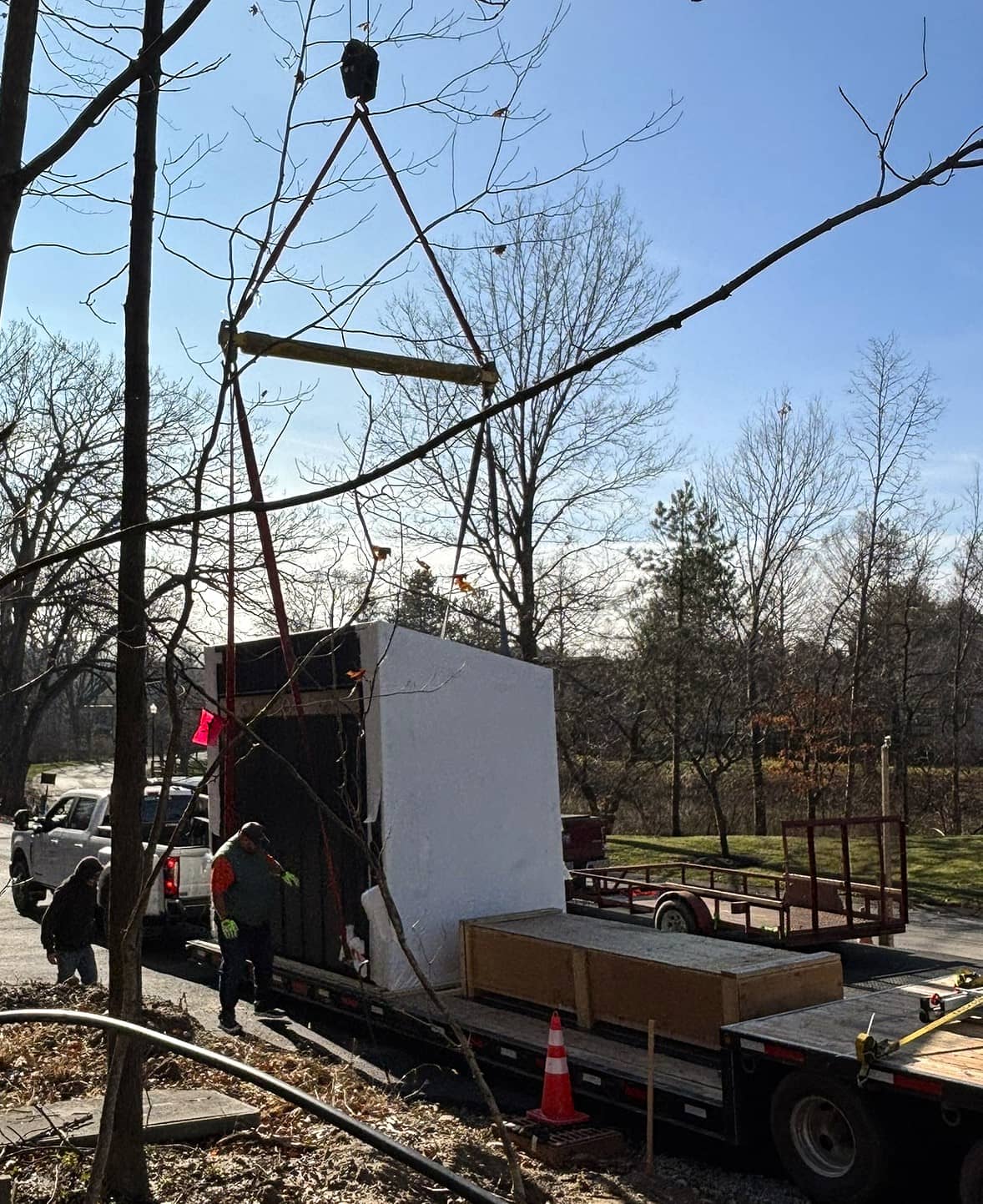

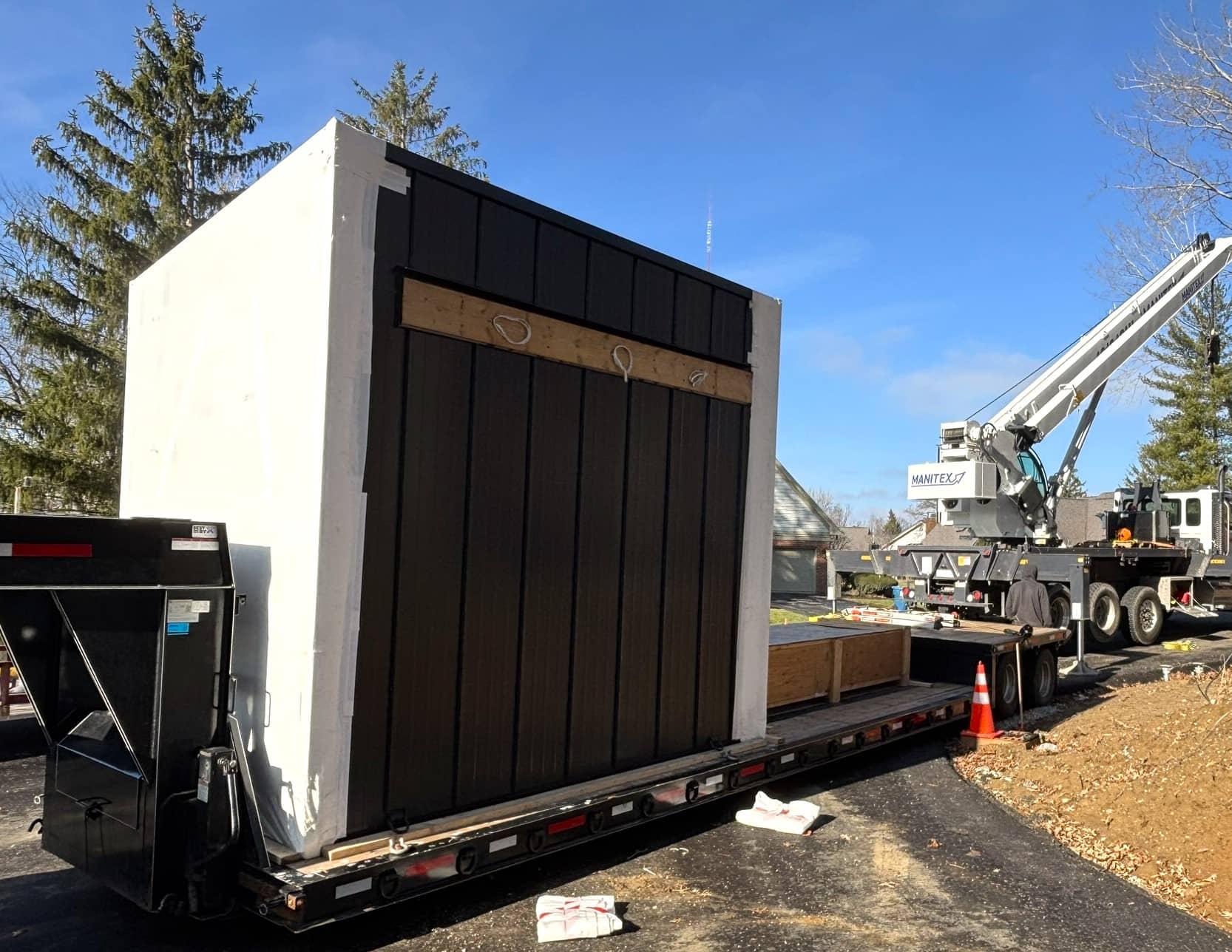

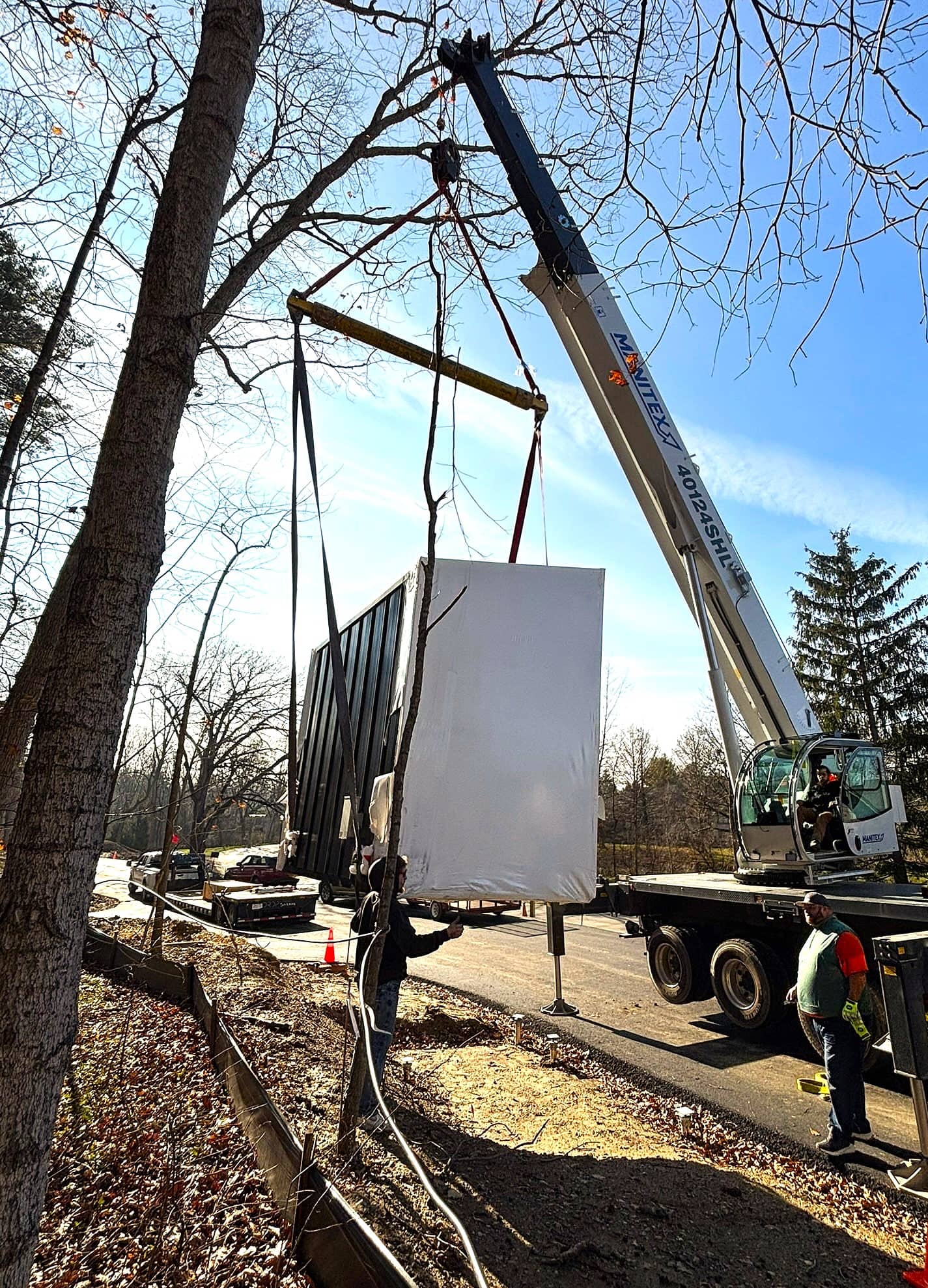

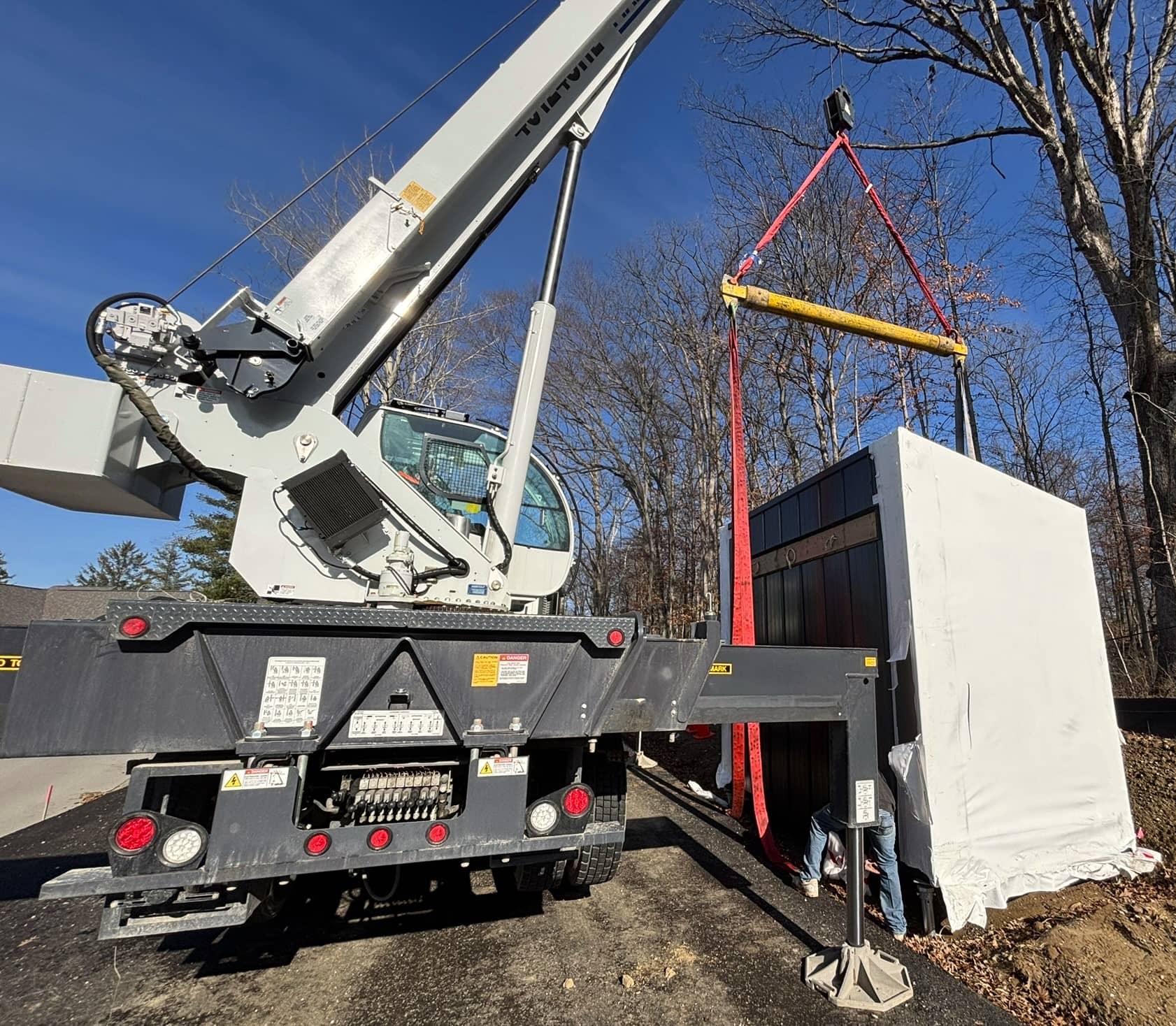

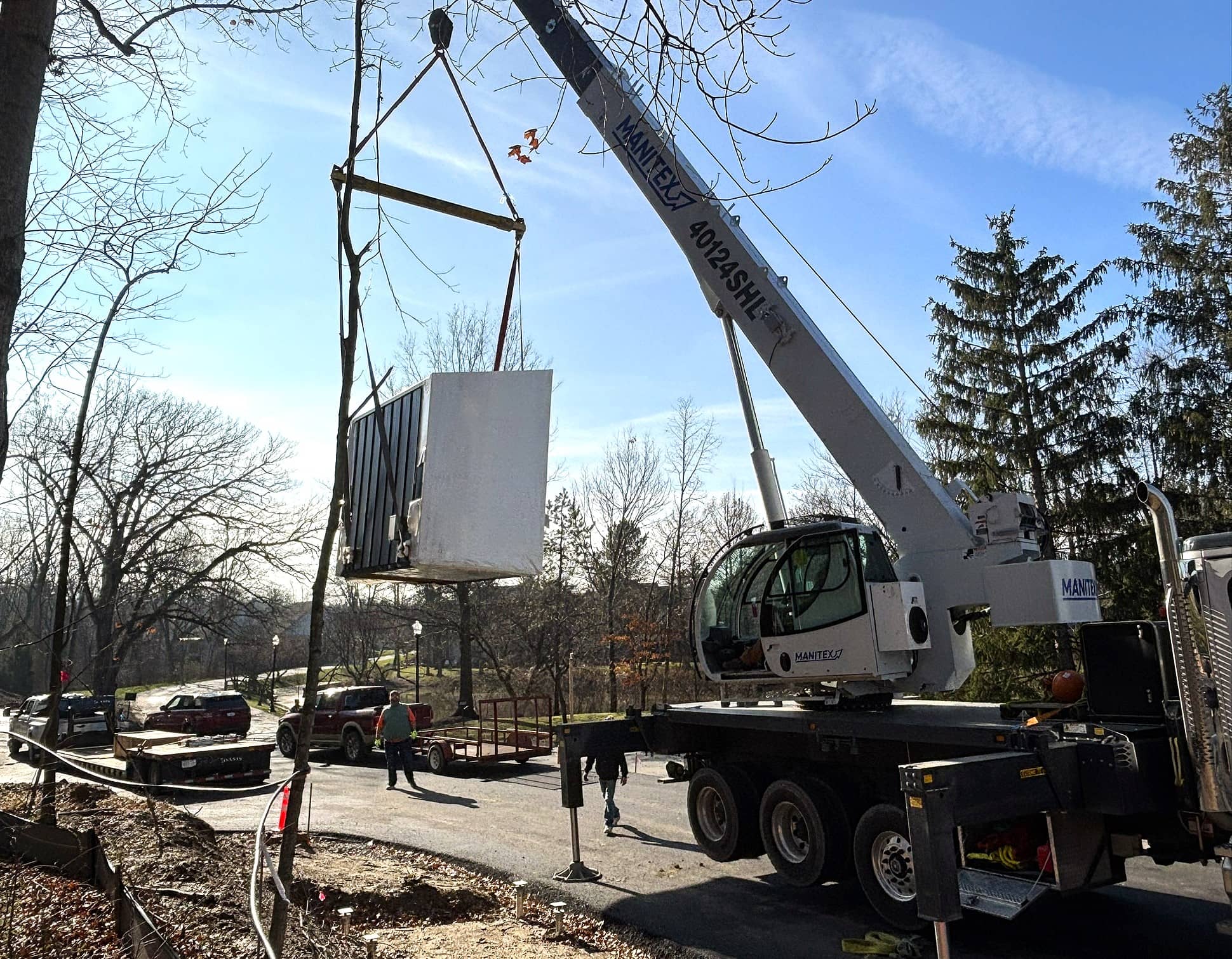

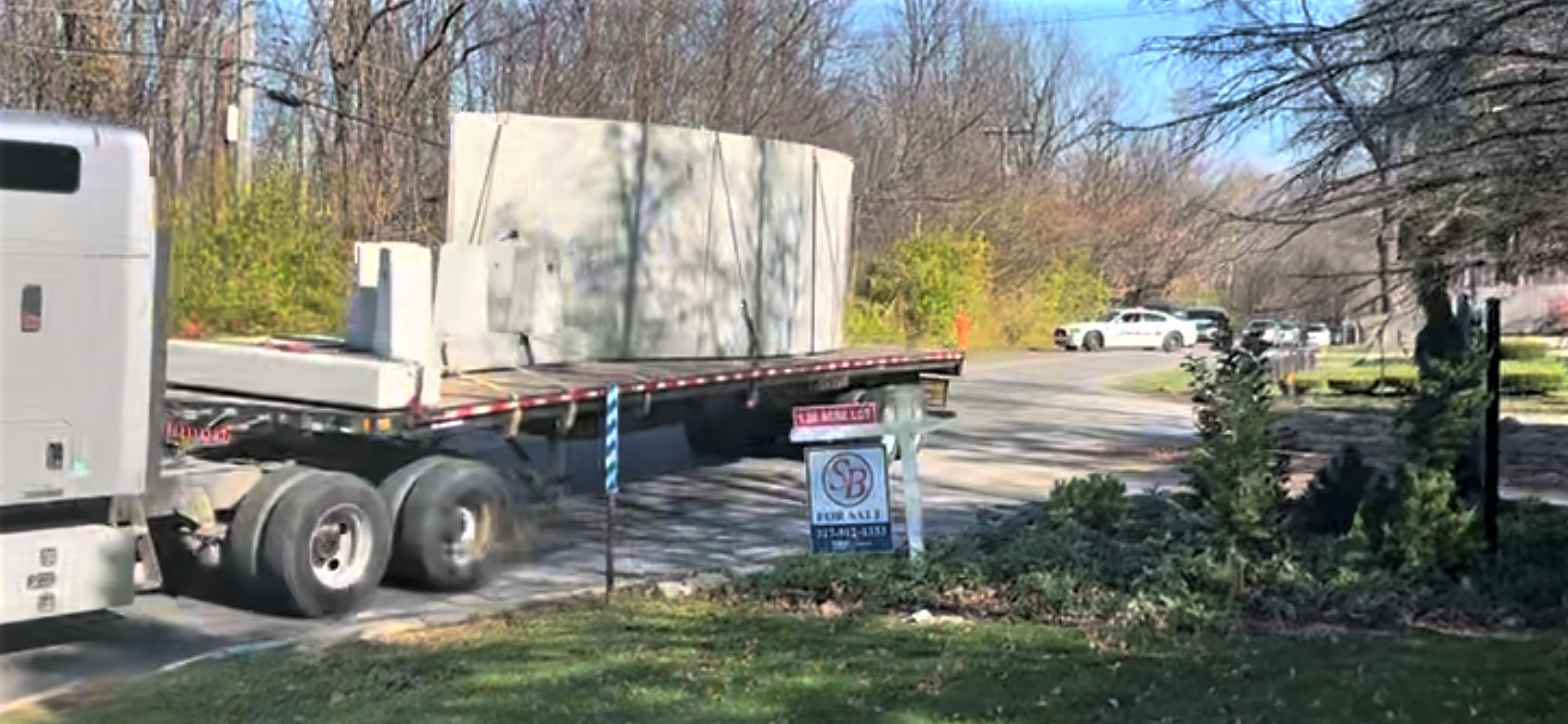

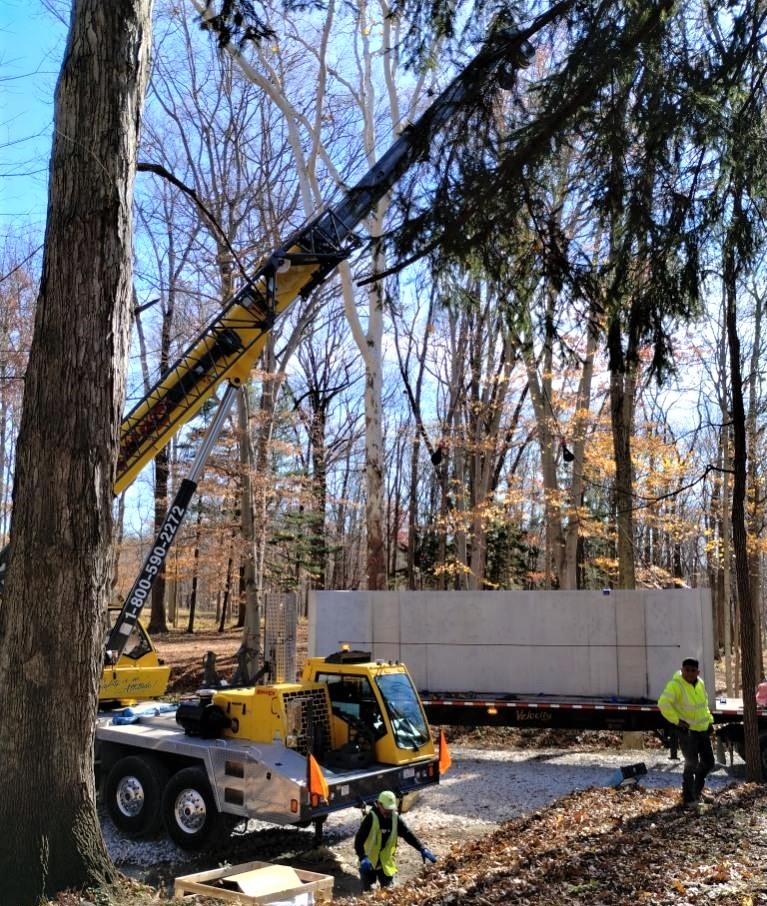

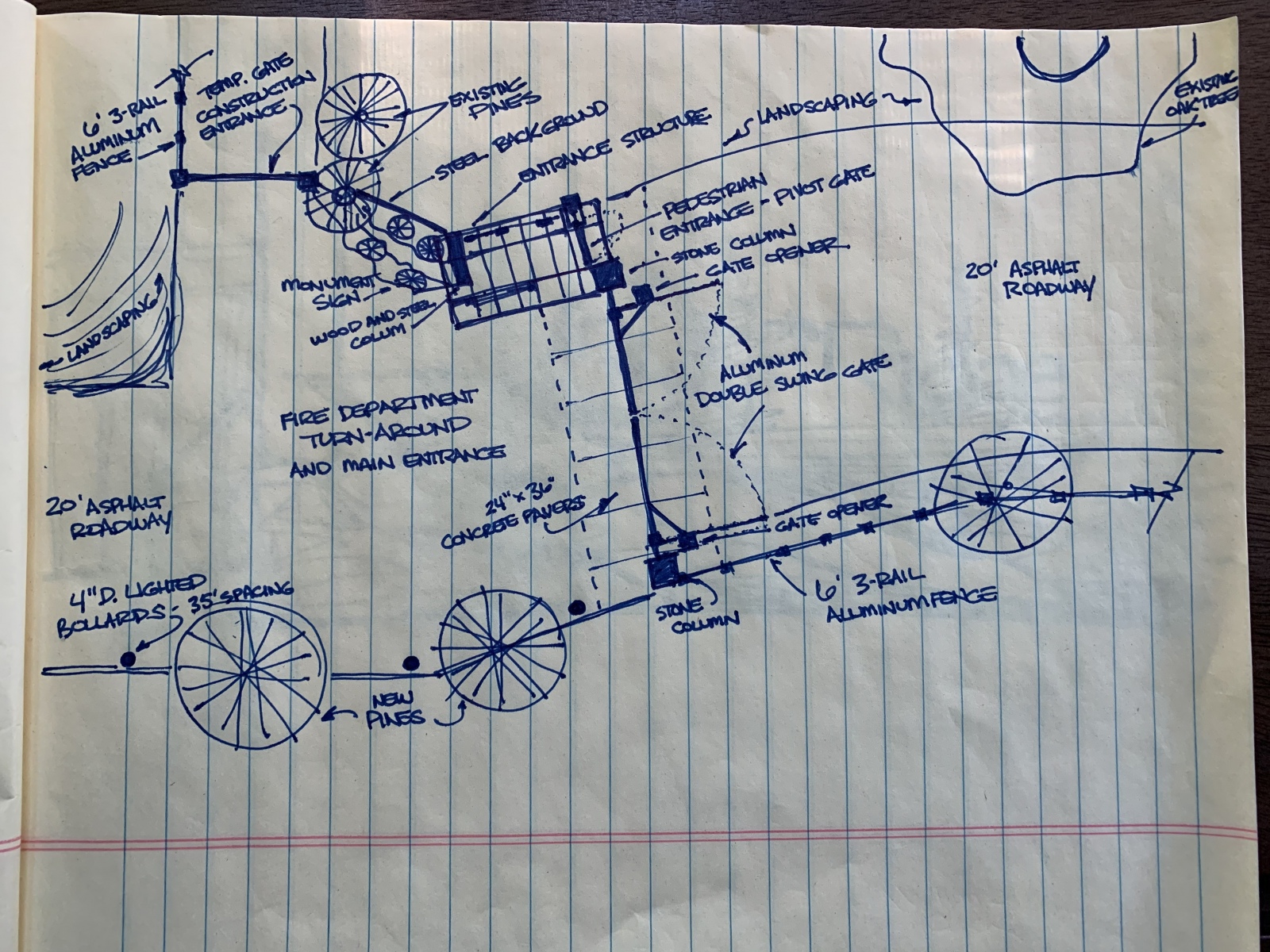

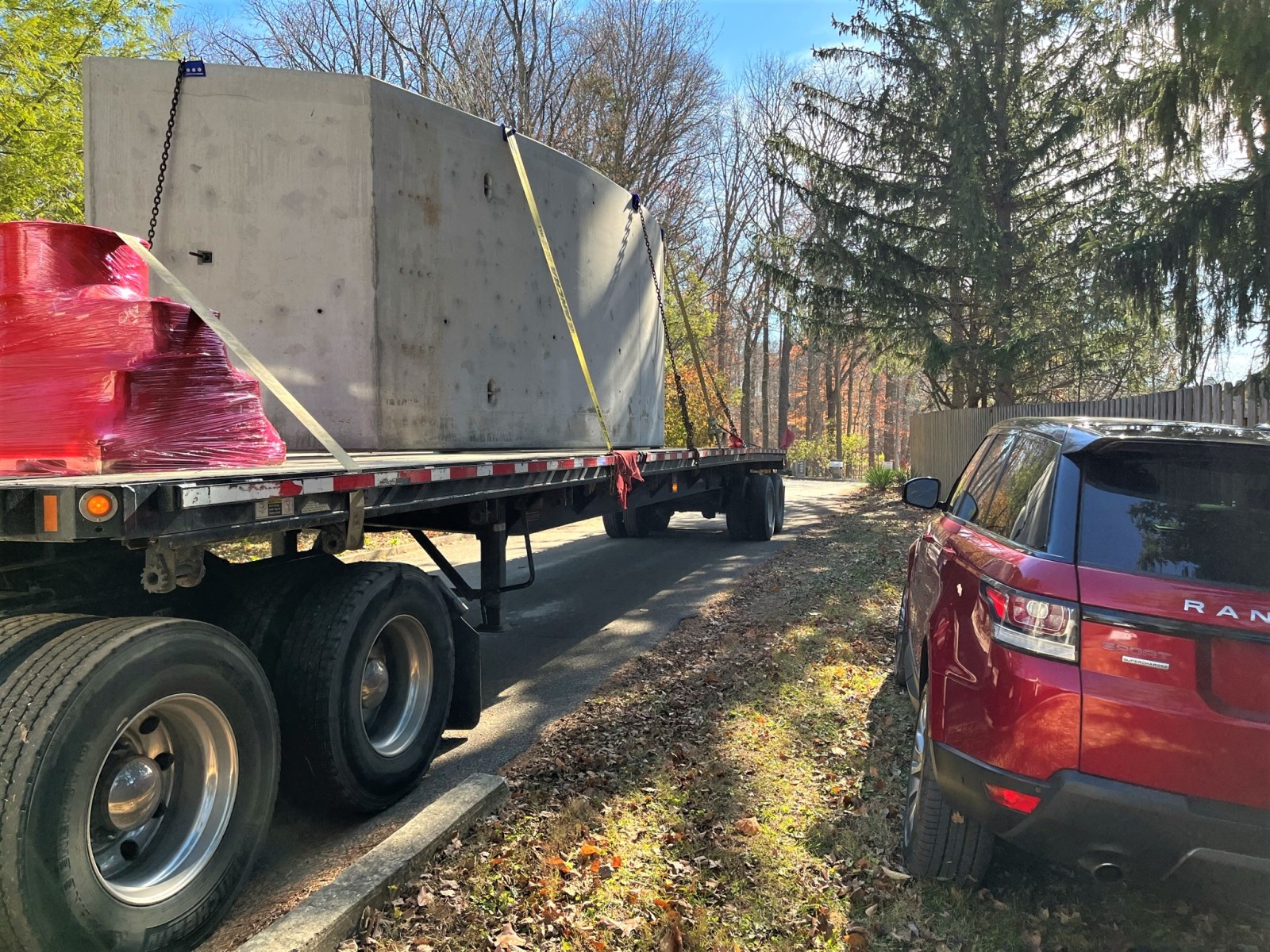

The new gatehouse, a prefabricated structure built by DropStructures, LTD., arrived at The Ridge on Williams Creek following its long journey from Canada. The building was craned into place atop the helical piers, marking a significant milestone in the entrance construction.
To establish a strong foundation for the new gatehouse at The Ridge on Williams Creek, helical piers were installed. These piers ensure stability and durability for the gatehouse structure, preparing the site for the next phase of construction.

It’s paving day! After four long years, over 740 tons of asphalt is laid down, compacted, and rolled smooth with hydraulic rollers. This monumental milestone sets the stage for the next chapter of The Ridge’s development.

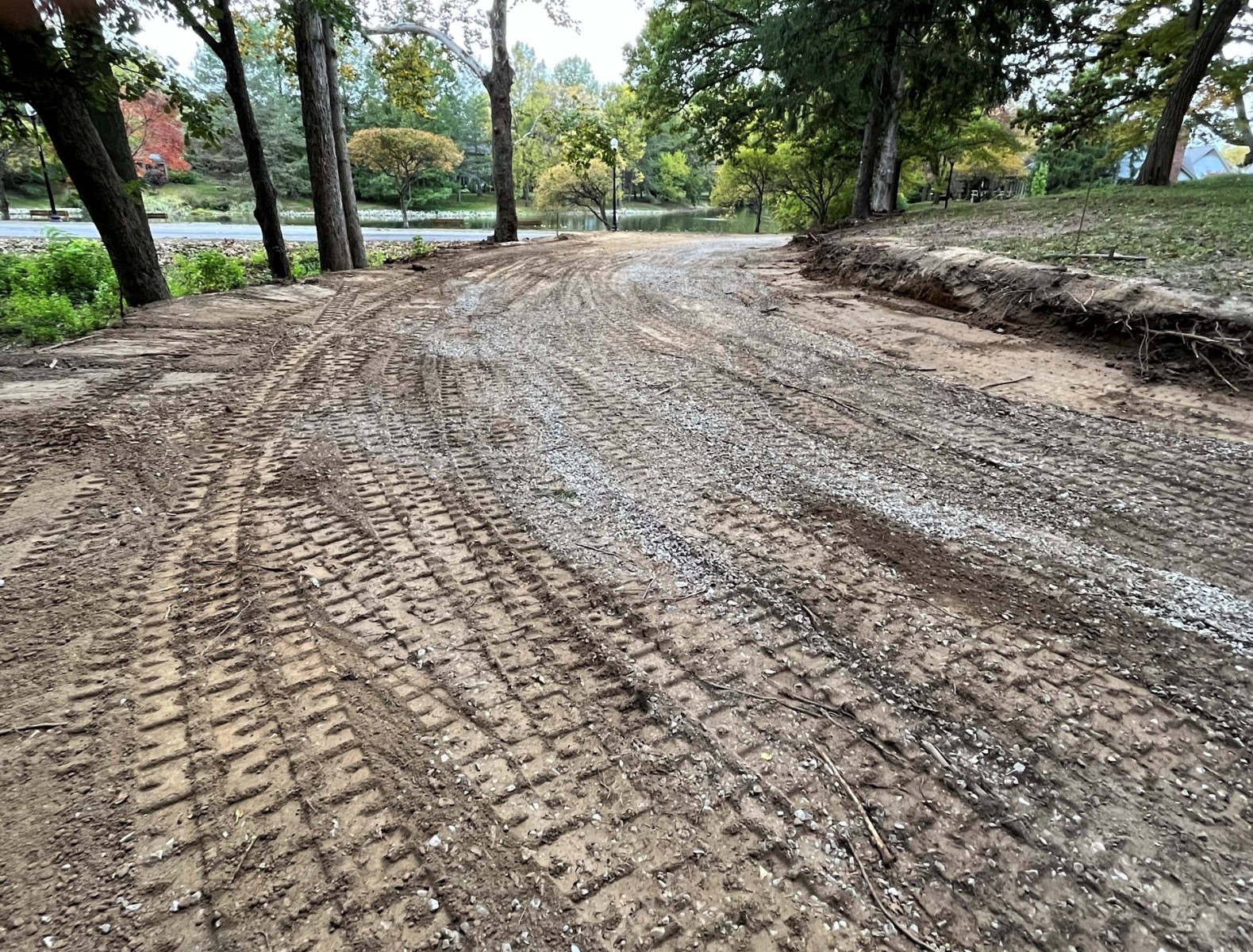

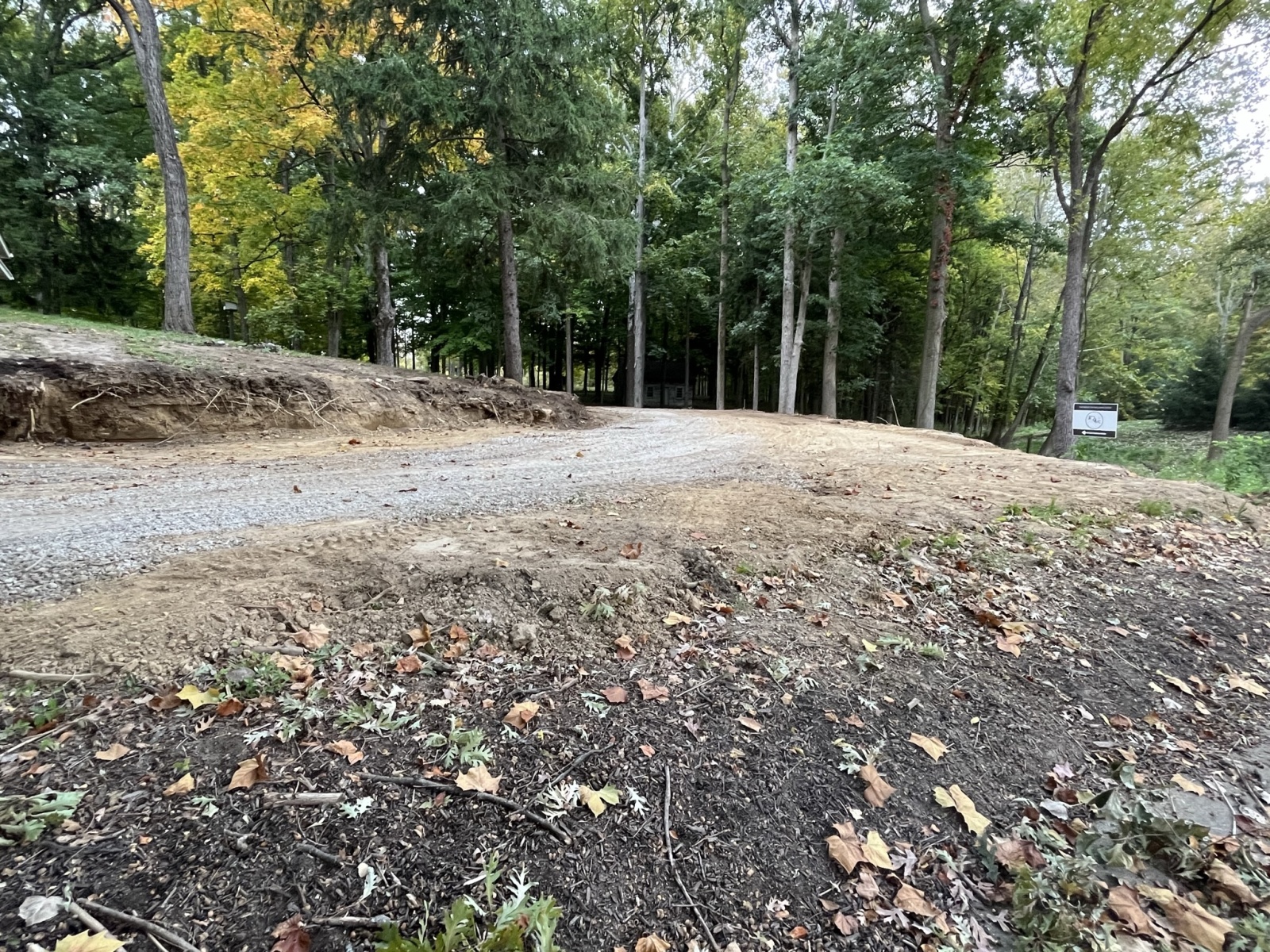

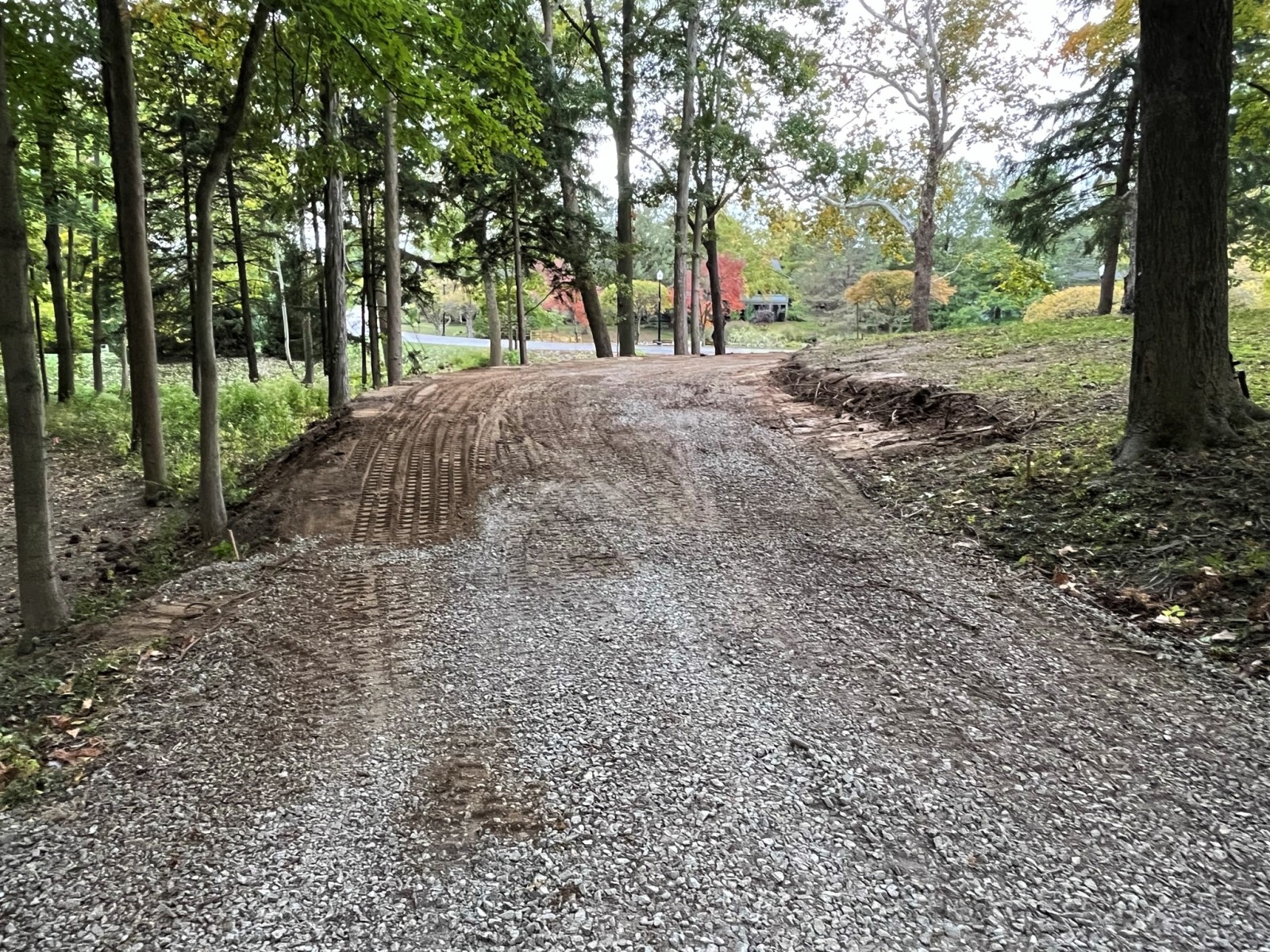

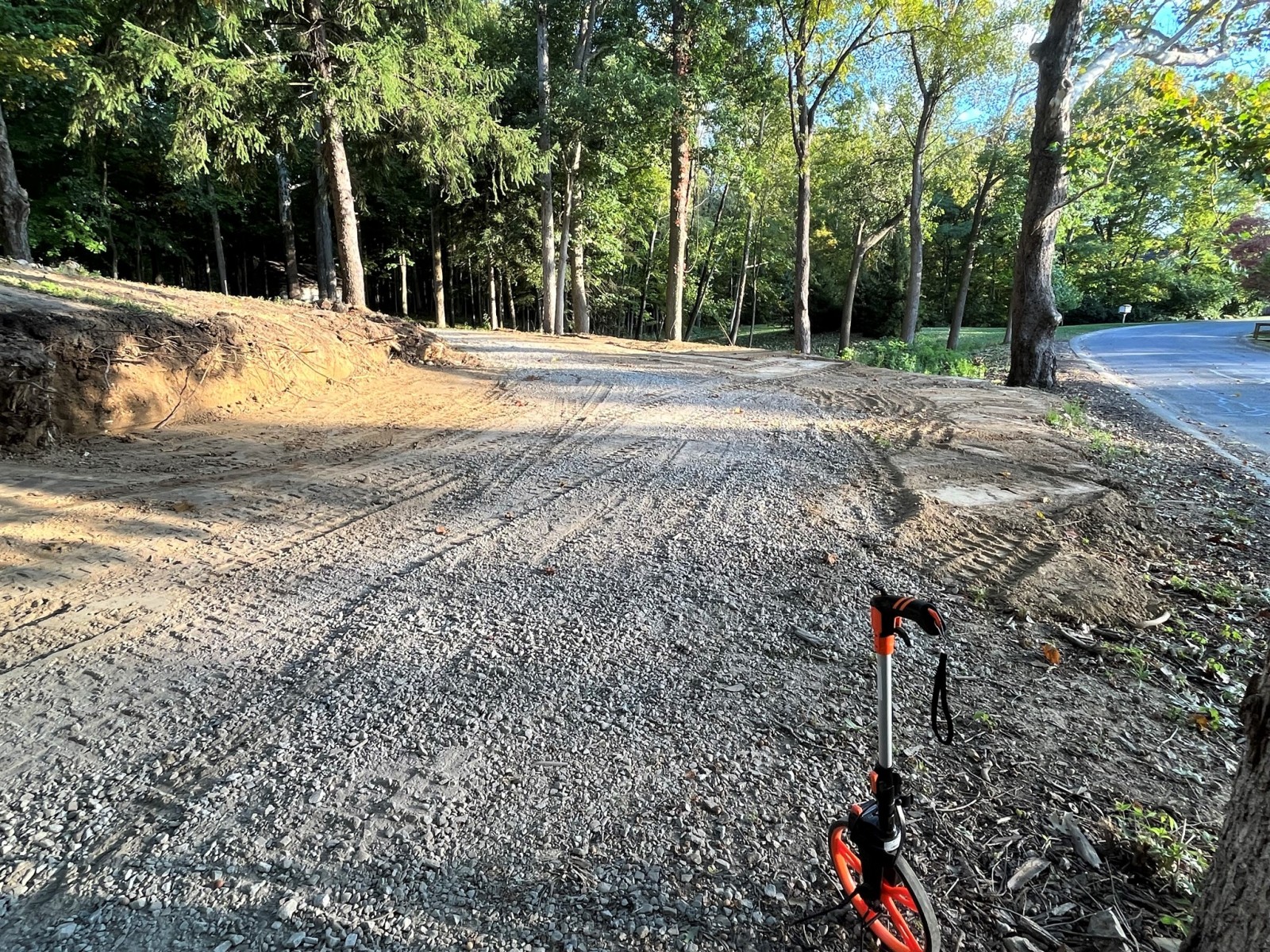

Gravel work begins on the roadway. A total of 1,720 tons of gravel (86 tri-axle loads) is tailgated into place, graded to the correct angles, and compacted, laying the groundwork for the future road.
The final dirt-work preparations are complete, and the stakes are set for gravel installation. This marks a key step in creating the foundation for The Ridge on Williams Creek’s roadway system.
Proof-Roll day has finally arrived! This is the process of testing the subgrade before gravel and asphalt can be put down for the new roadway.

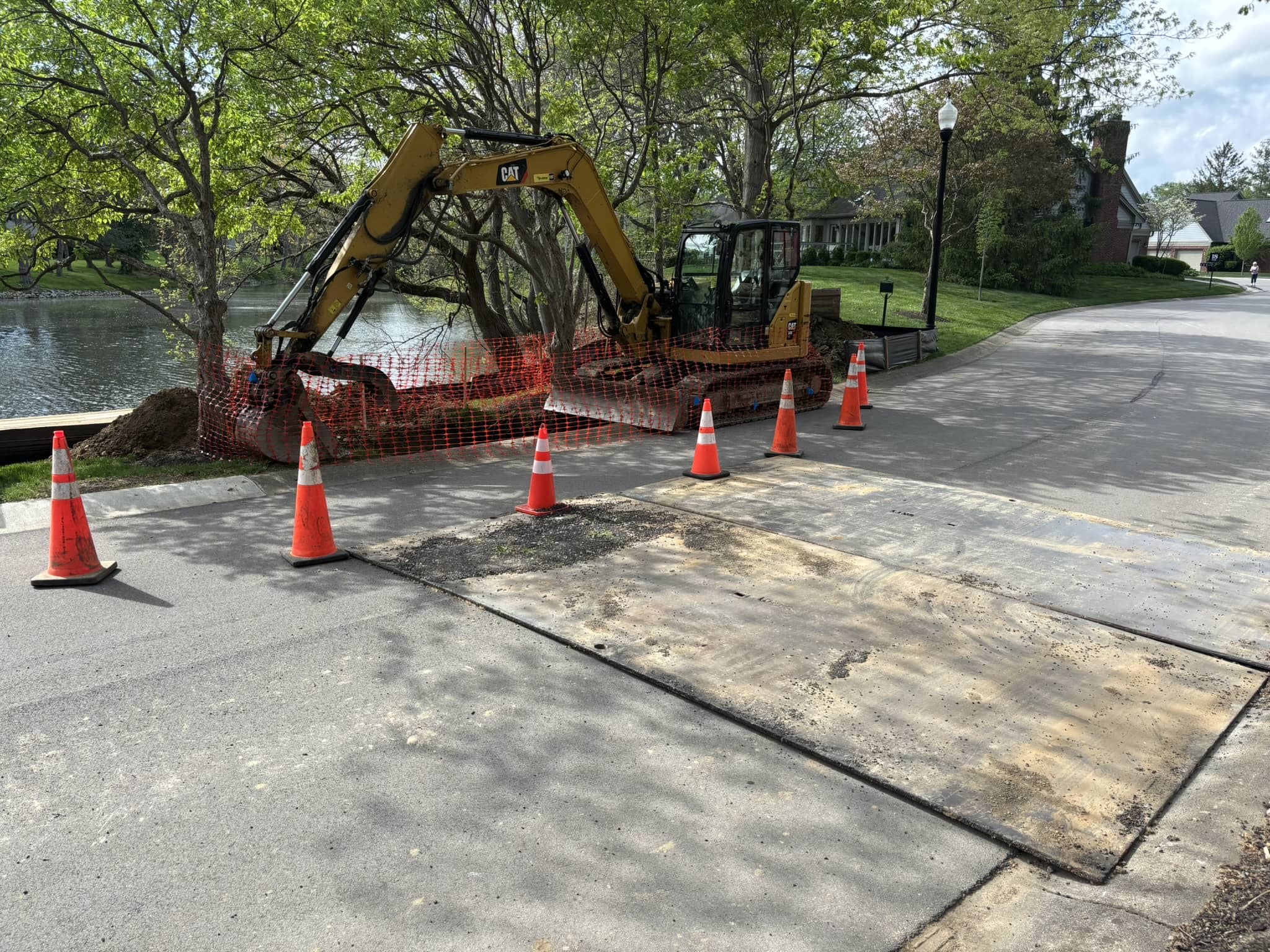

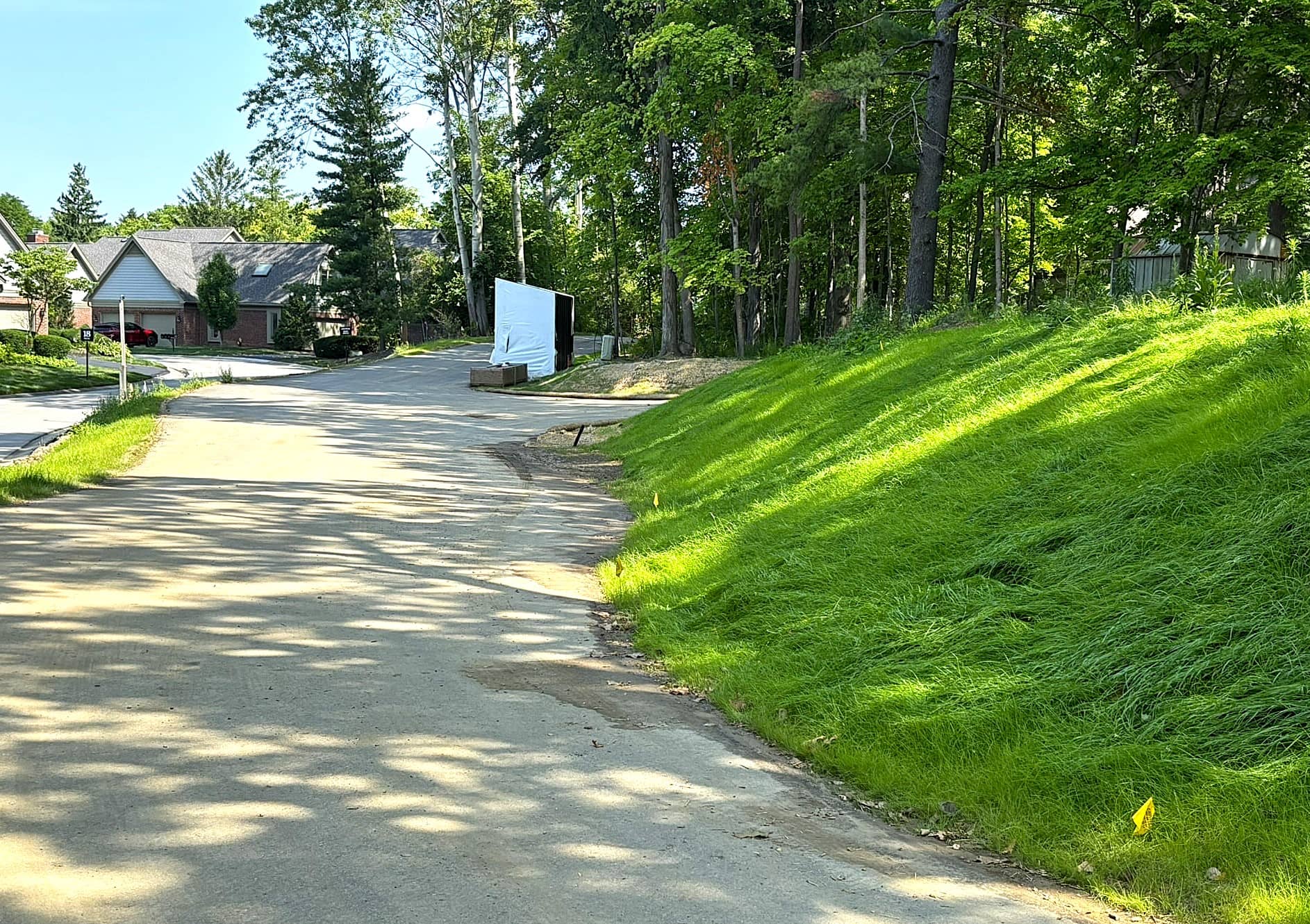

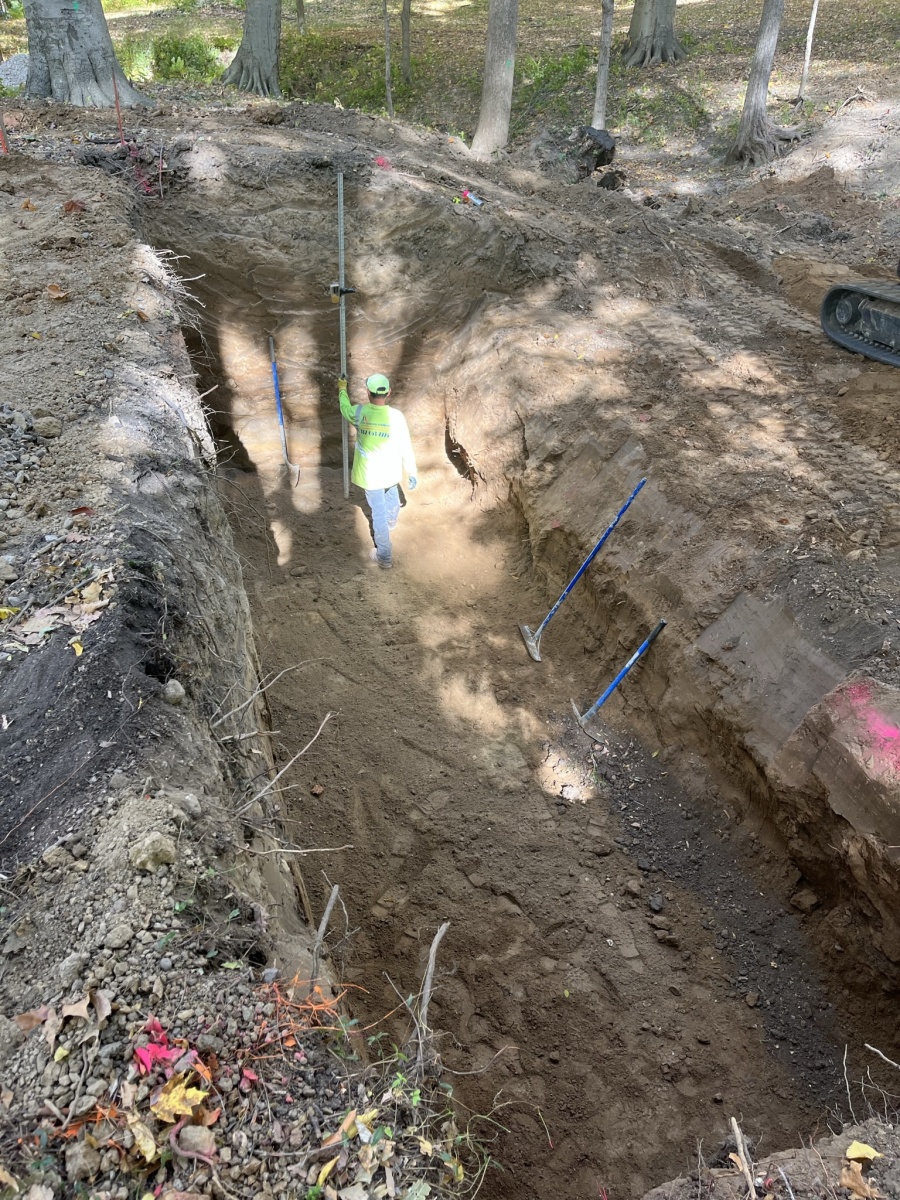

Demo work and installation of the storm sewer continues at the front entrance. Everybody just loves road construction! 🙂
The final stage of demolition has begun at the entrance of the subdivision!
Construction has officially started on the first home at The Ridge on Williams Creek! Neal and Mandy celebrated the groundbreaking of their new home, affectionately named ‘Wonder Nest.’ The couple even designed a custom shovel featuring their house logo, with Wonder Bread dots representing eggs in a nest.
Stay tuned for more exciting updates as construction progresses!
June 13th – “Our sanitary sewer is tied into the city’s lift station. Now we have to wait for 30 days while the city conducts a mandatory pressure test, as apparently contaminating the Indianapolis water supply would be “bad”.
We Have Passed Our 3rd Pre-Construction Meeting with the City Inspectors, and Are Given the Go-Ahead to Proceed with Installation.

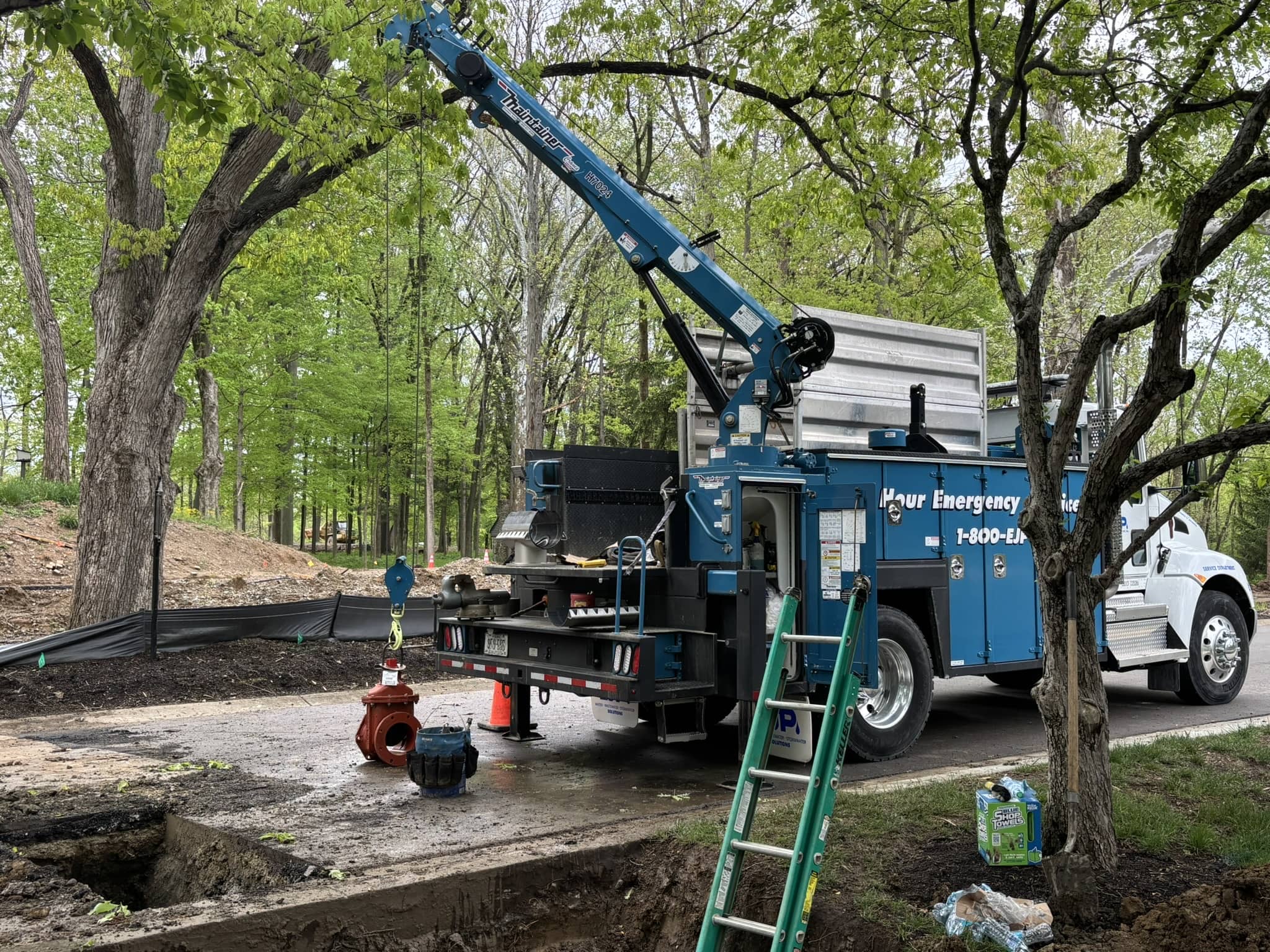

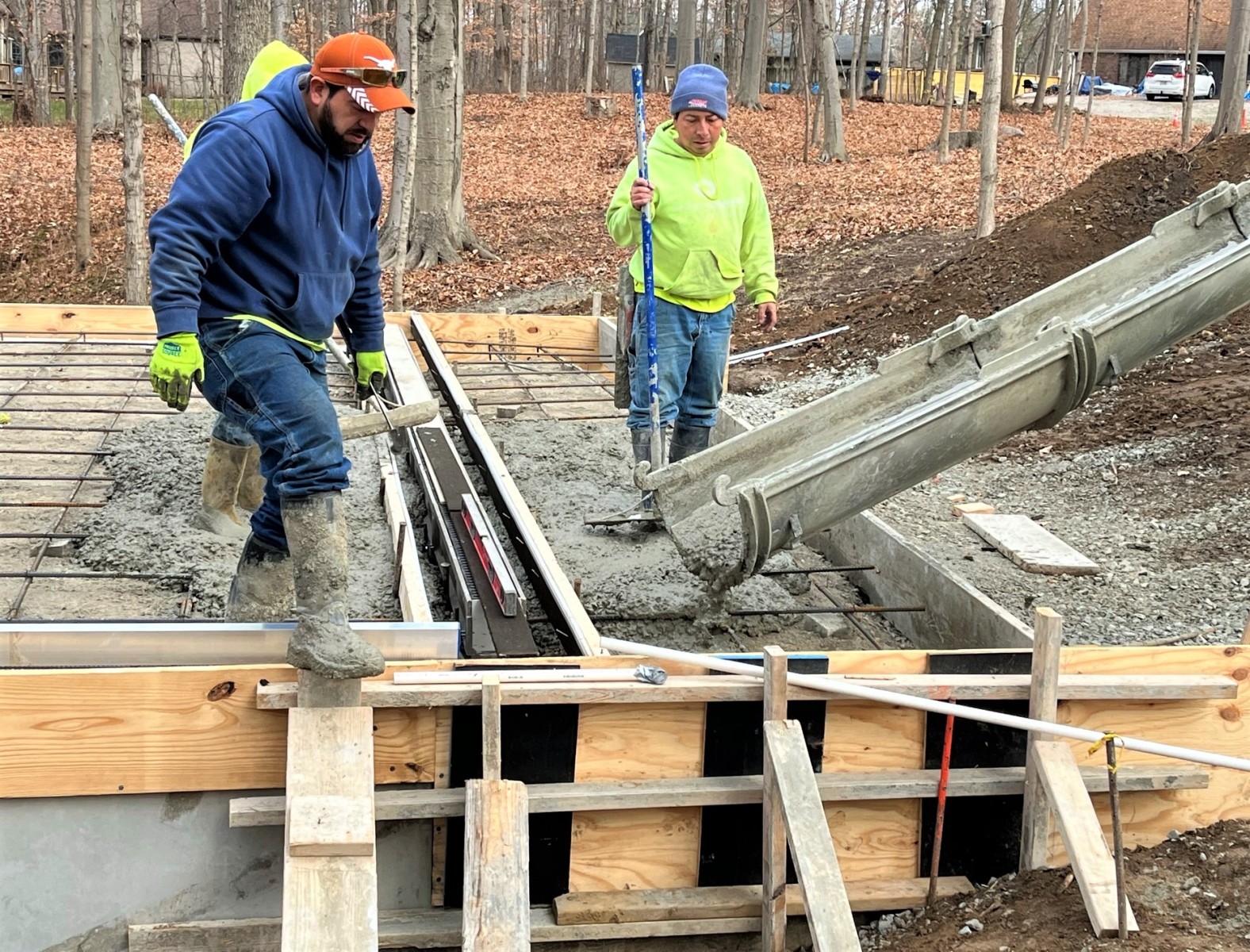

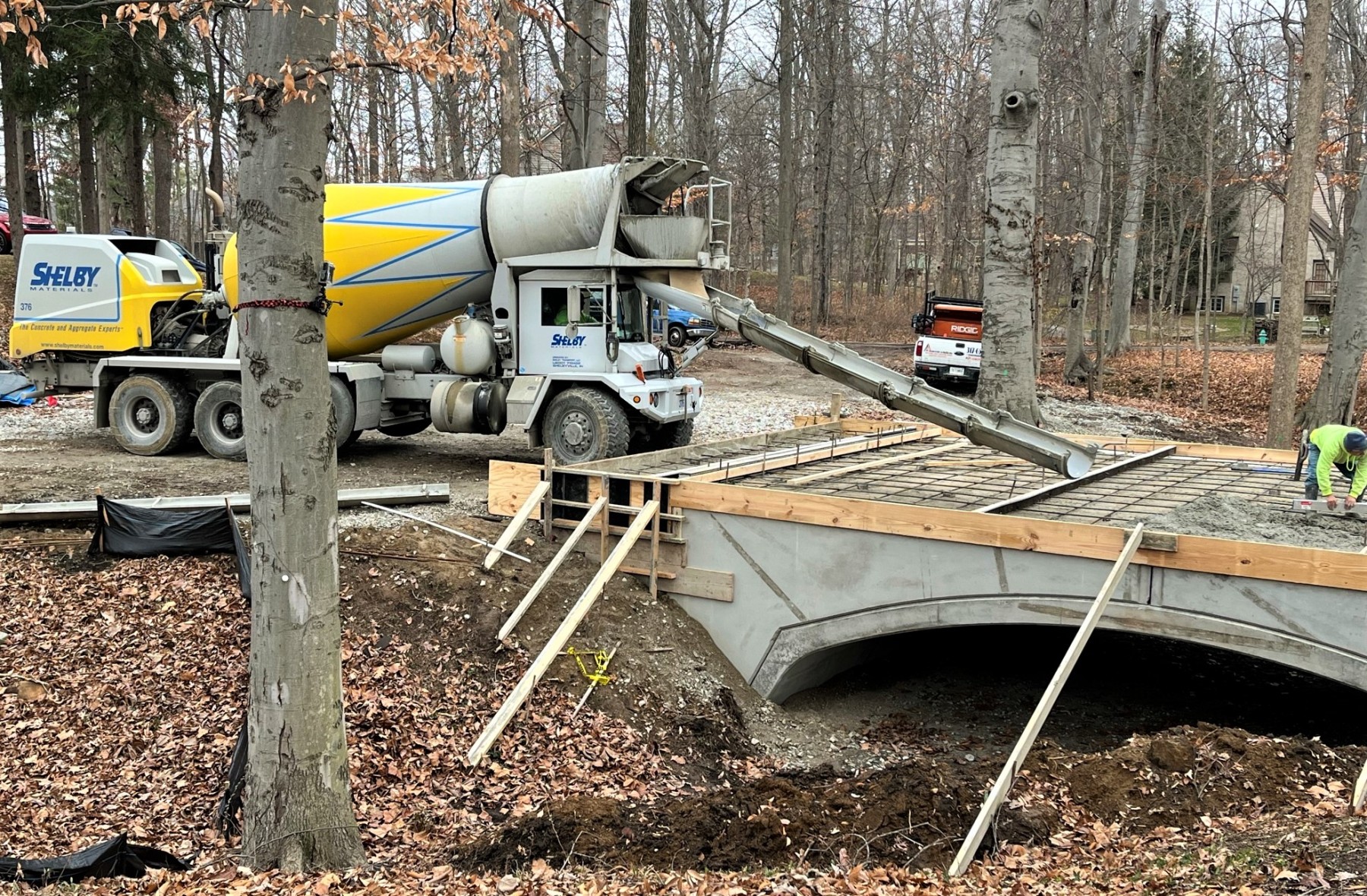

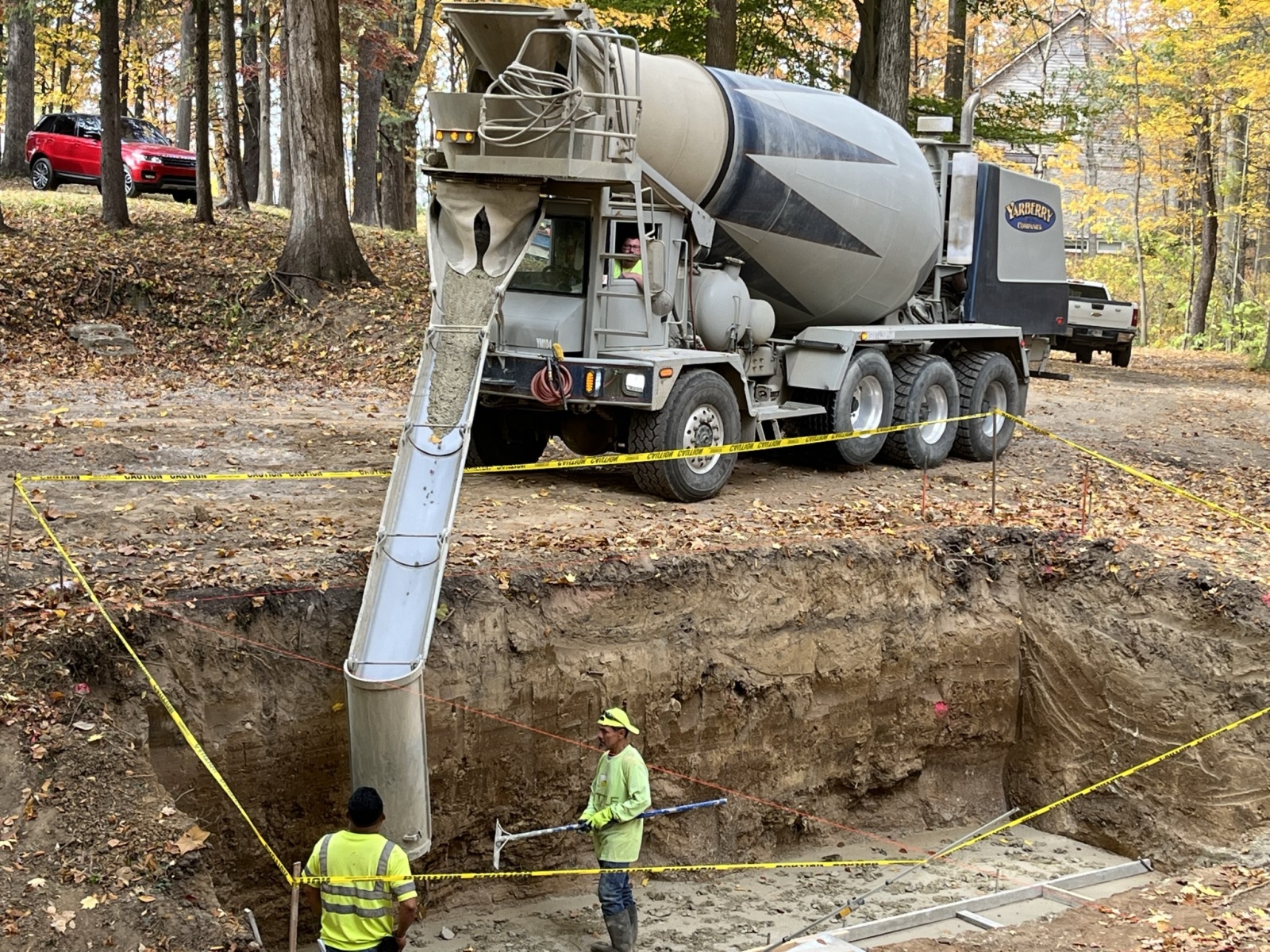

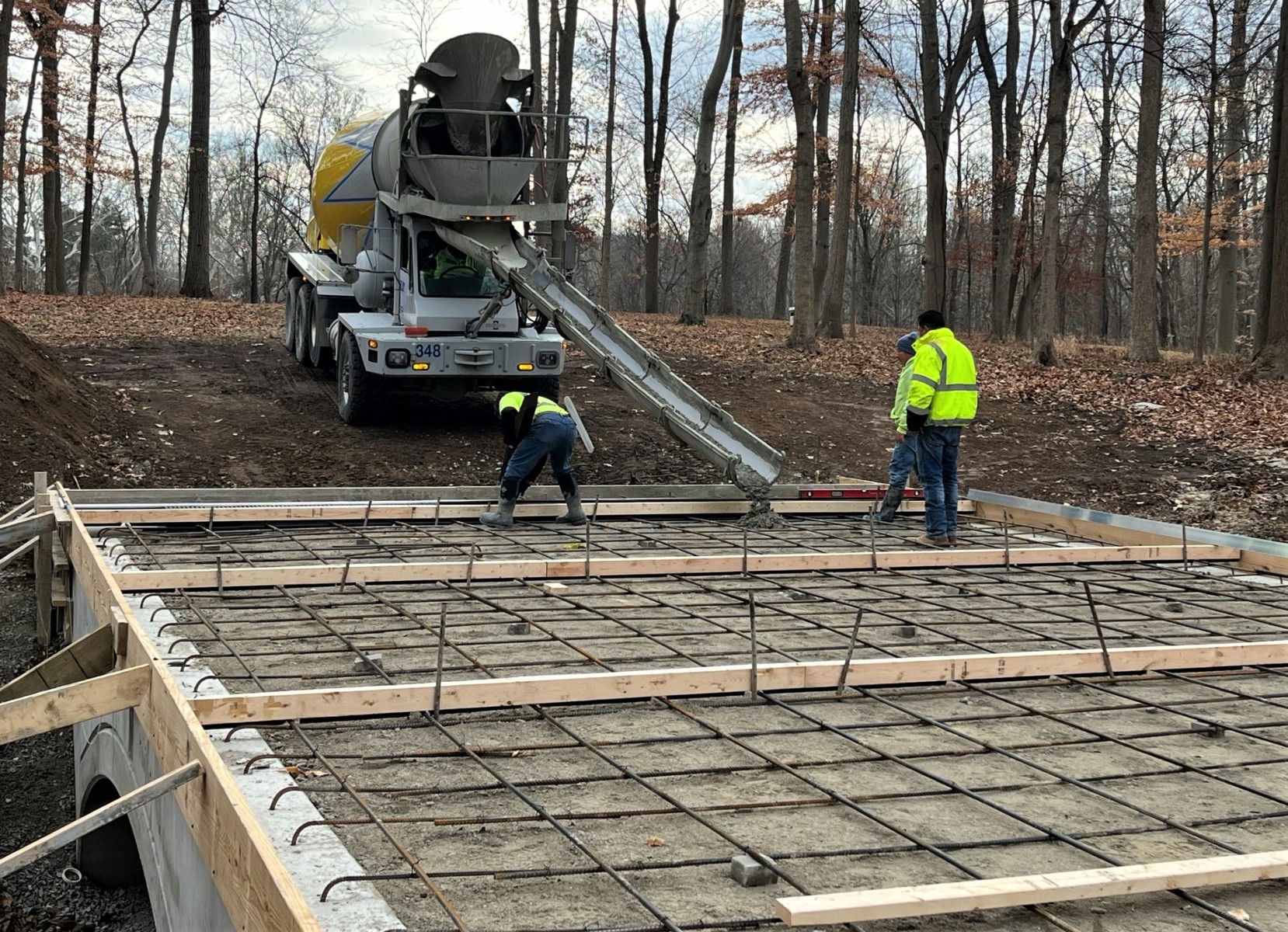

Work continues on, and concrete arrives for the storm sewers. 🏗️🌧️
Construction begins on one of three major storm-water drainage pipes.

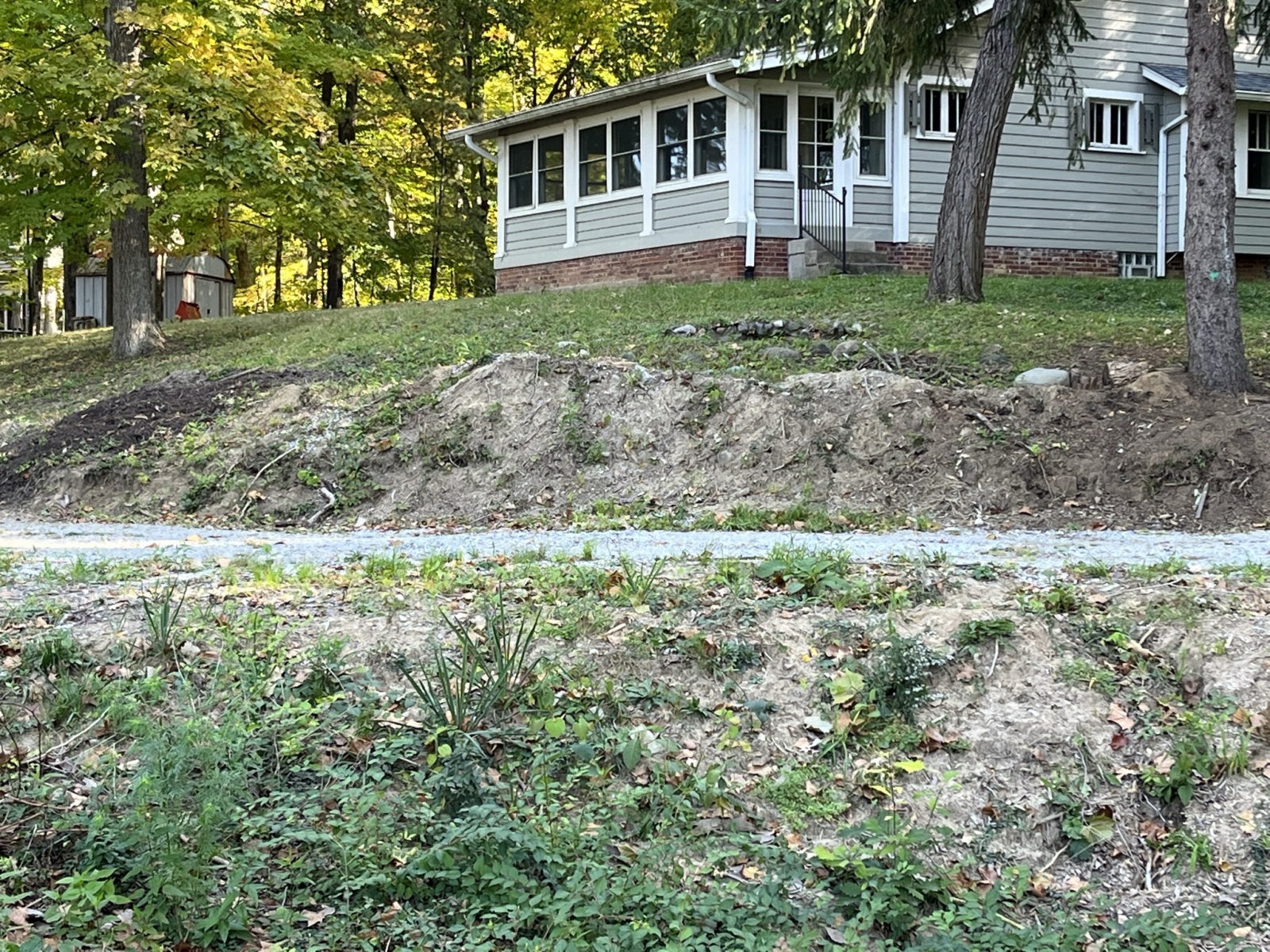

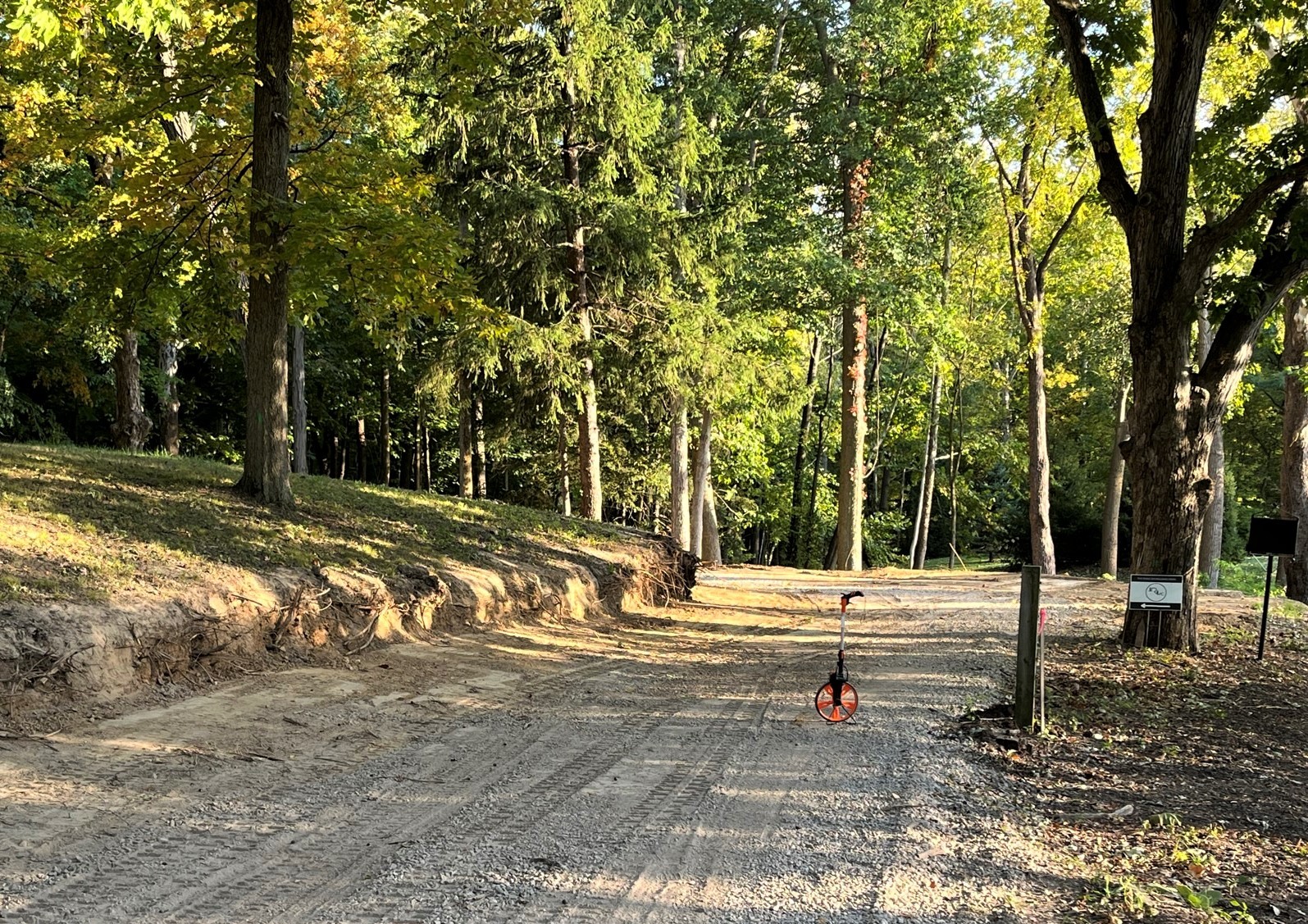

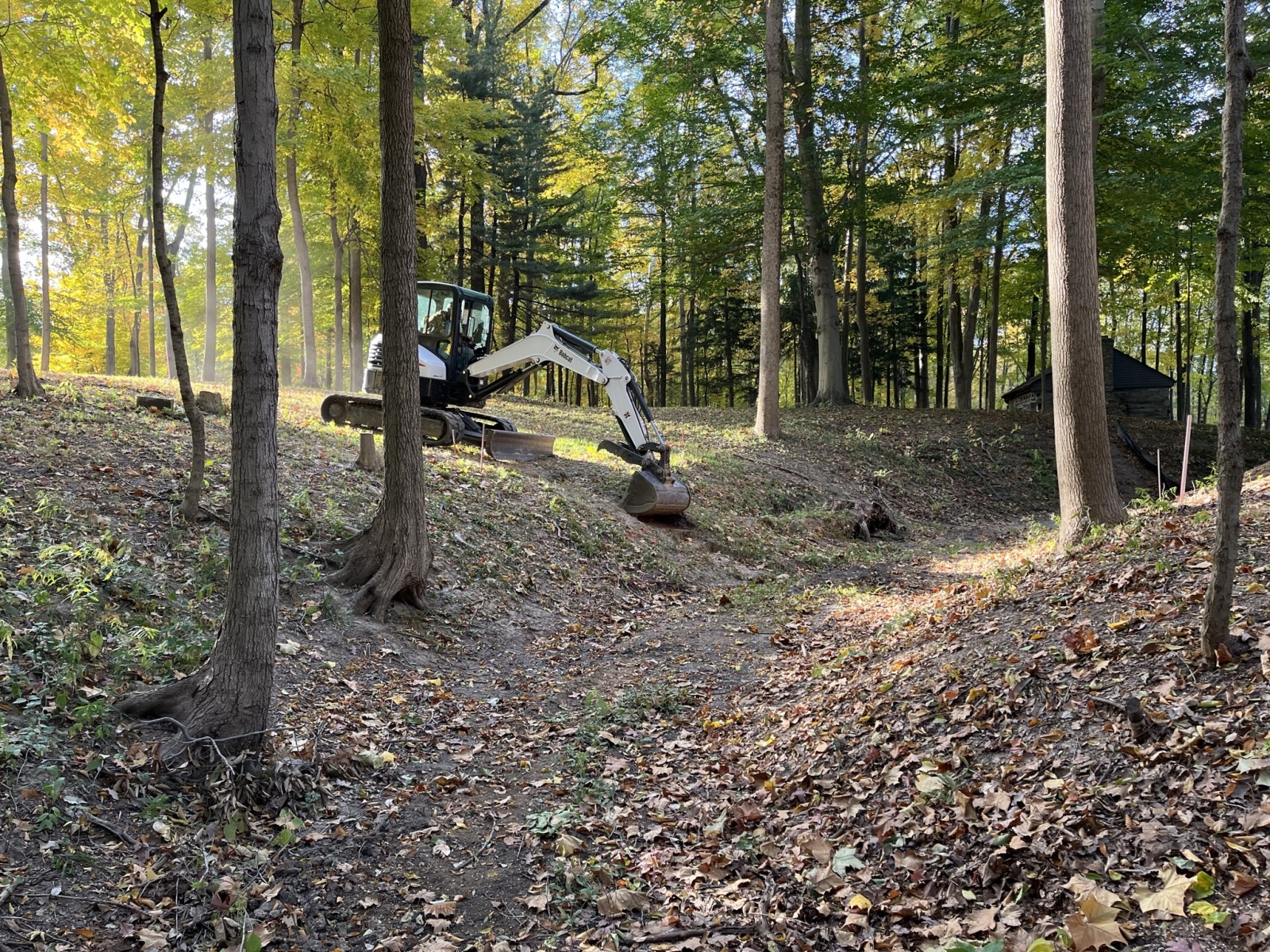

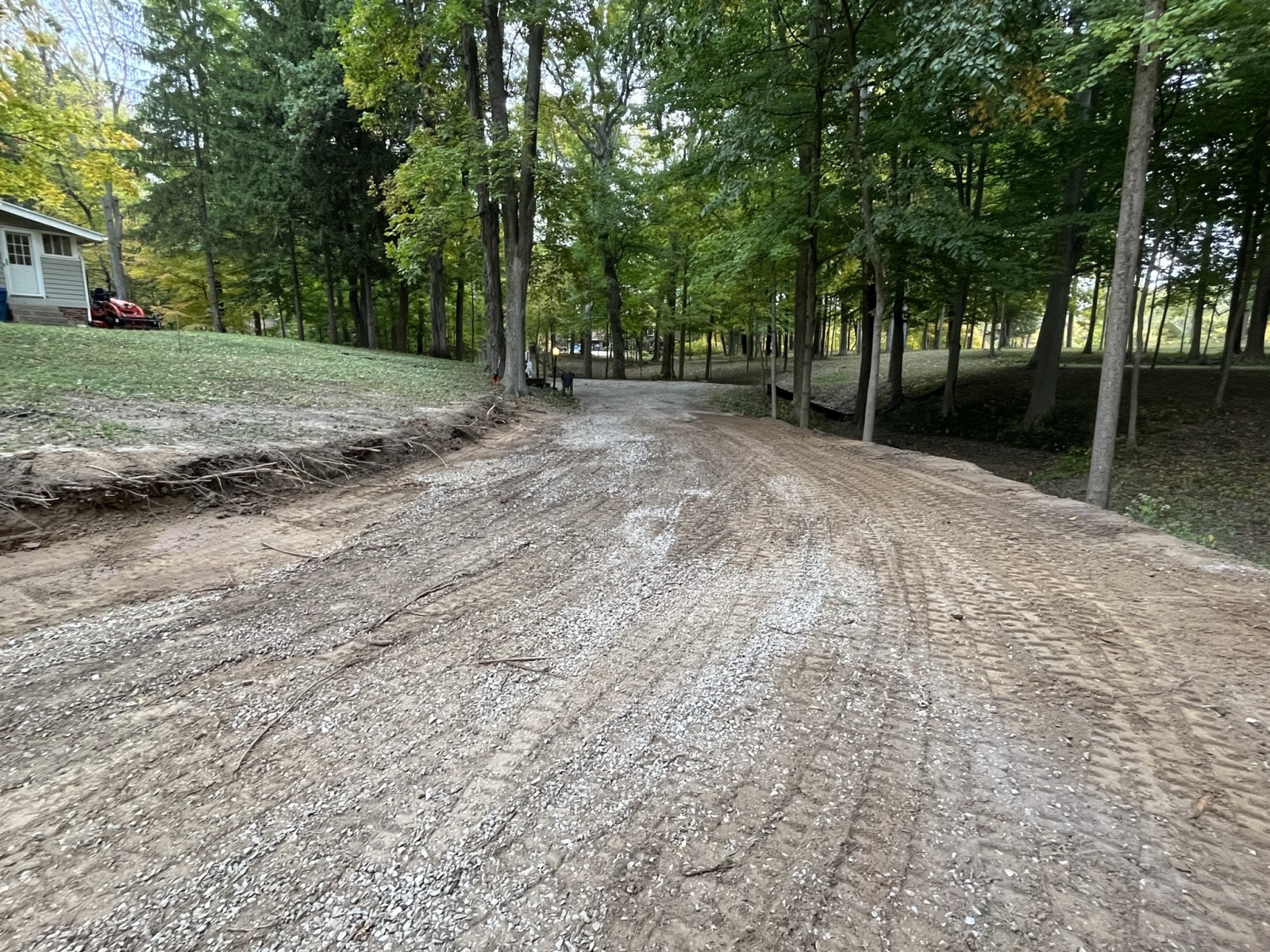

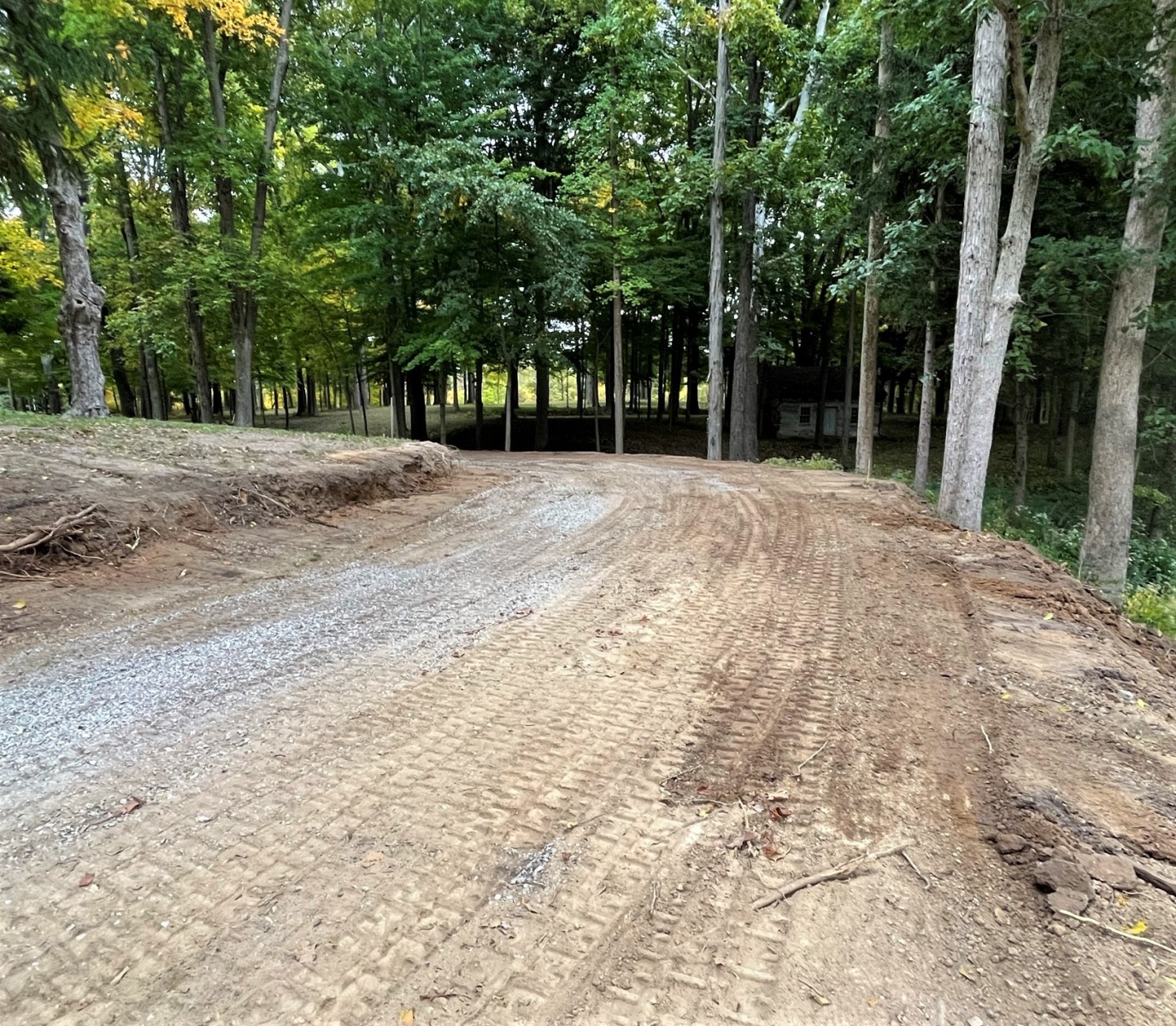

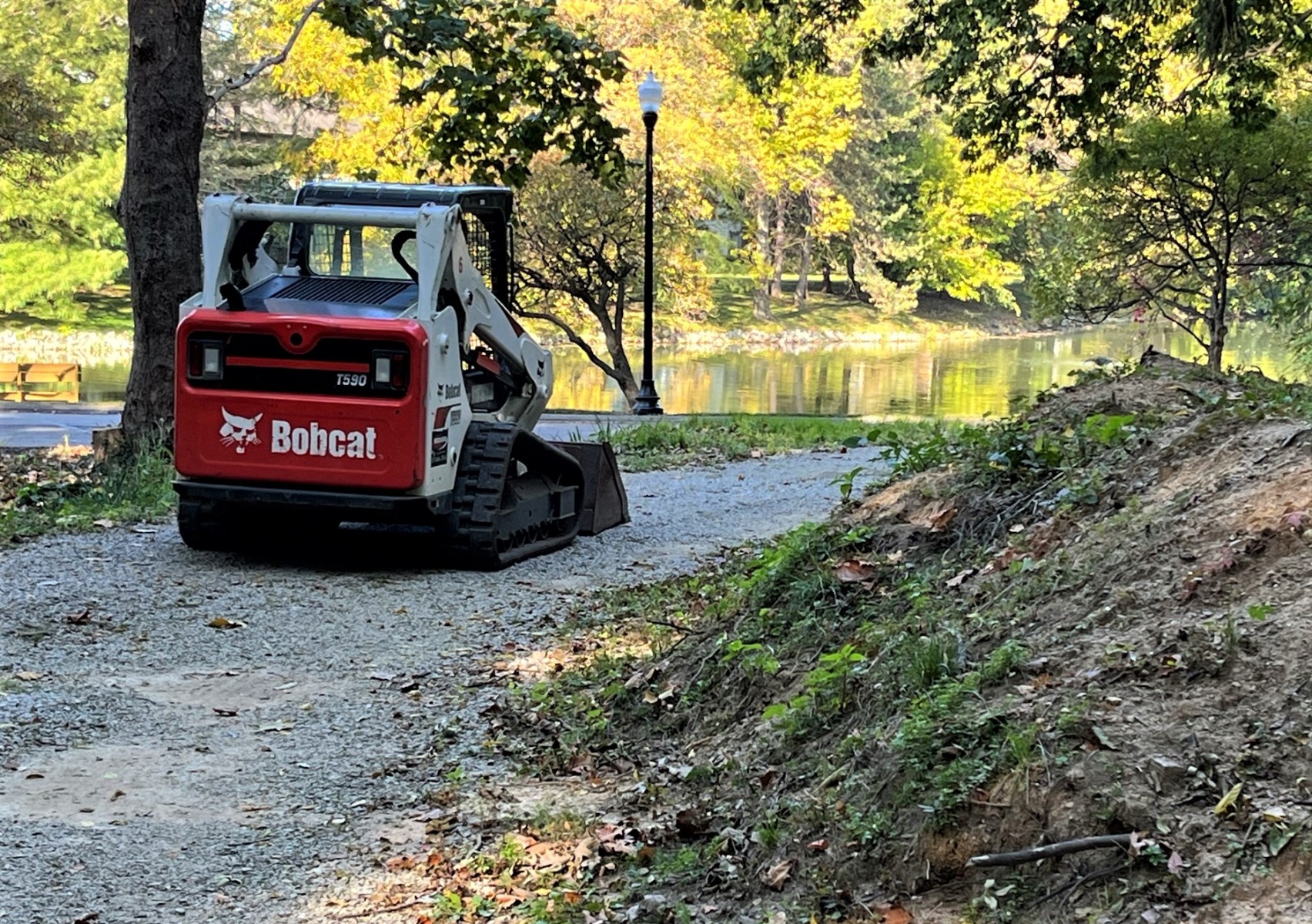

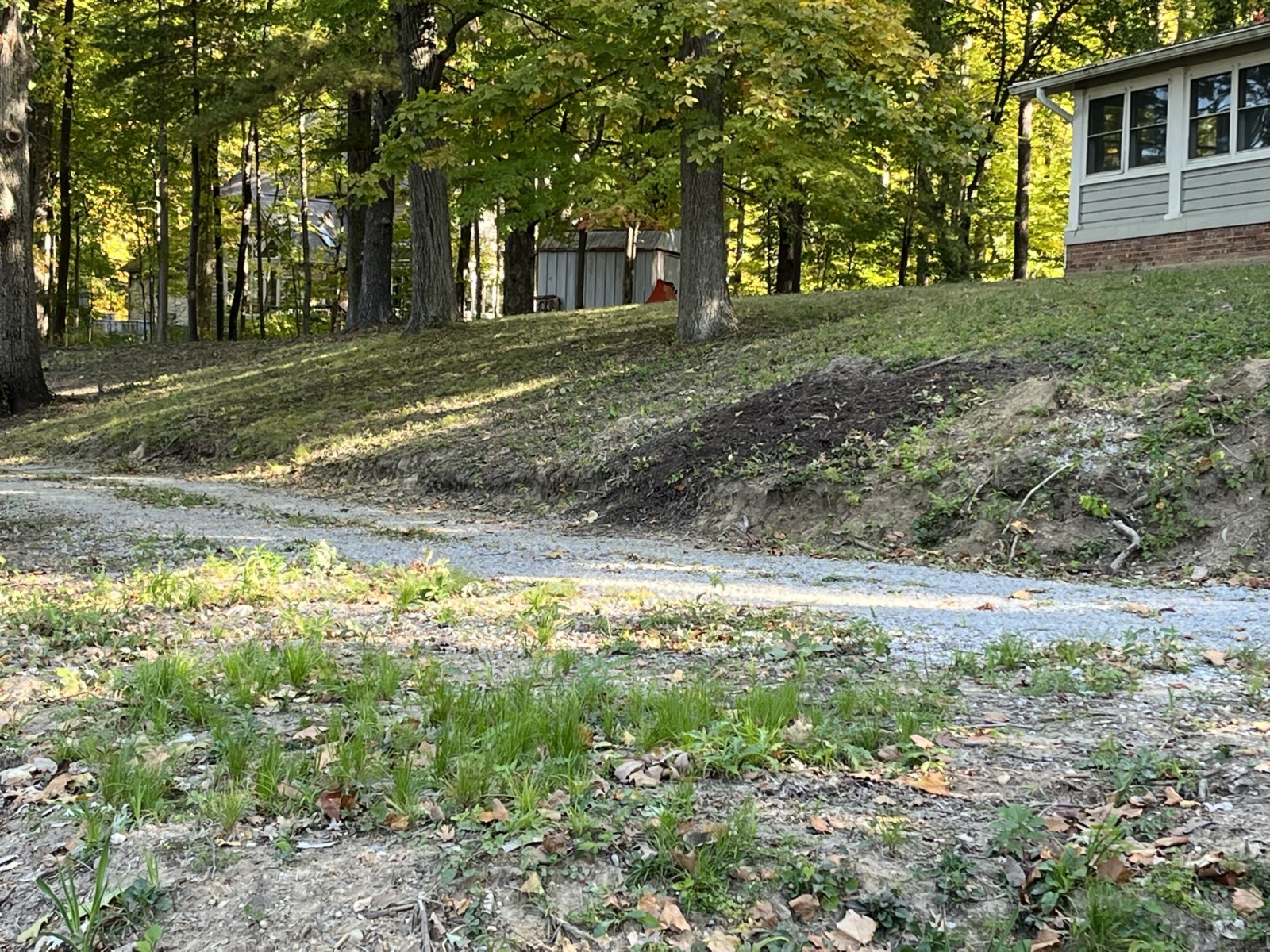

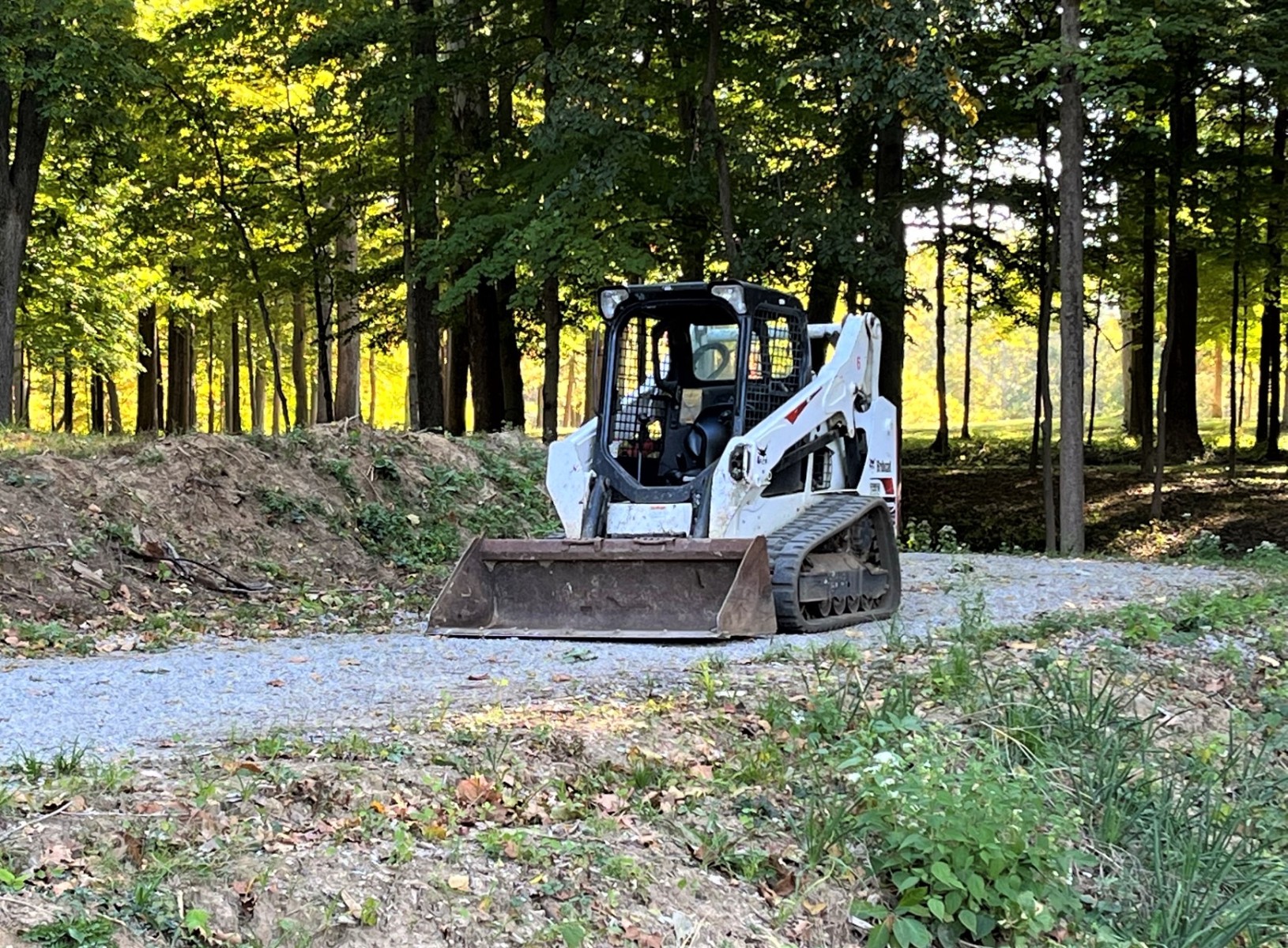

Dirt work continues on the old road (now completely removed) and the new swale alongside of it.

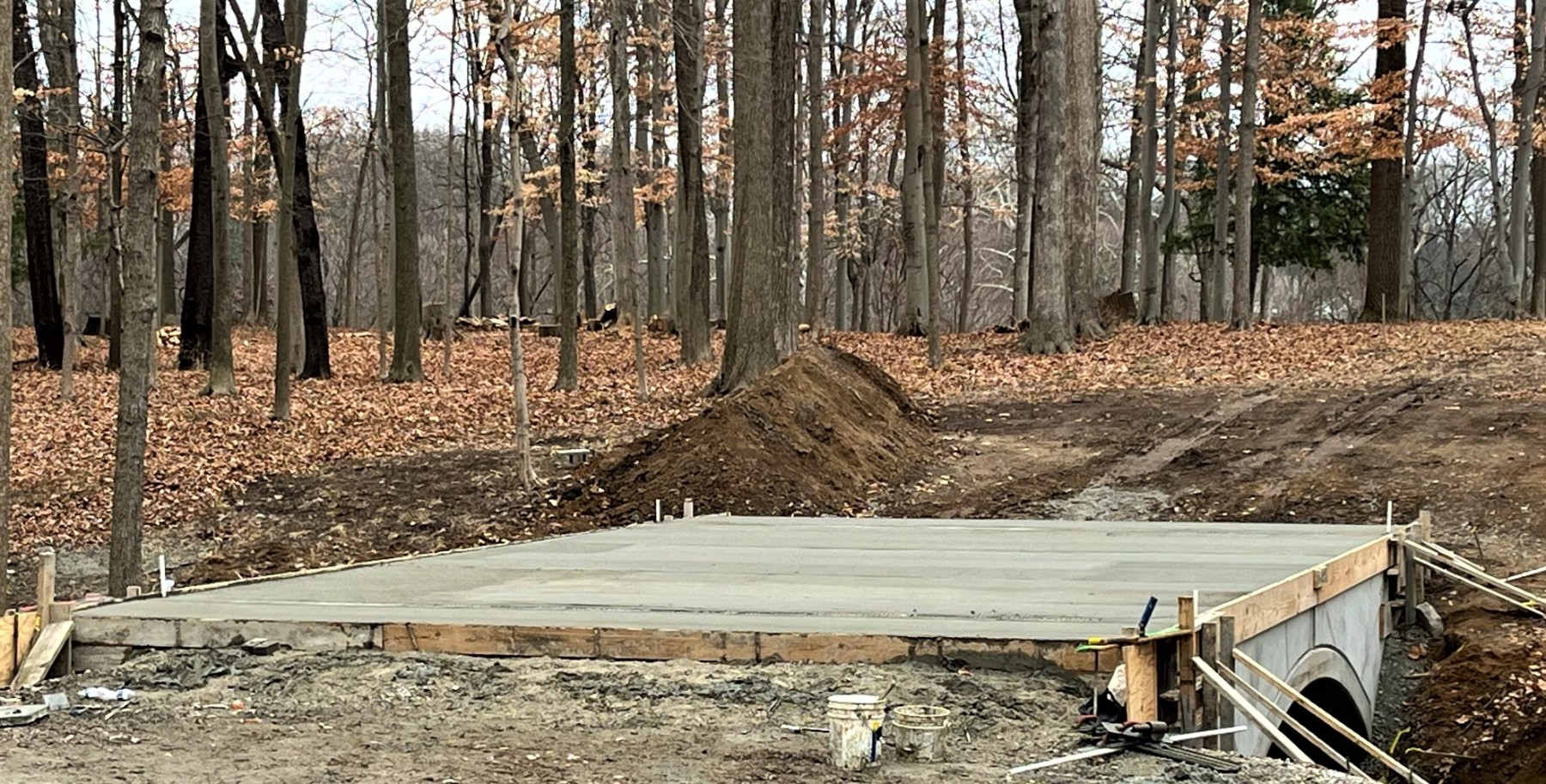

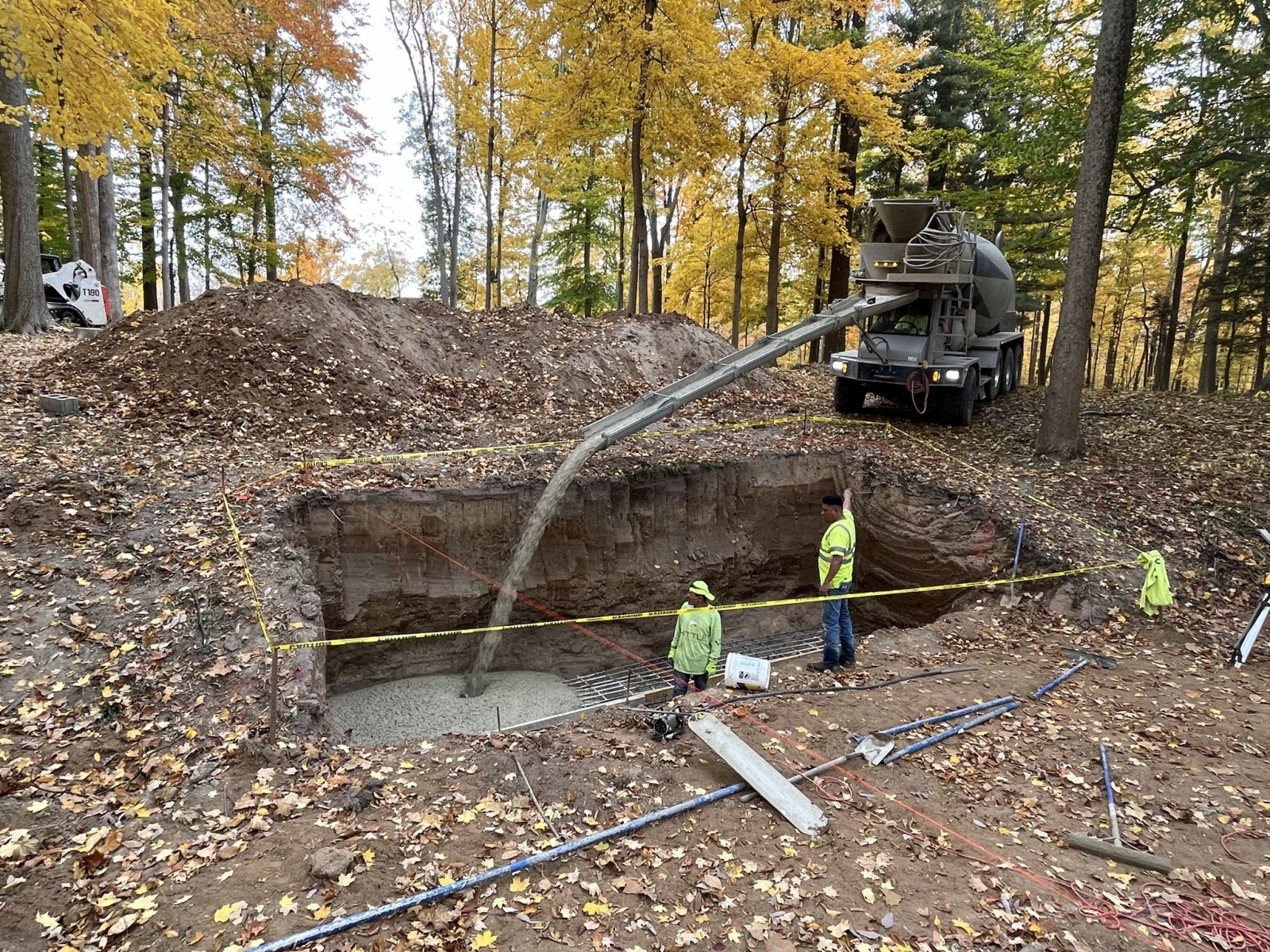

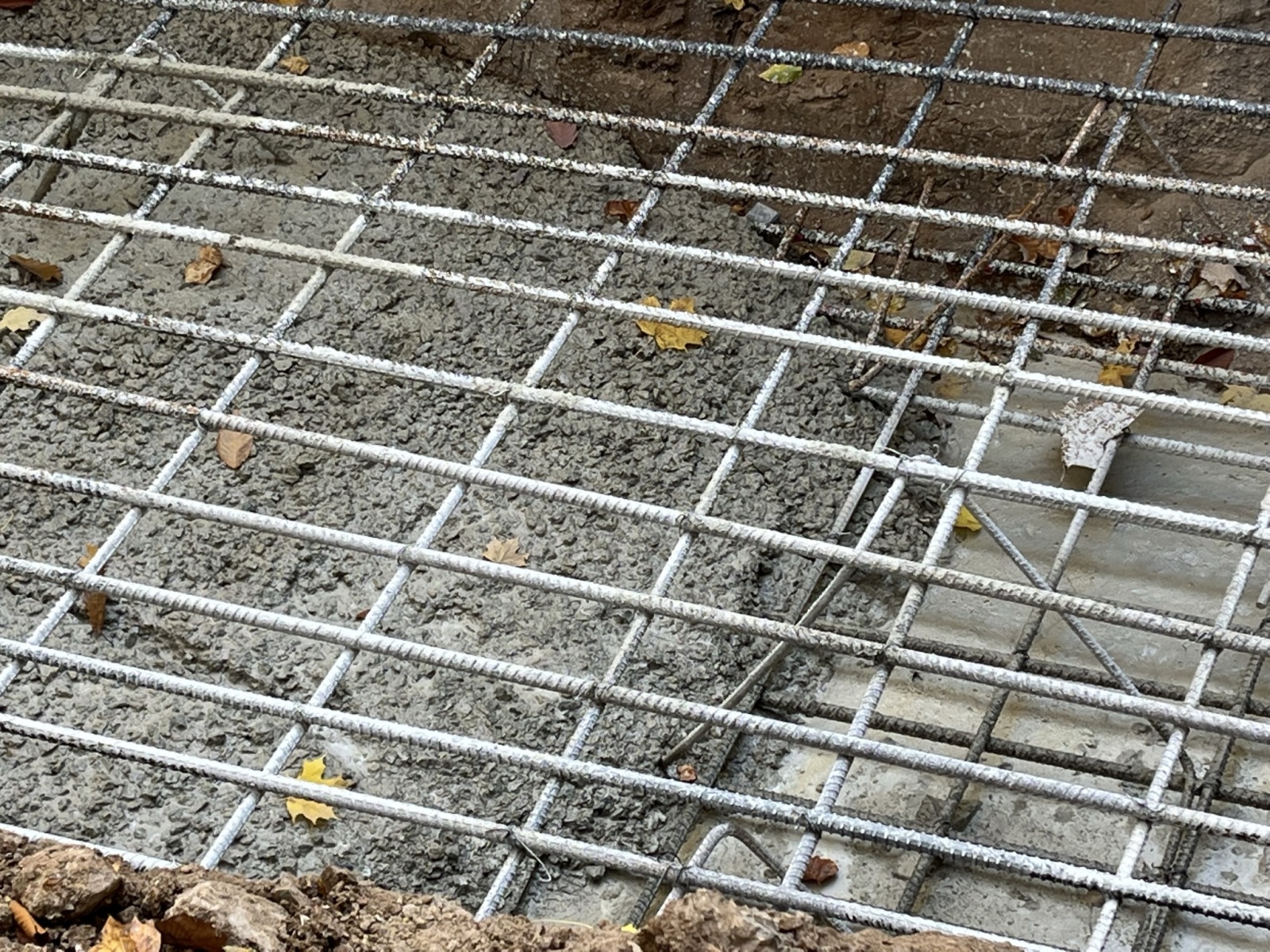

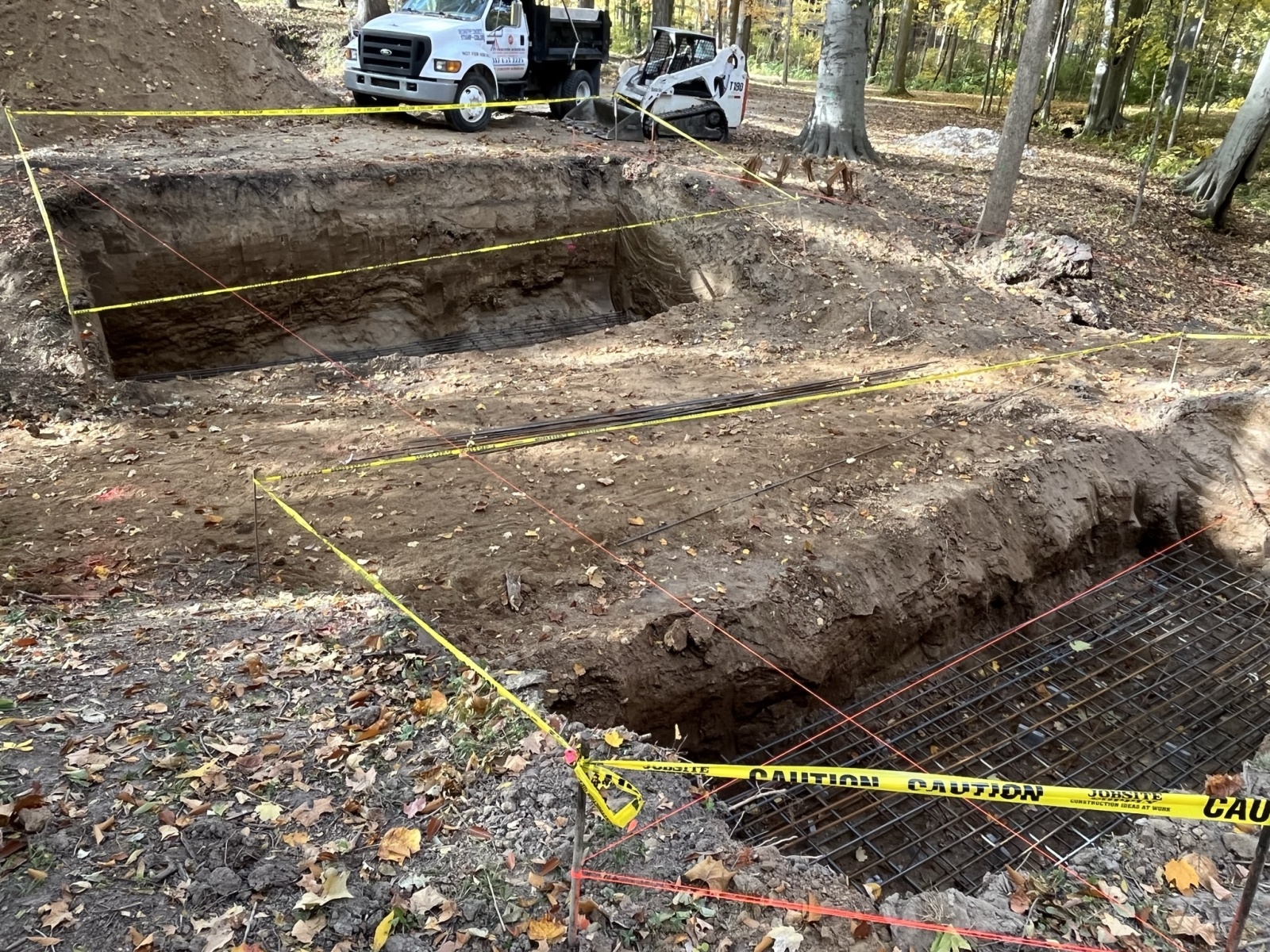

Concrete structures arrive for installation of the new storm drains.
No turning back (literally) now, as the original roadway is removed from existence.

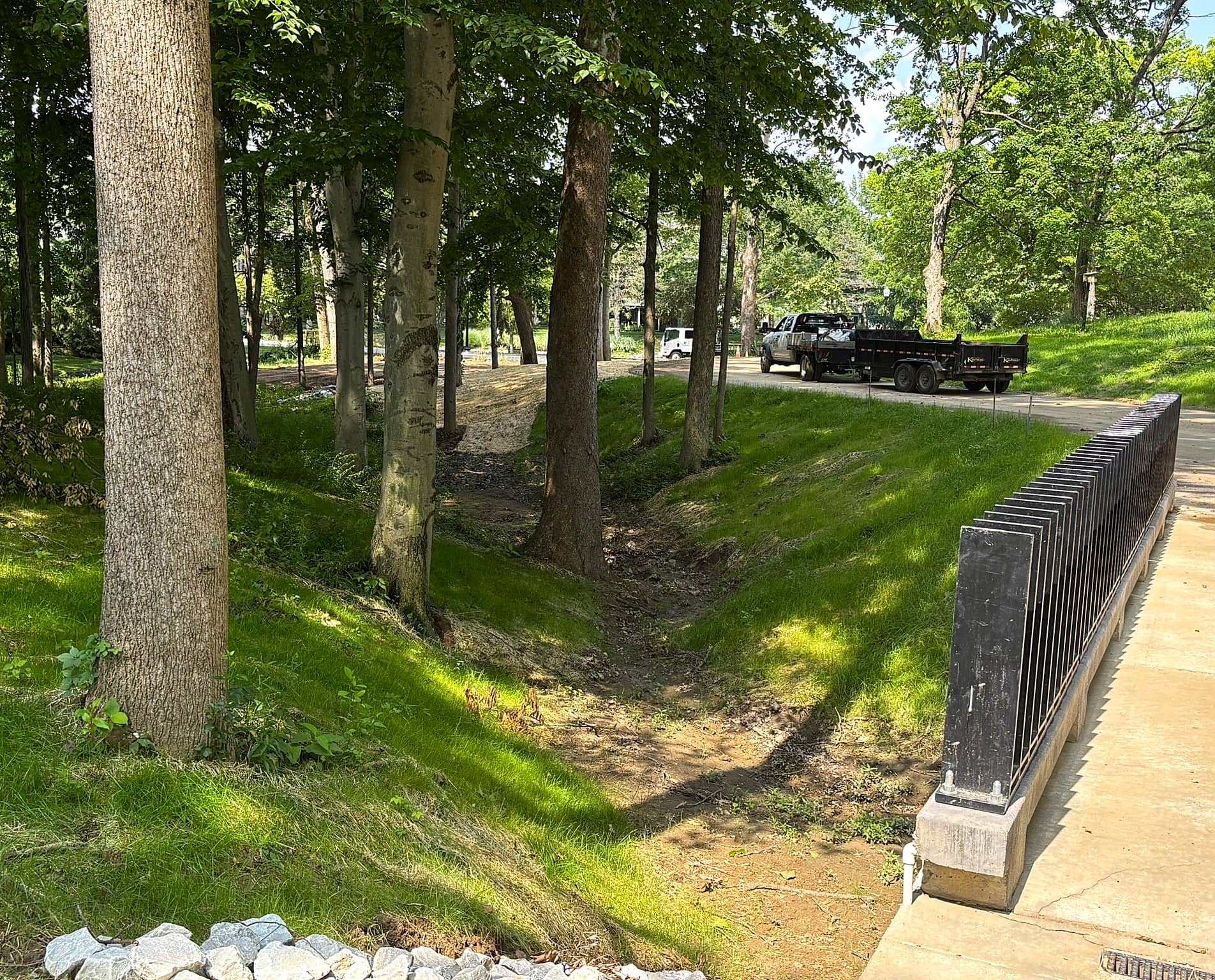

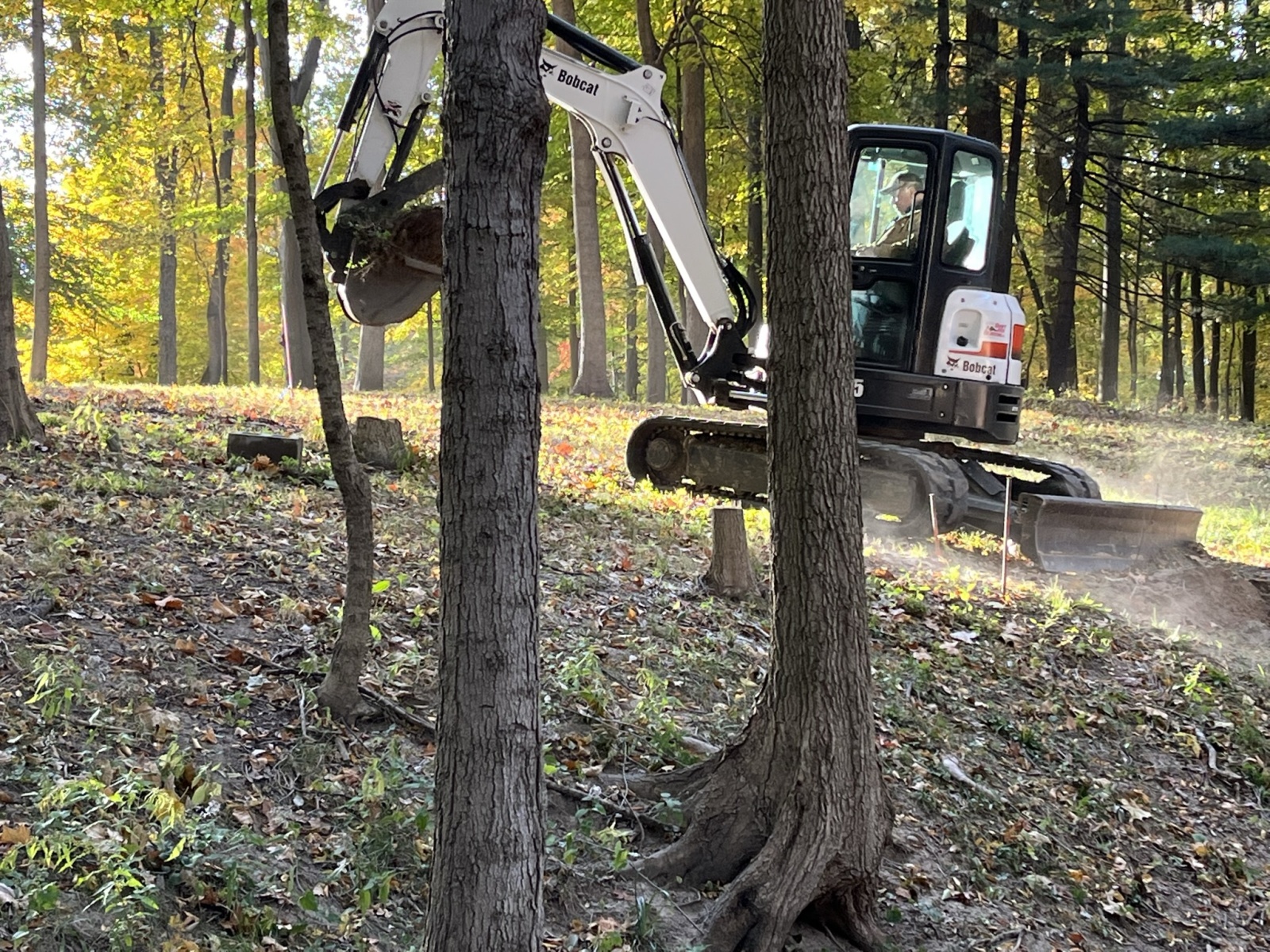

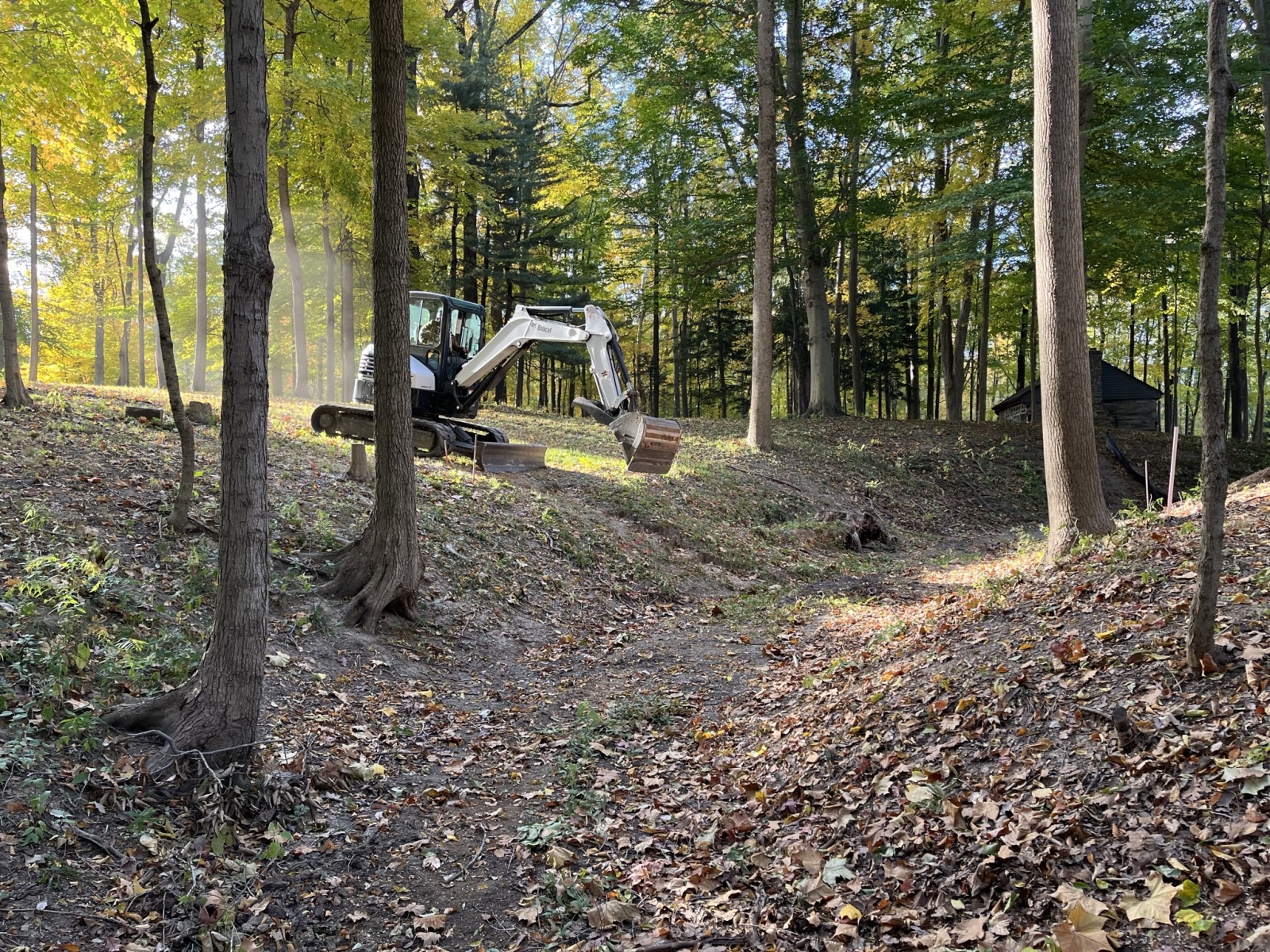

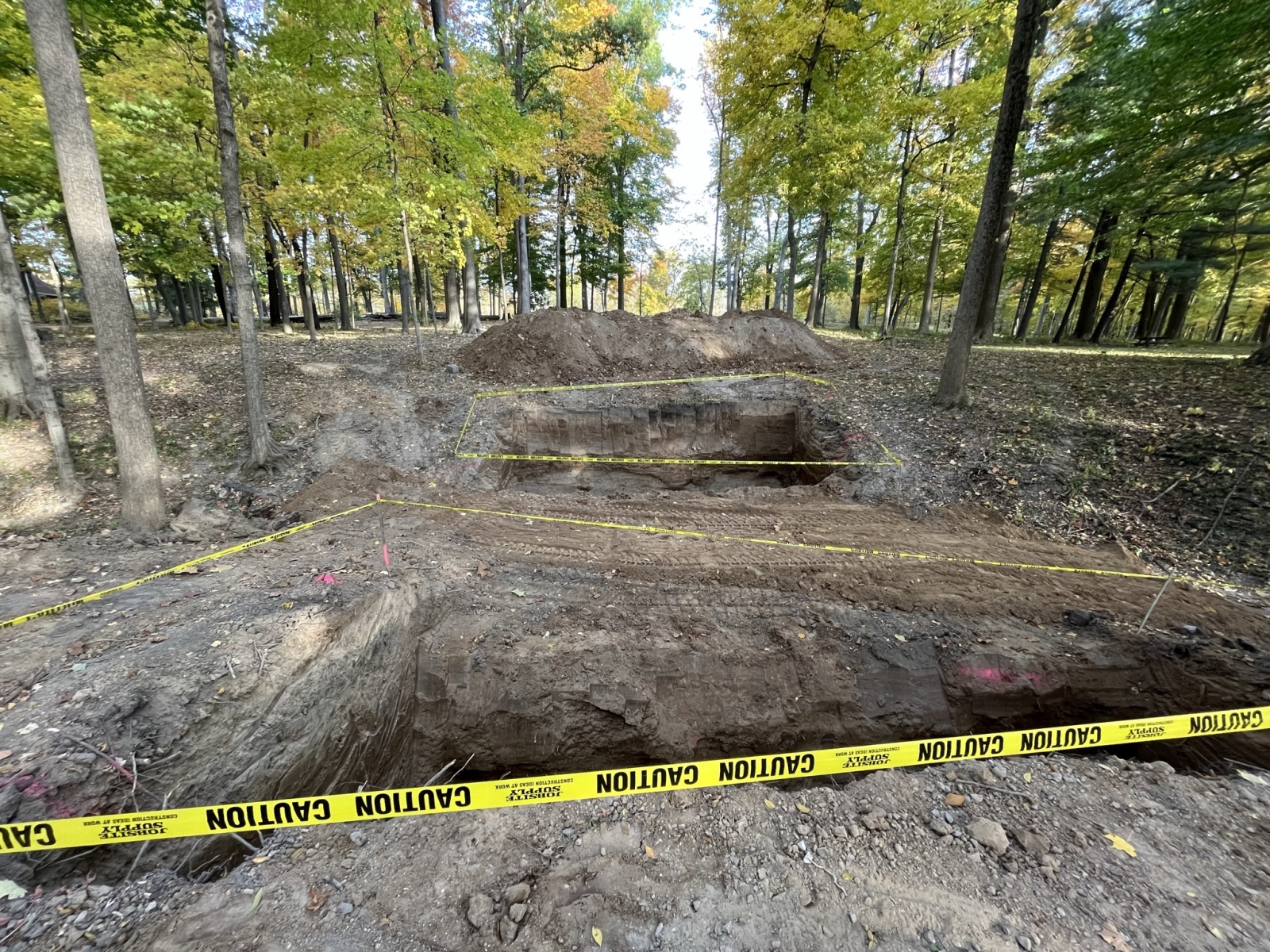

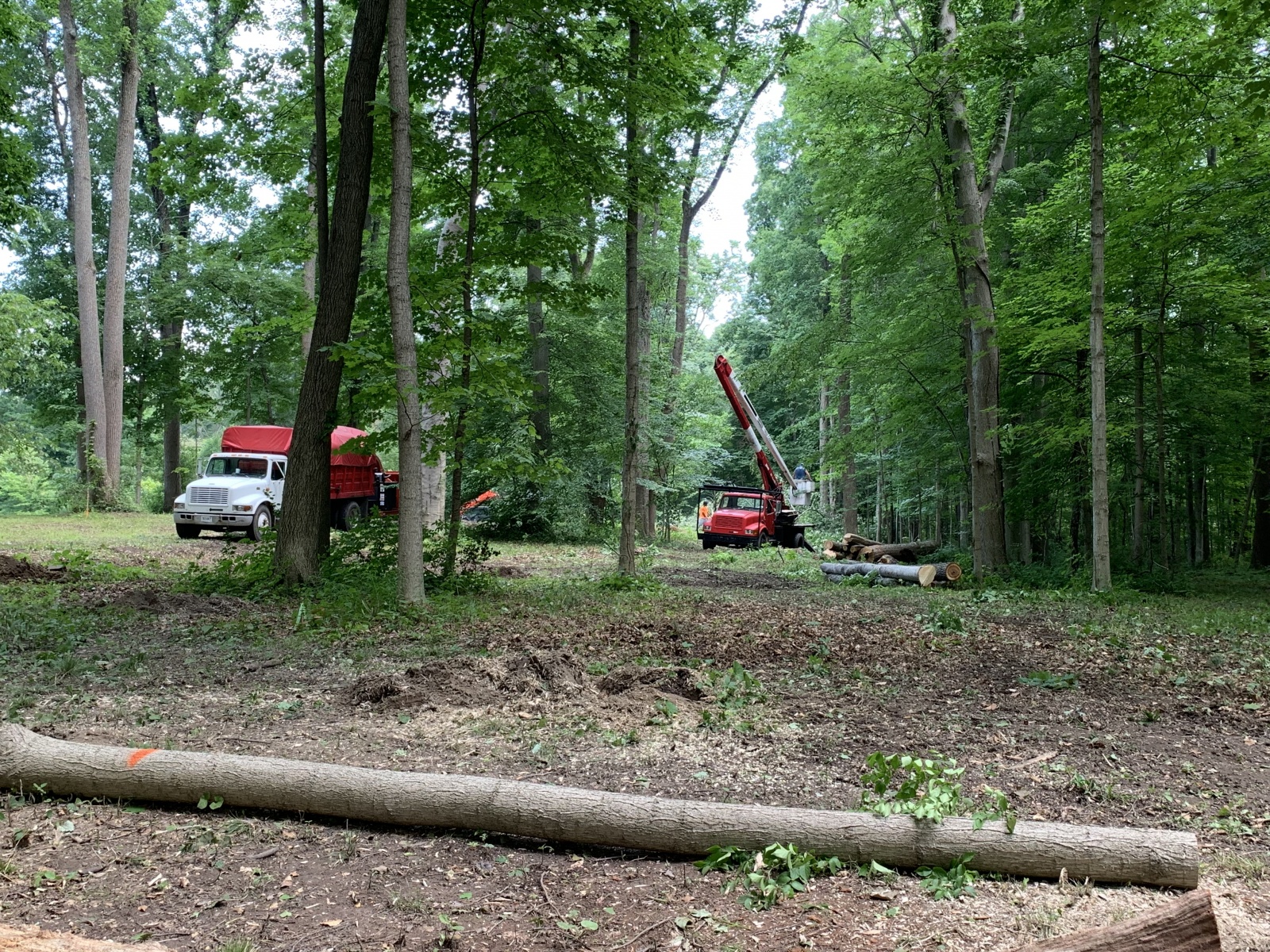

April showers bring May flowers.. and in our case, they also bring Caterpillars! Dirt-work finally begins with the bio-retention pond.
✅ Pre-construction meeting completed this morning, and the final permits have been issued! We are released for construction!!

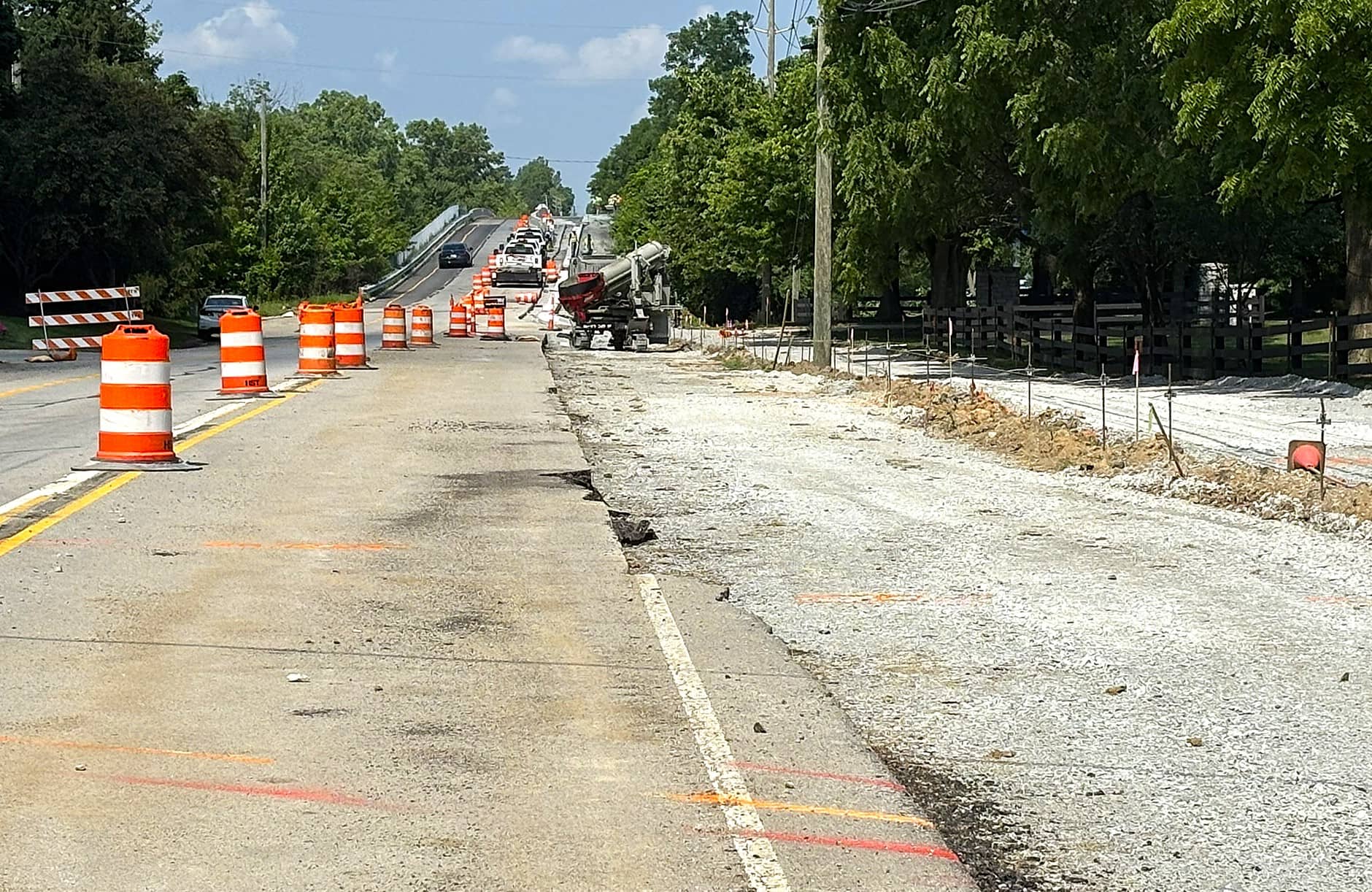

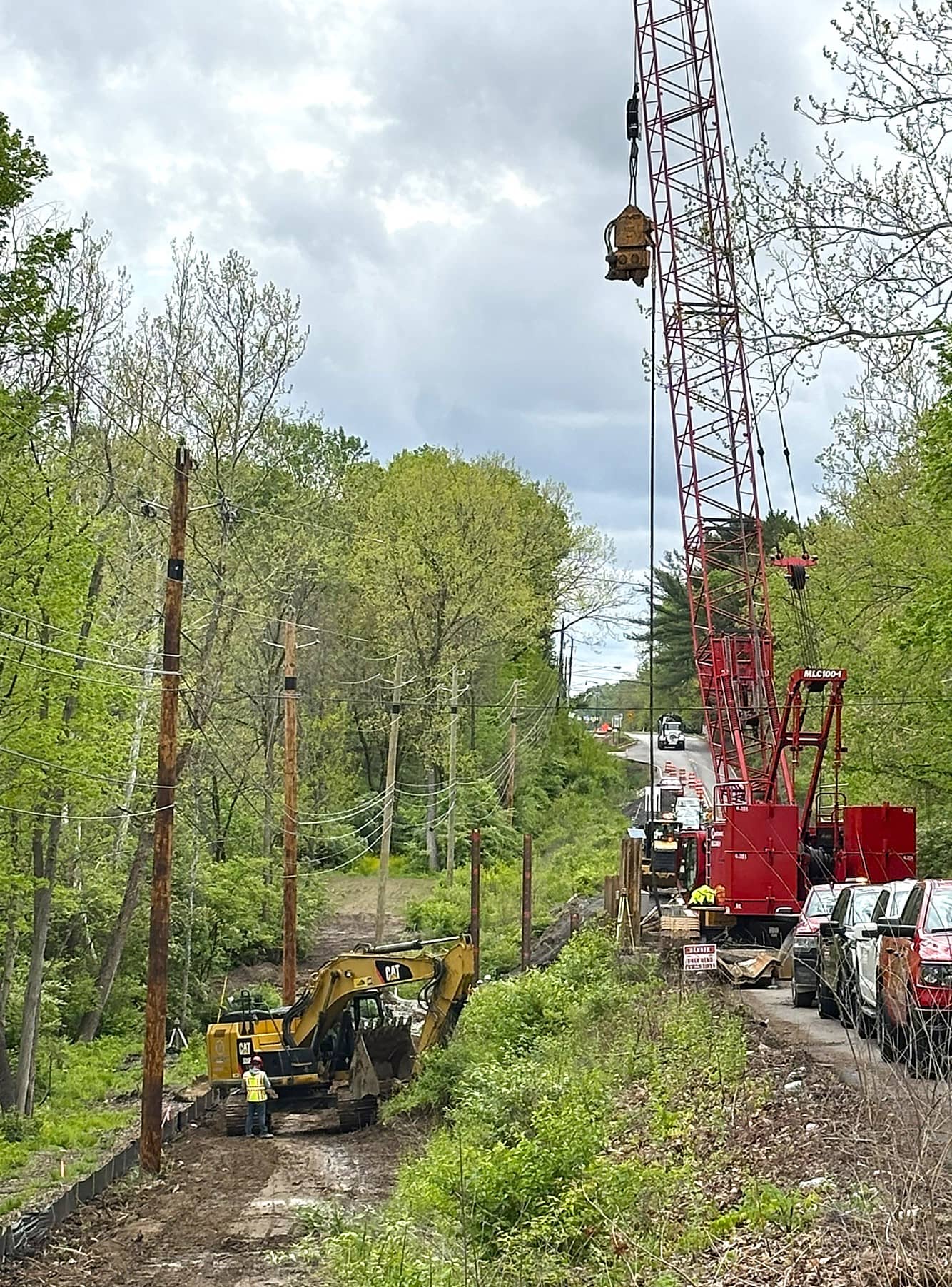

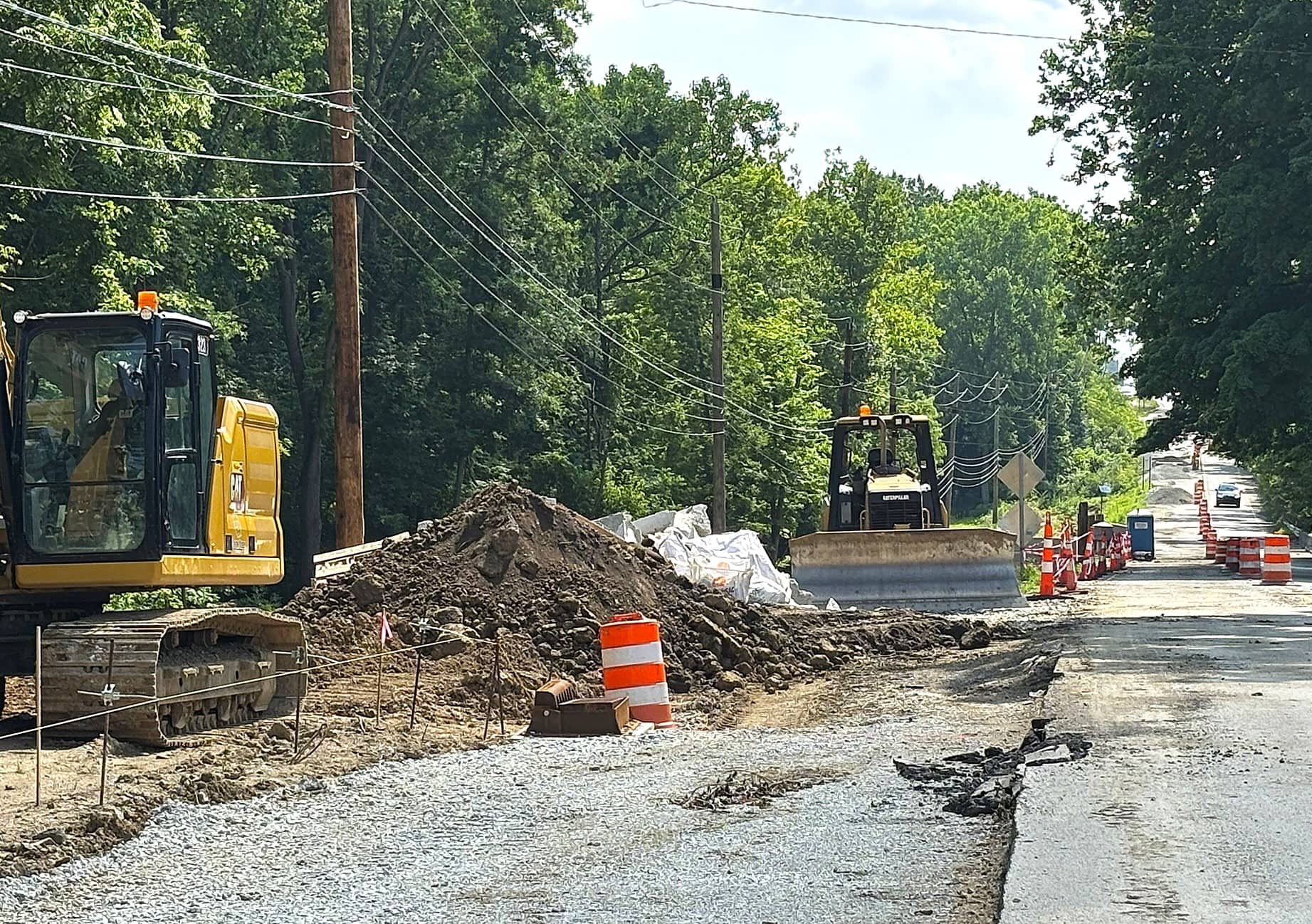

The City of Carmel, Public Works begins installation of new power poles on 96th Street to allow room for our new traffic blister and turning lane.

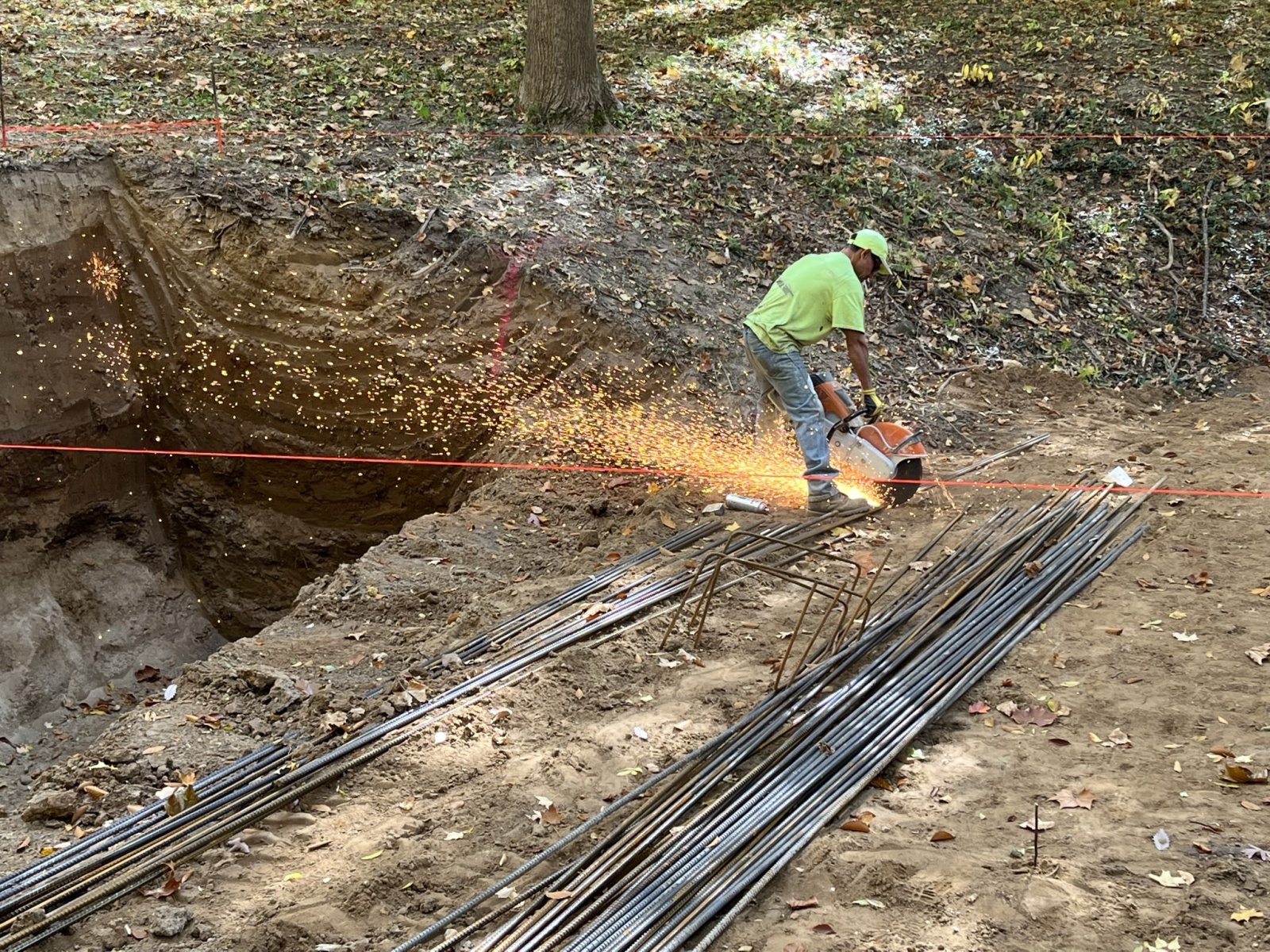

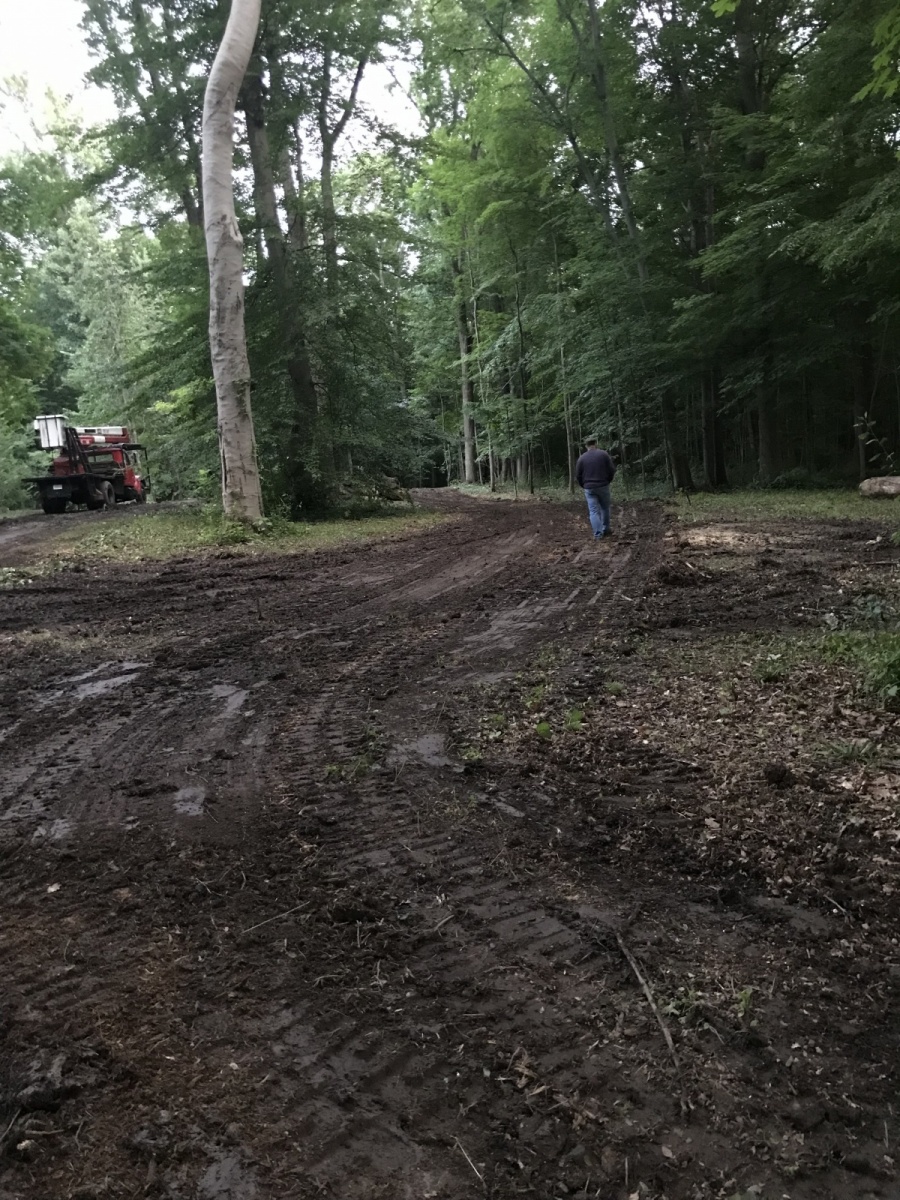

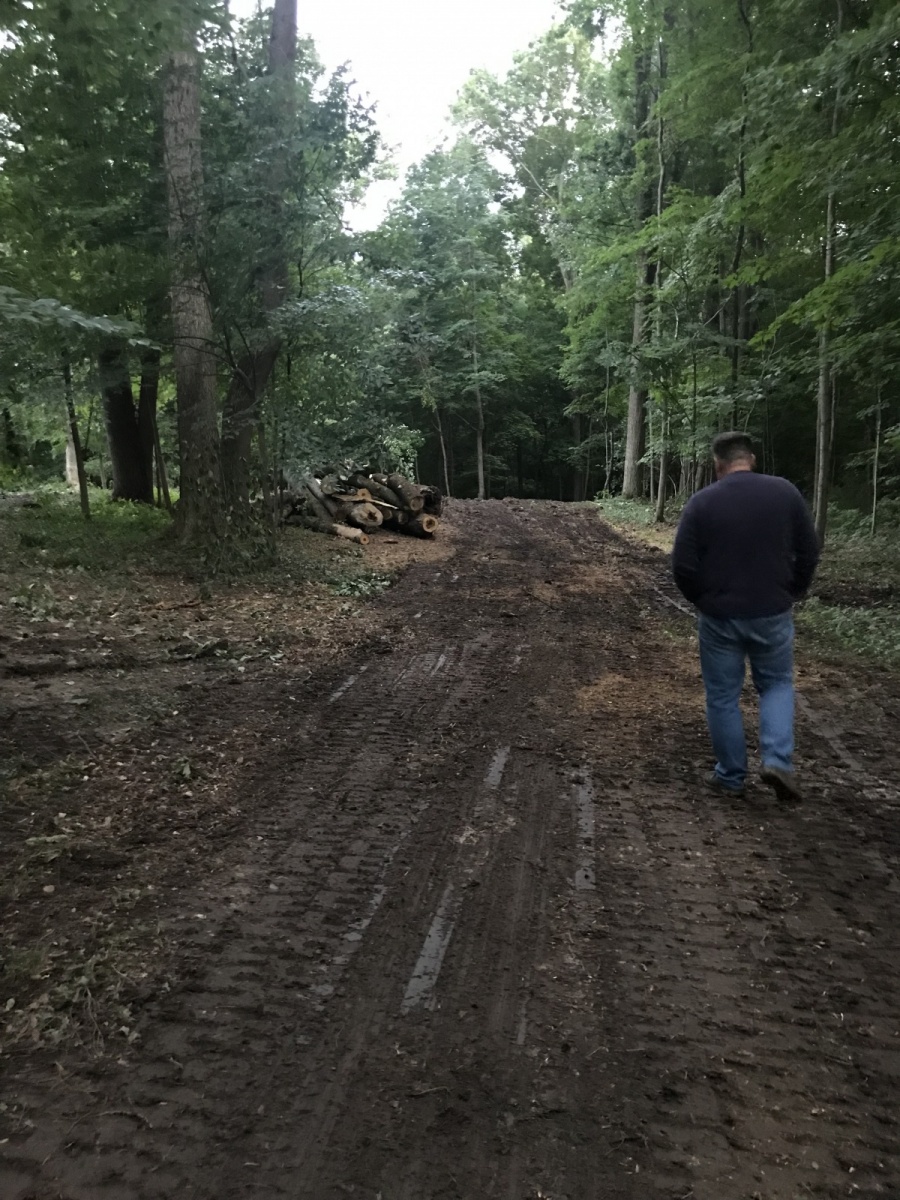

Trenching for, and installing silt-fence in preparation for starting construction on the our new roadway and installing utilities.

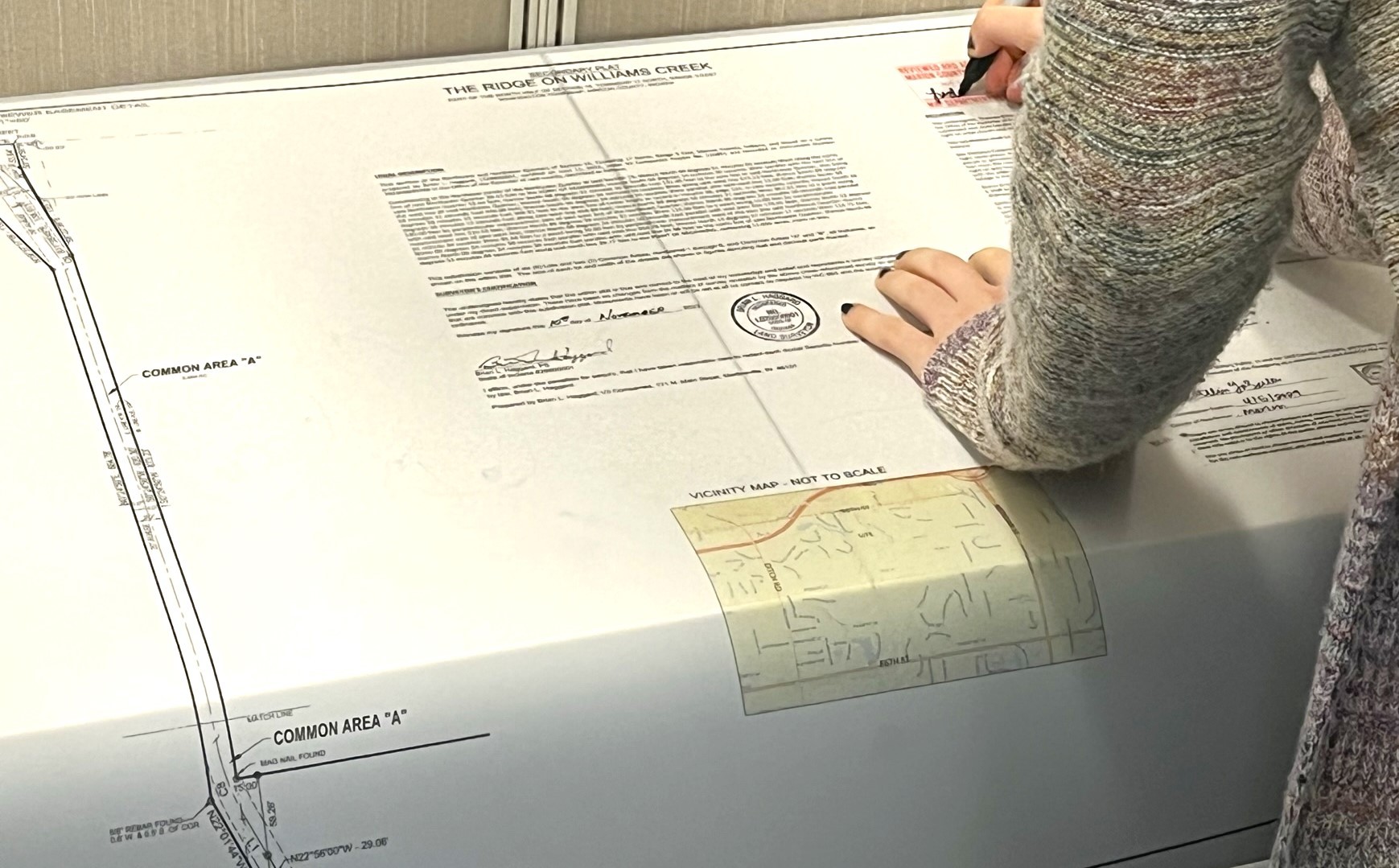

February 27th, 2024 – After 7 Months of Work, The Final Approval for Permitting!

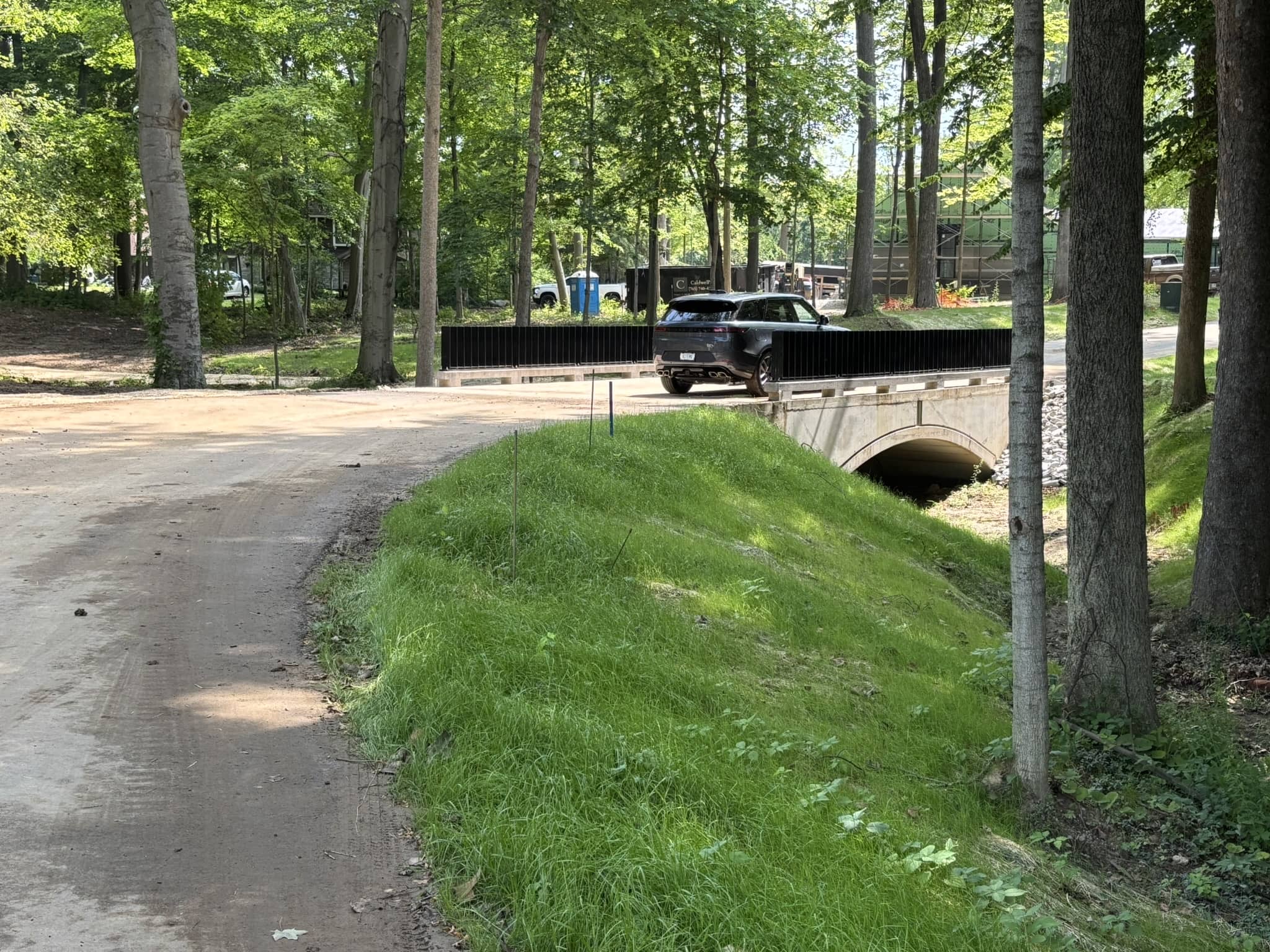

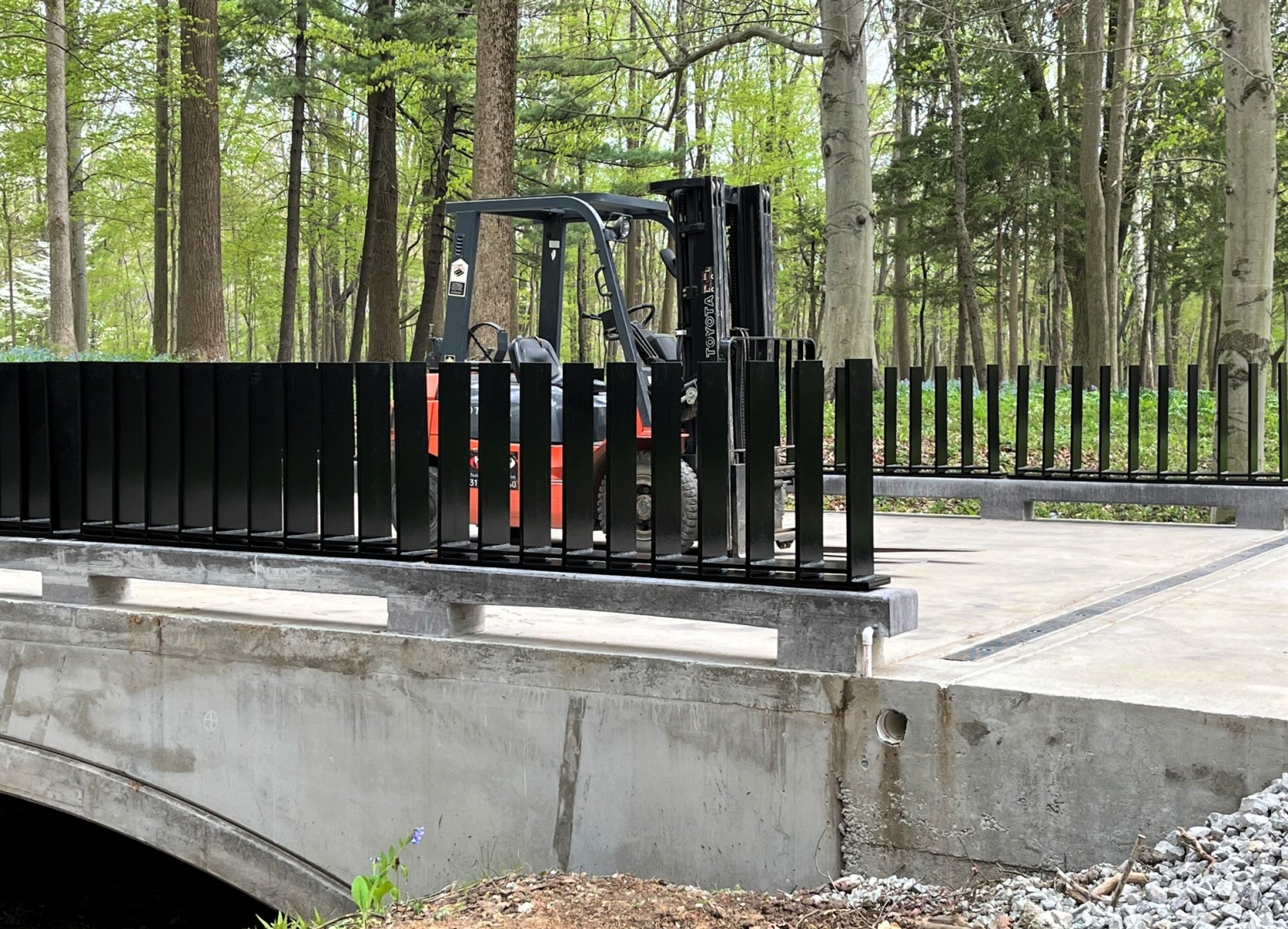

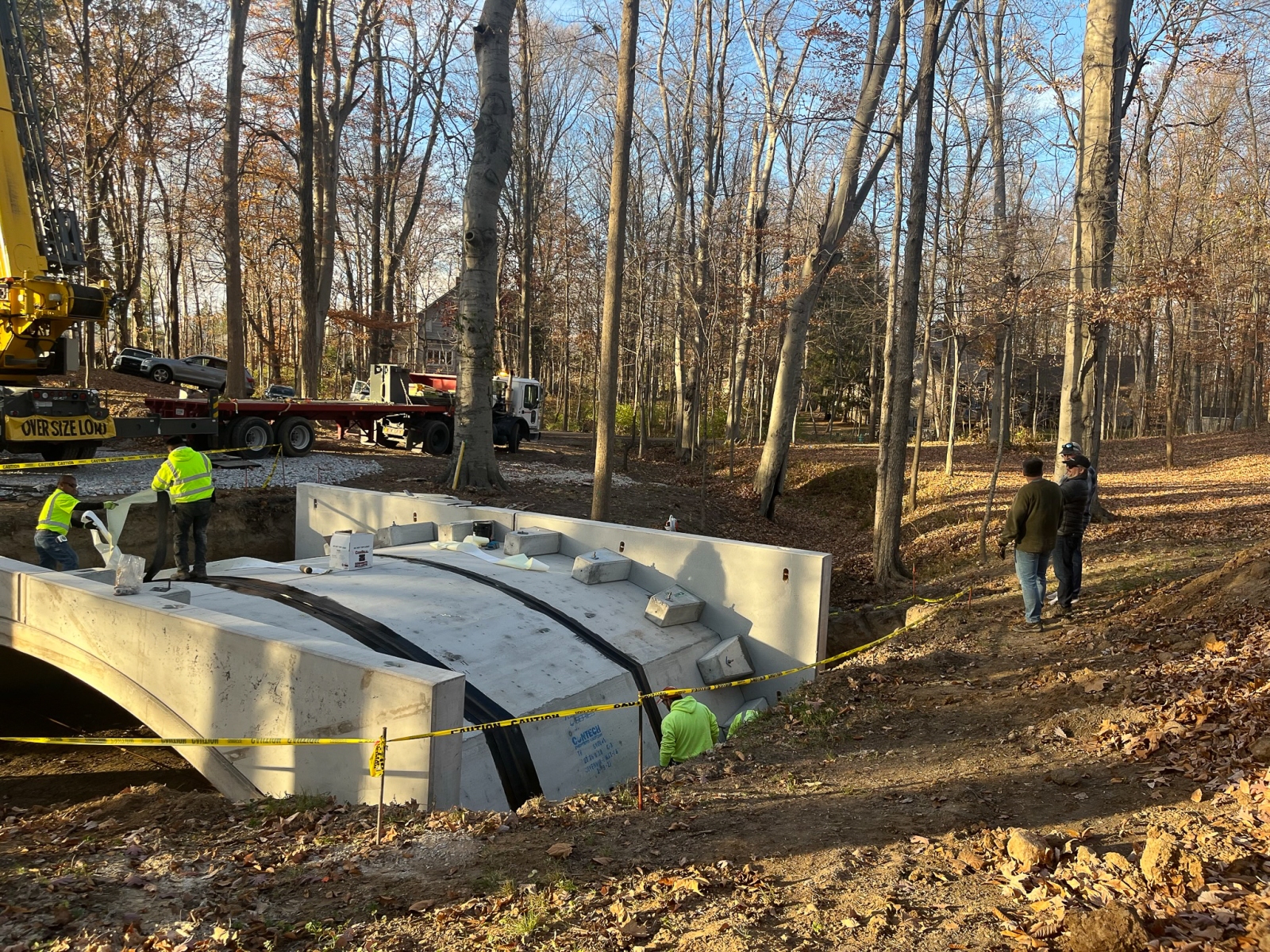

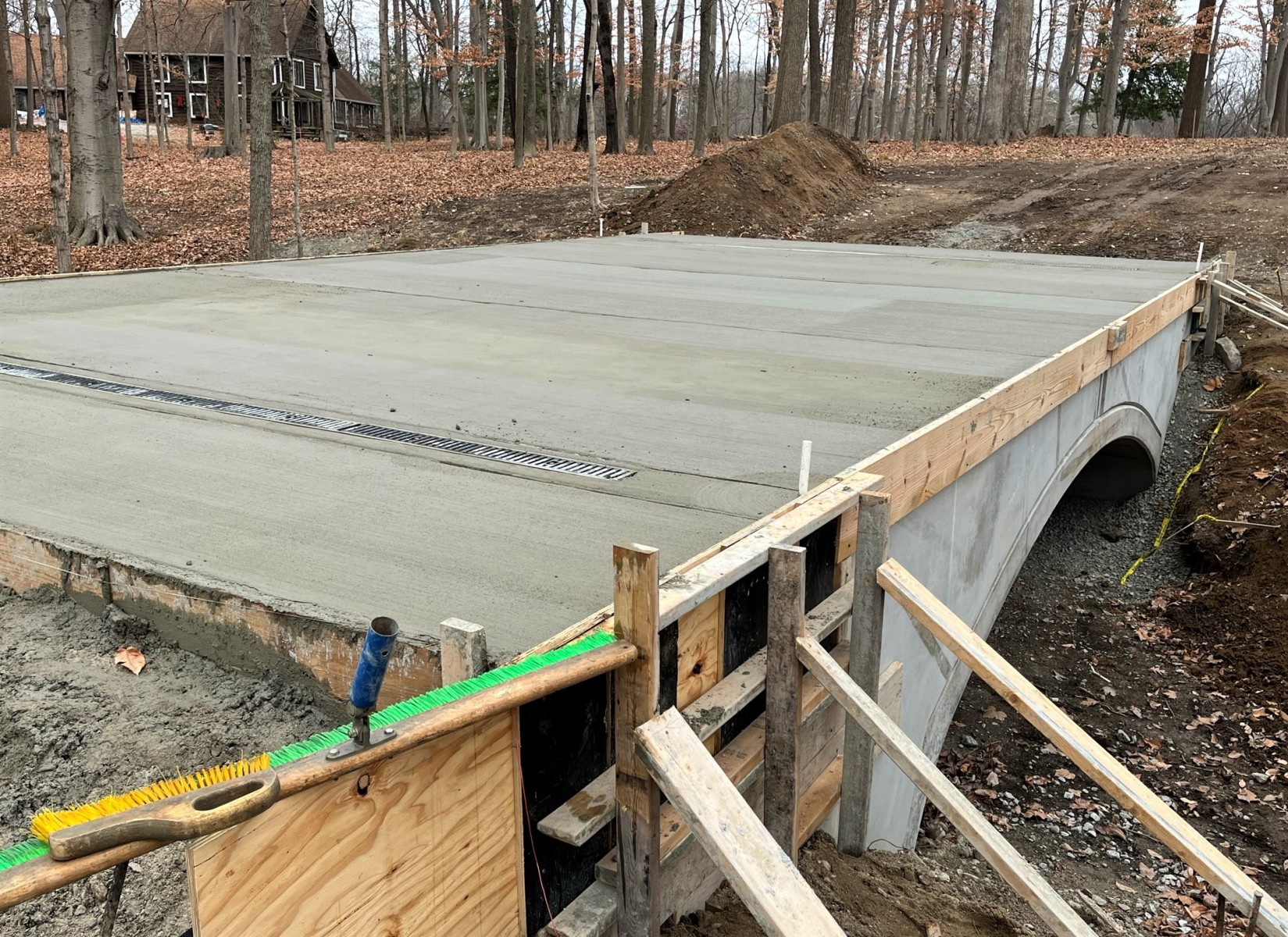

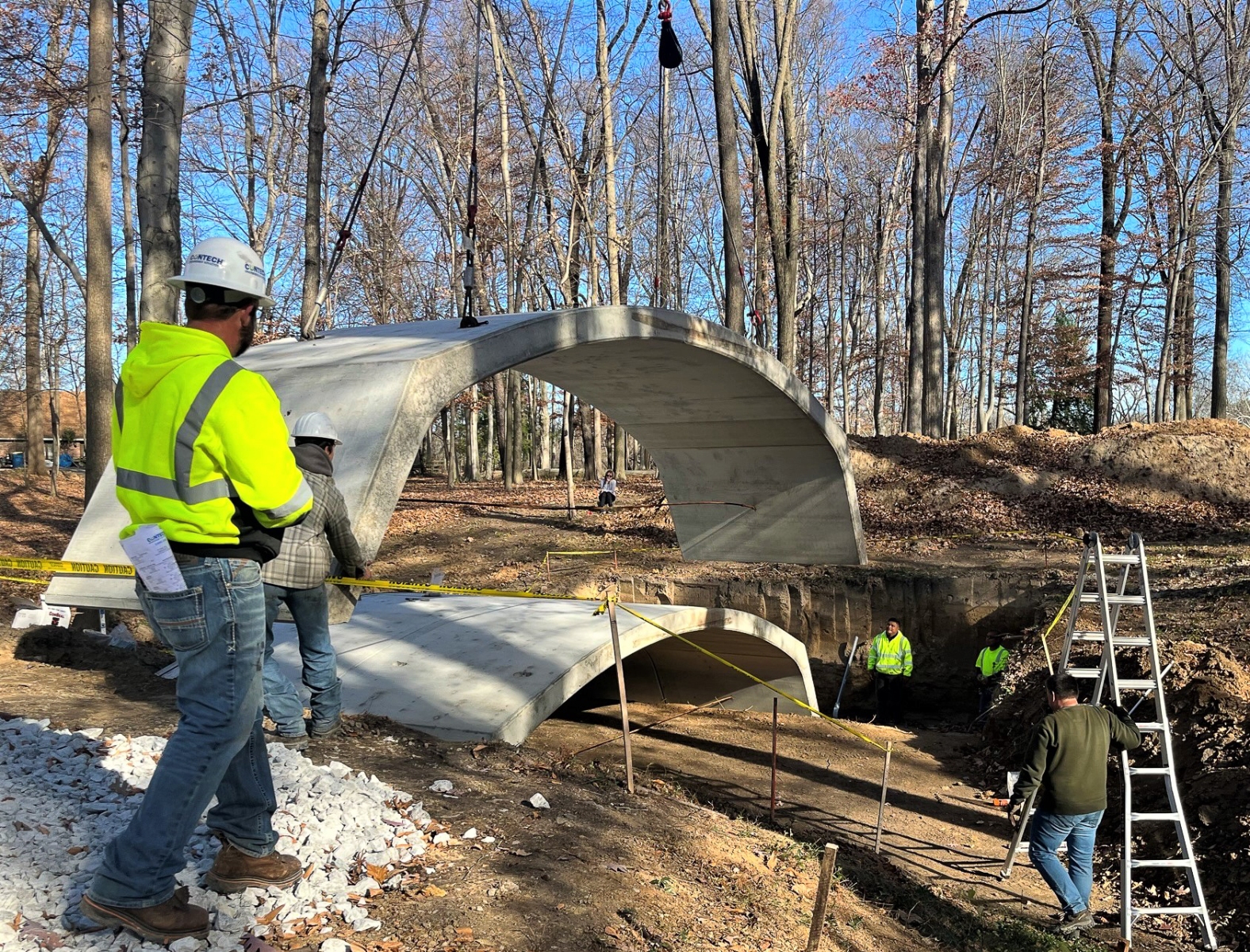

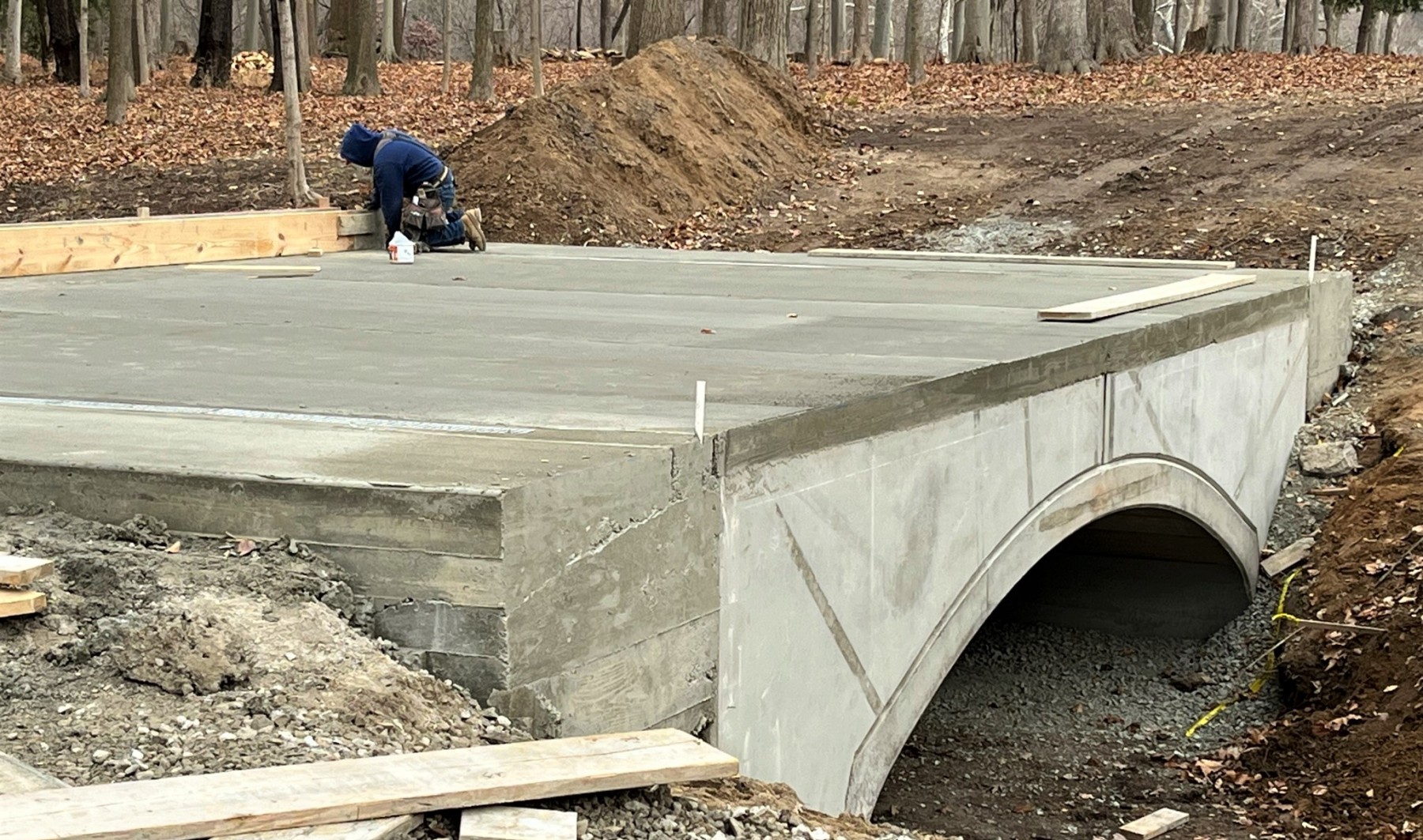

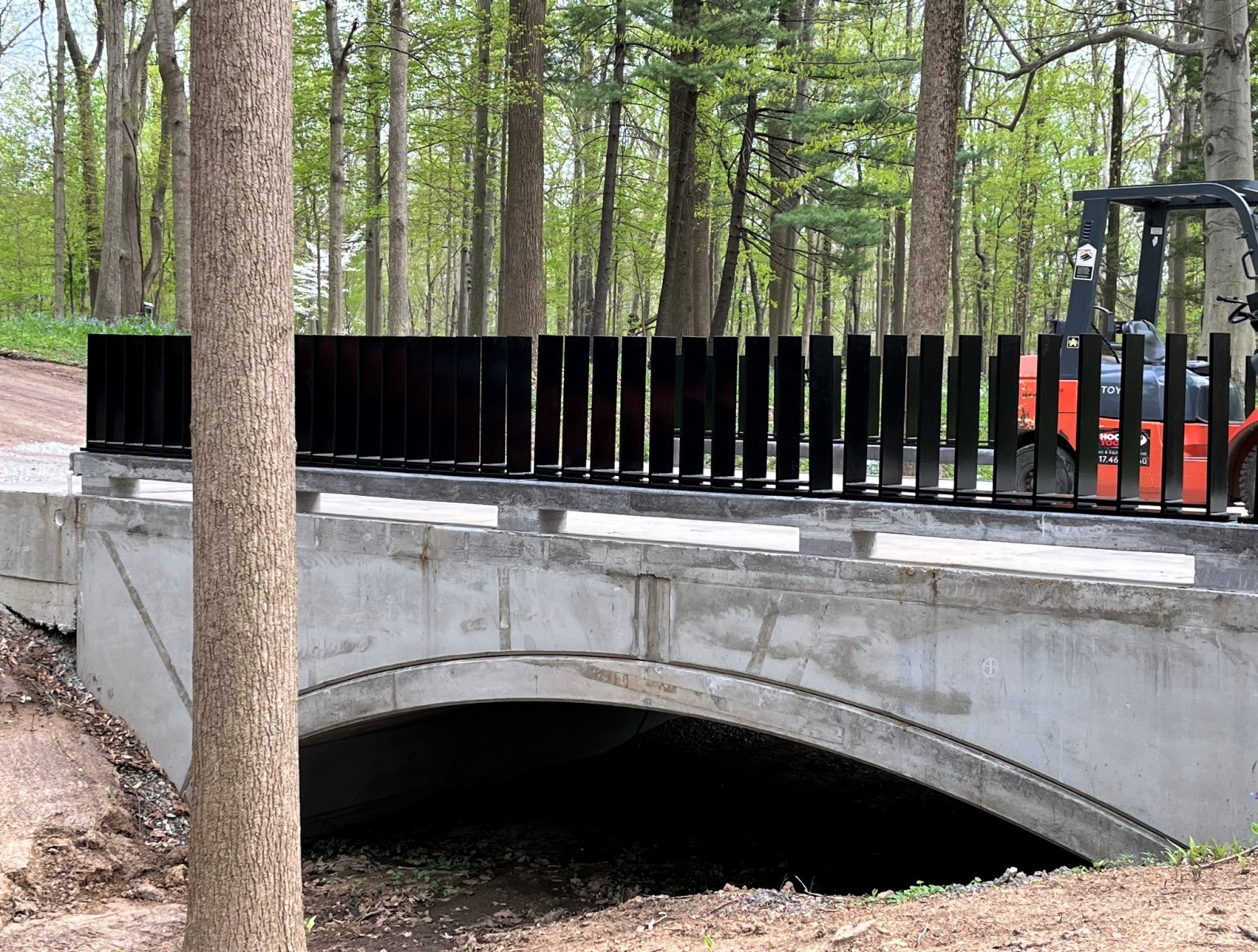

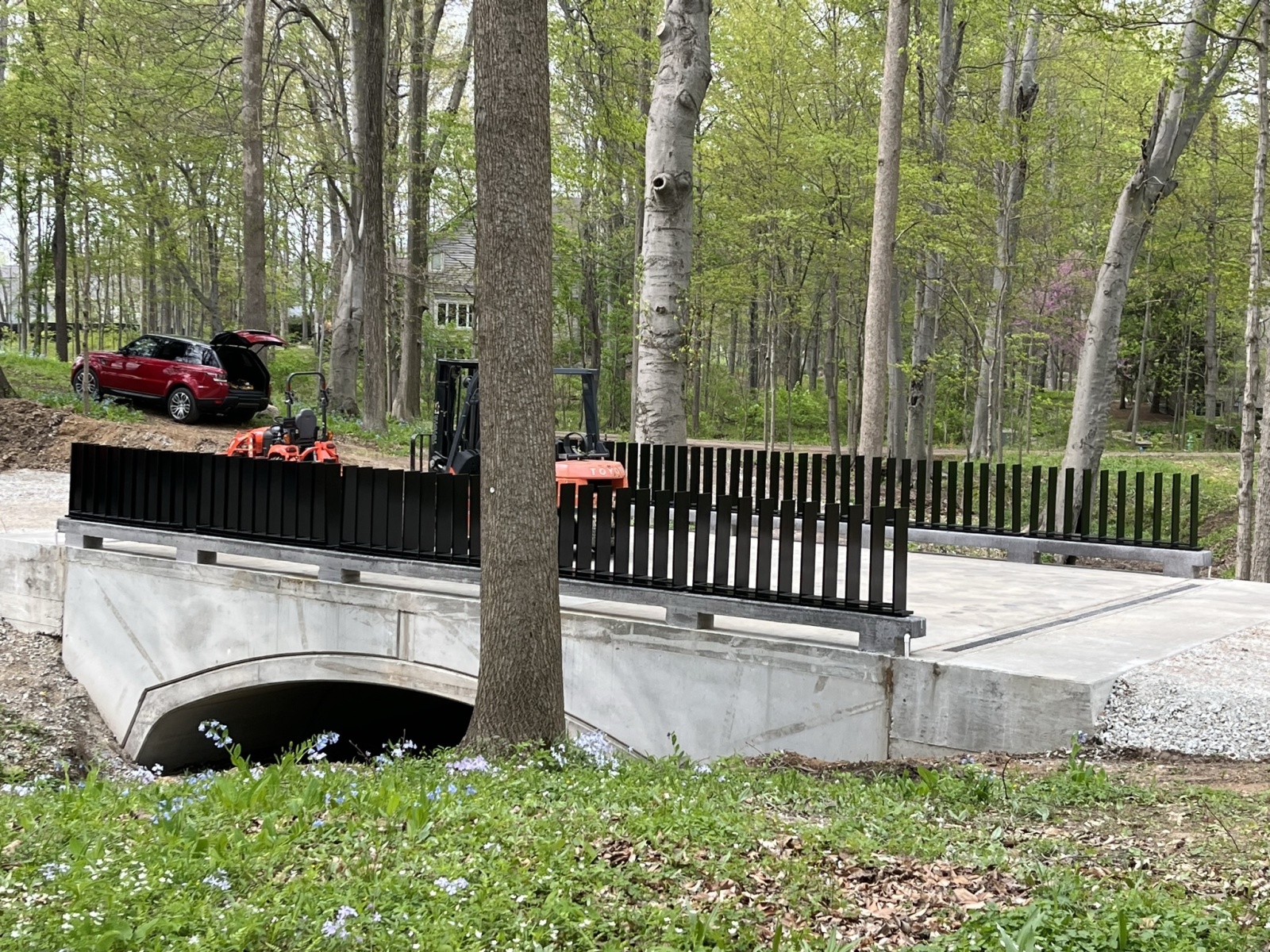

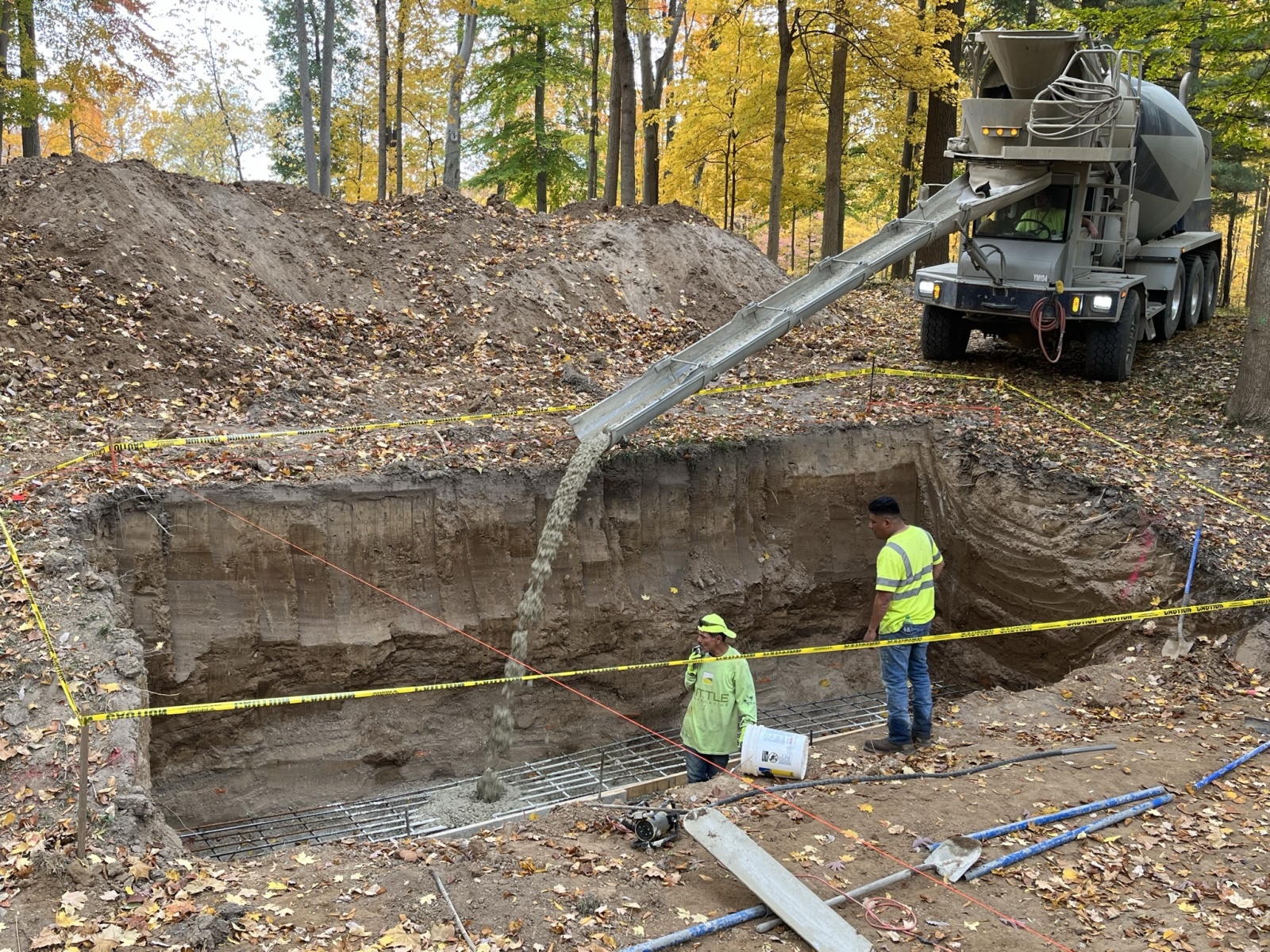

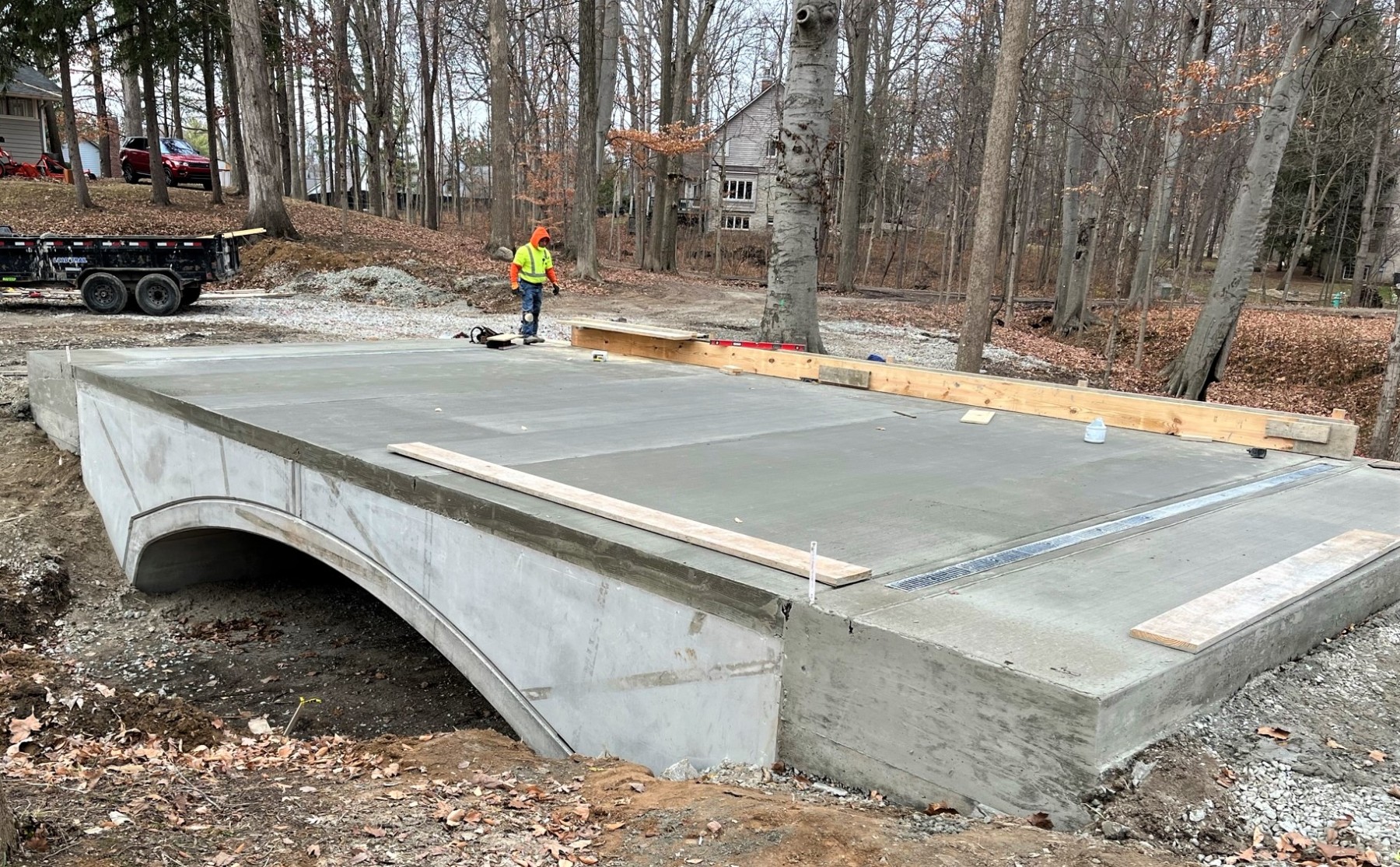

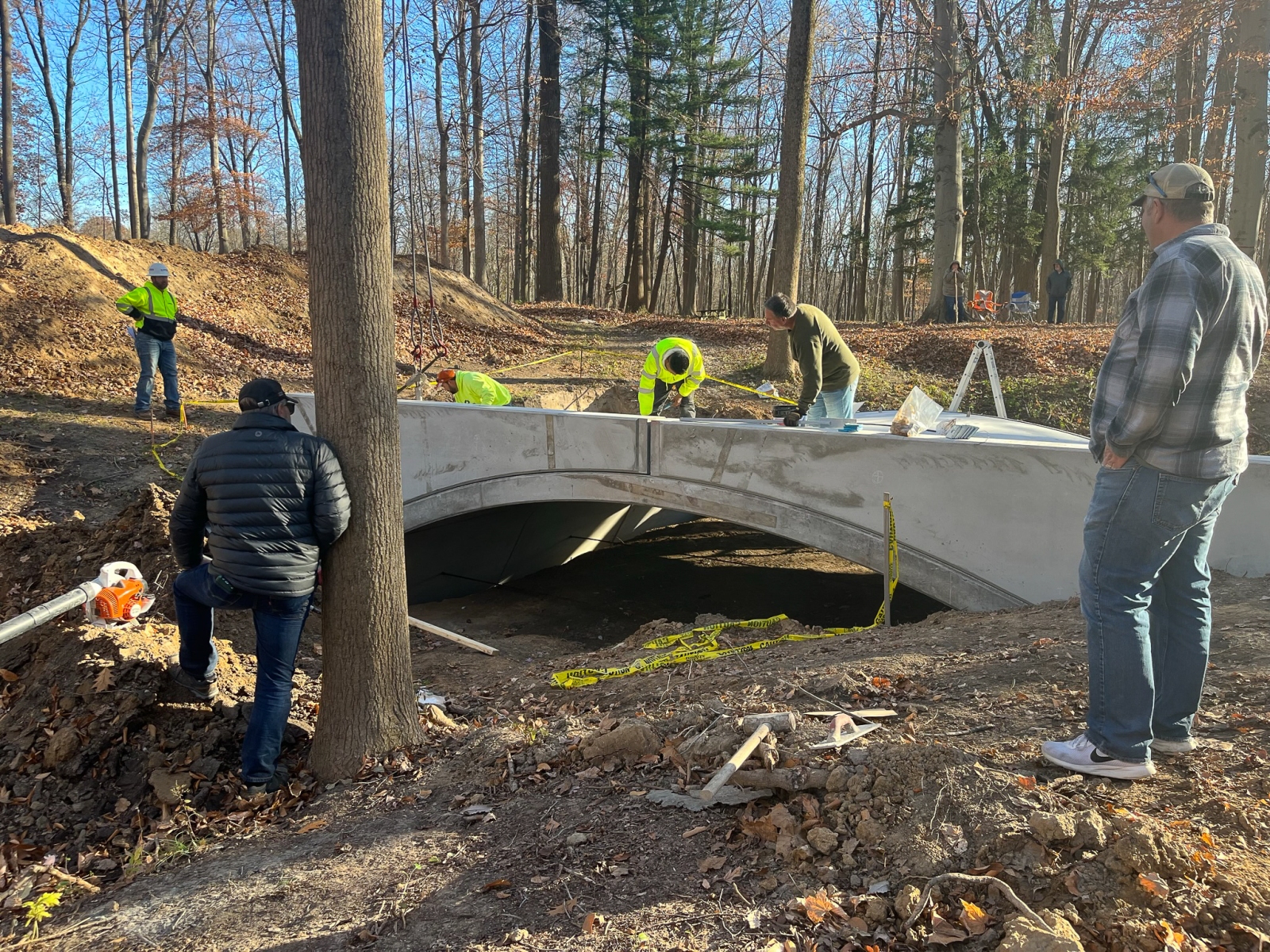

The steps include setting the first and second sections into place, placing the third section and the head walls, and sealing and grouting the sections and foundations together. Finally, the workers took a break for a beer after completing the hard work.

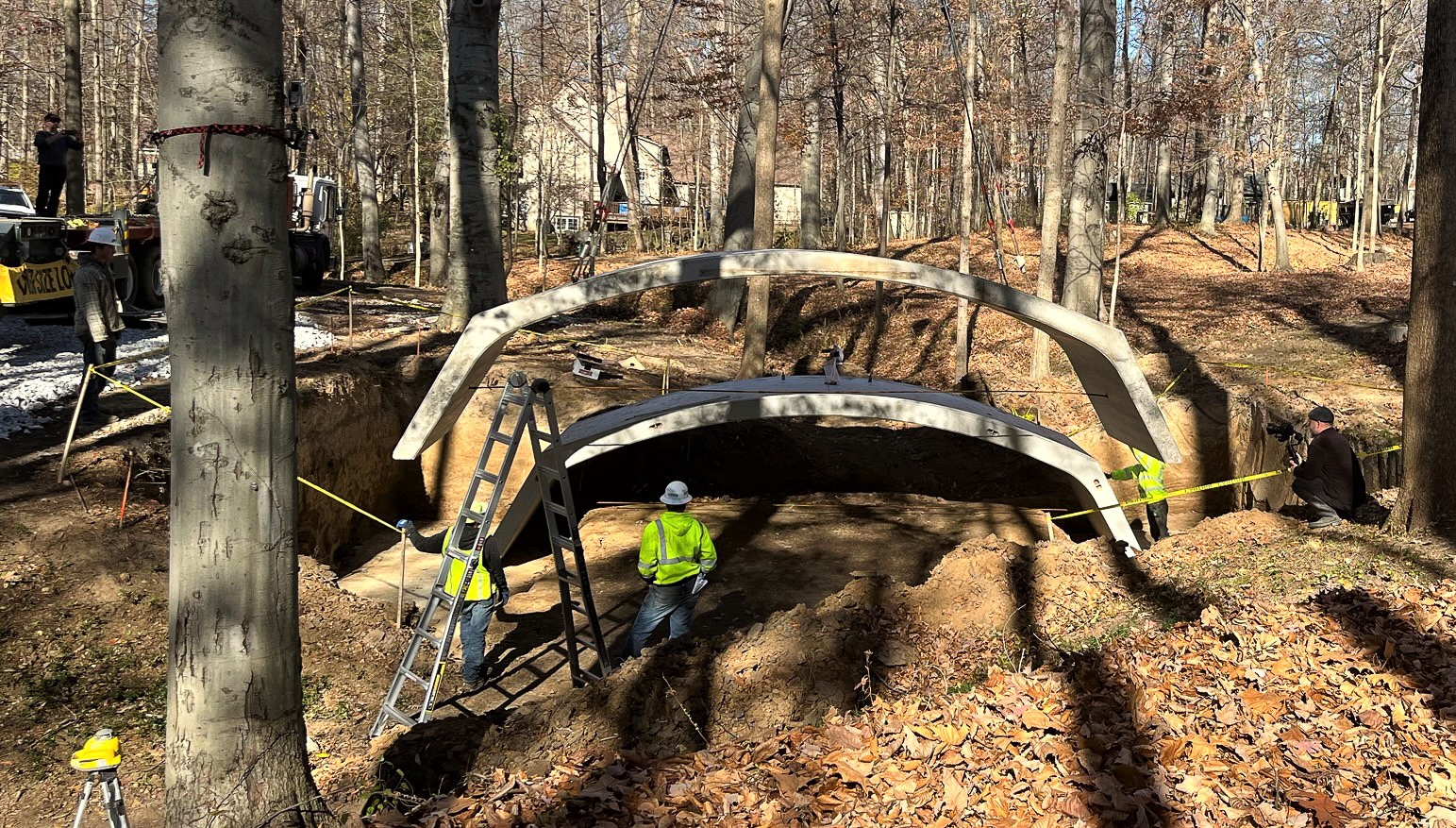

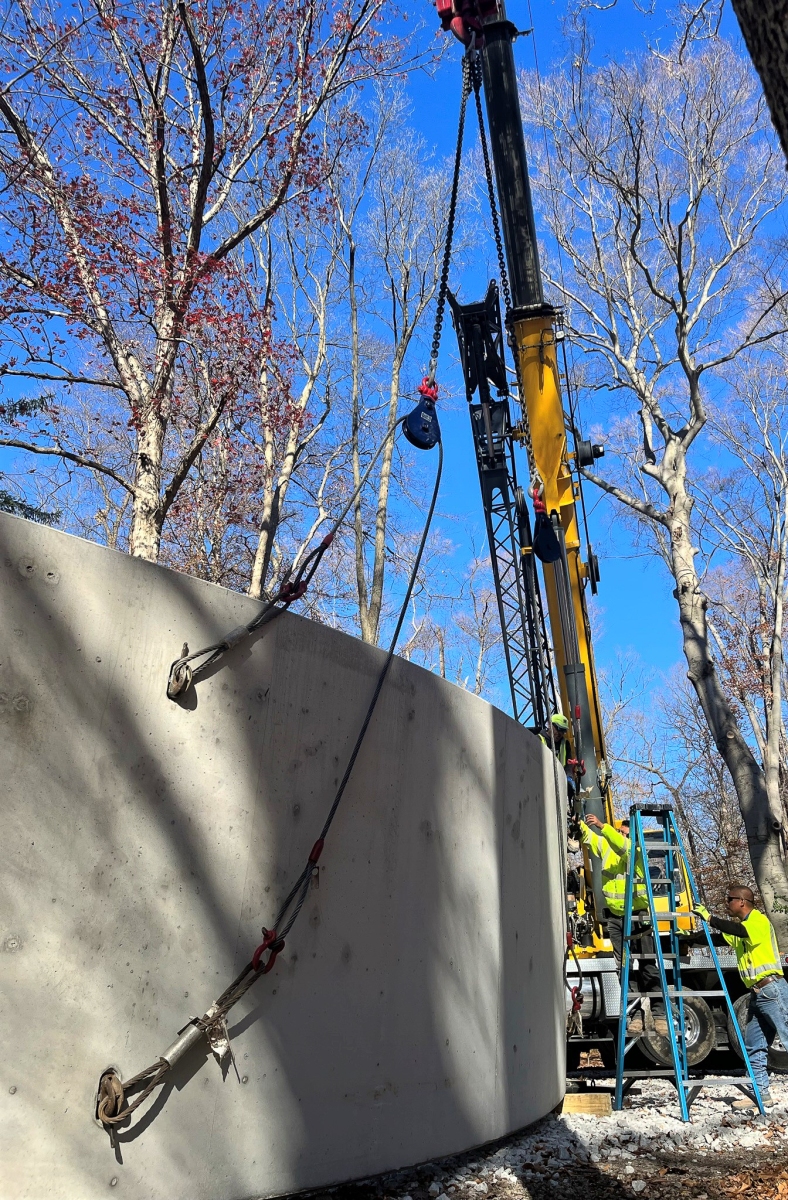

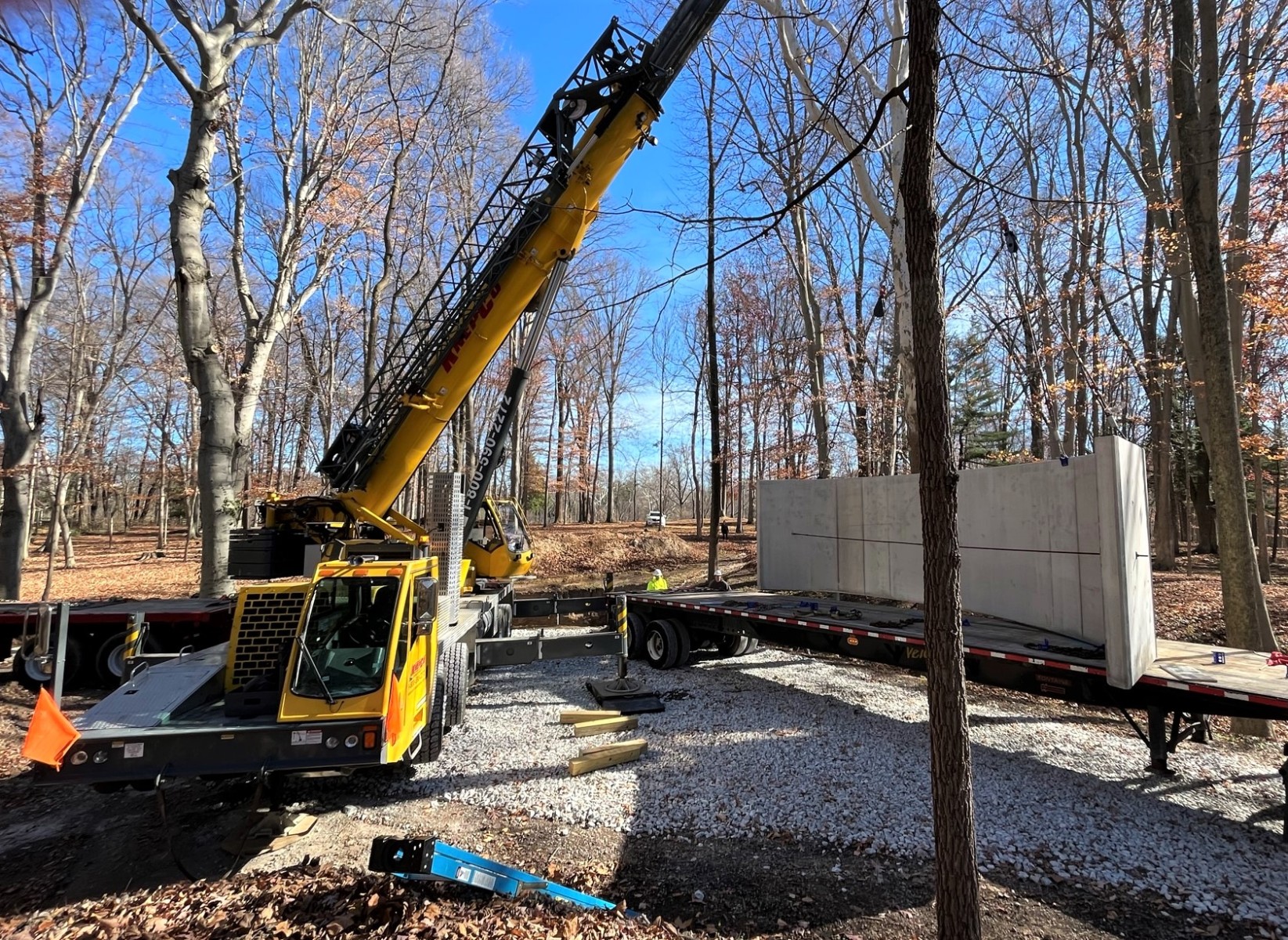

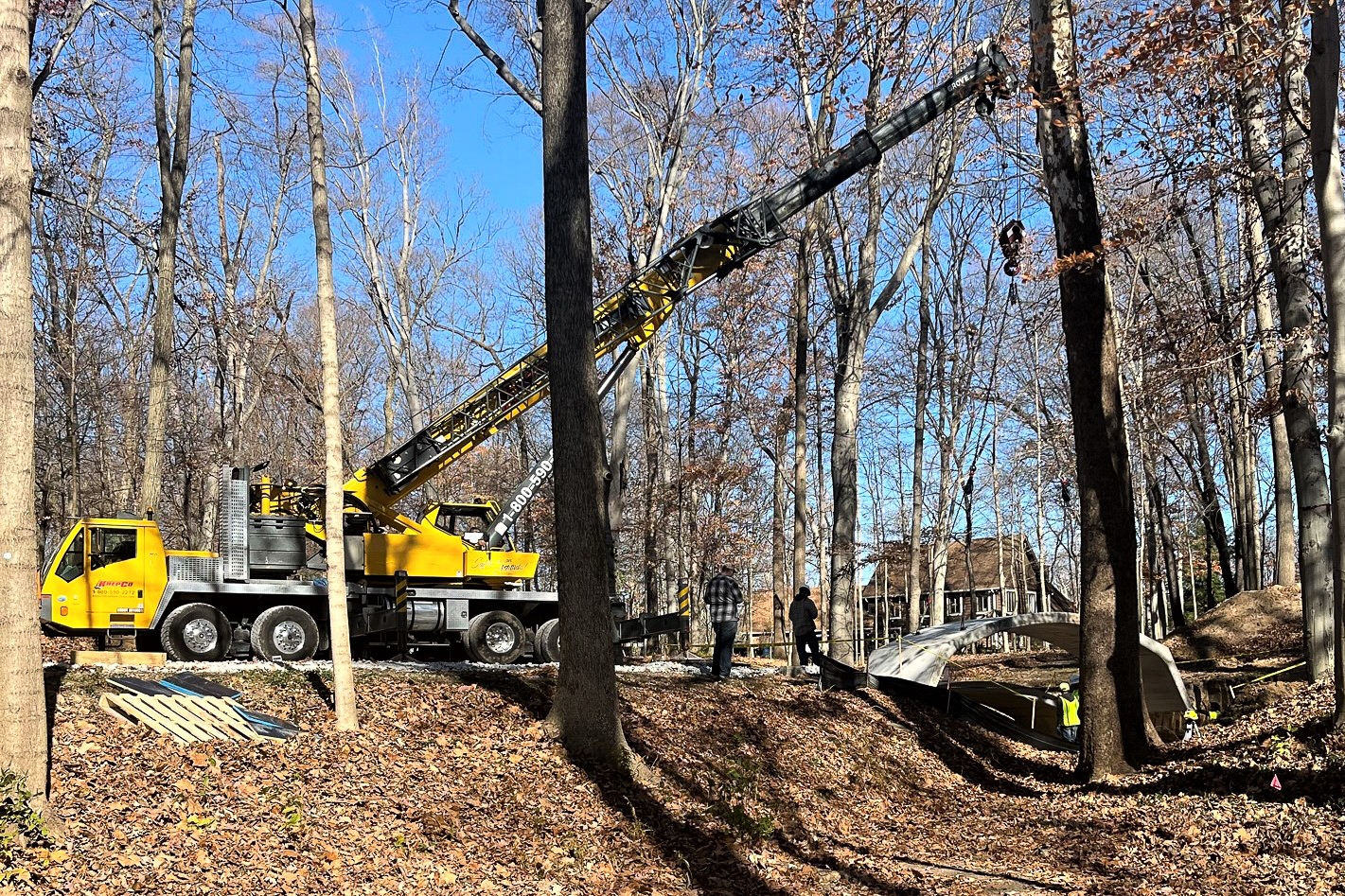

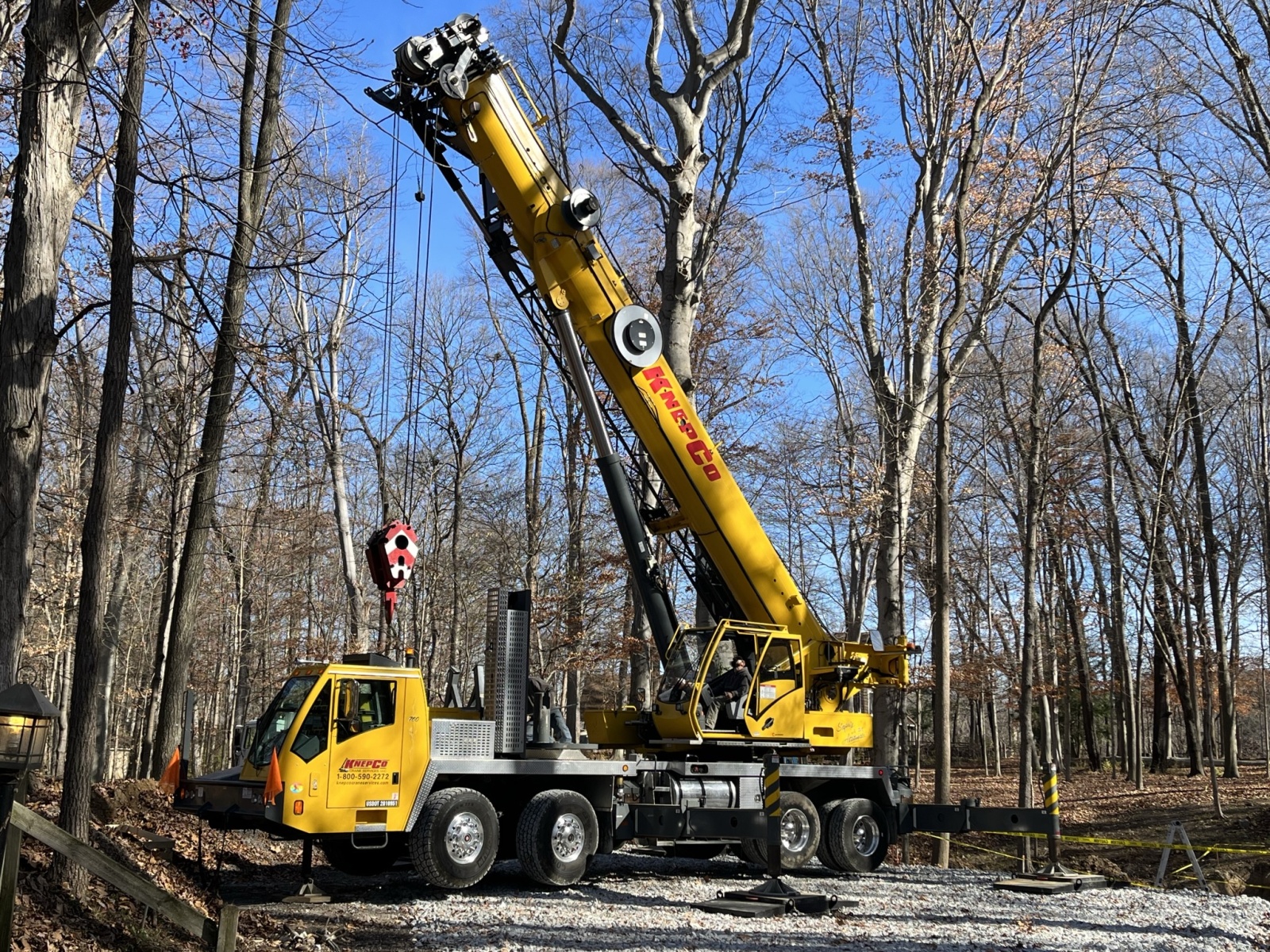

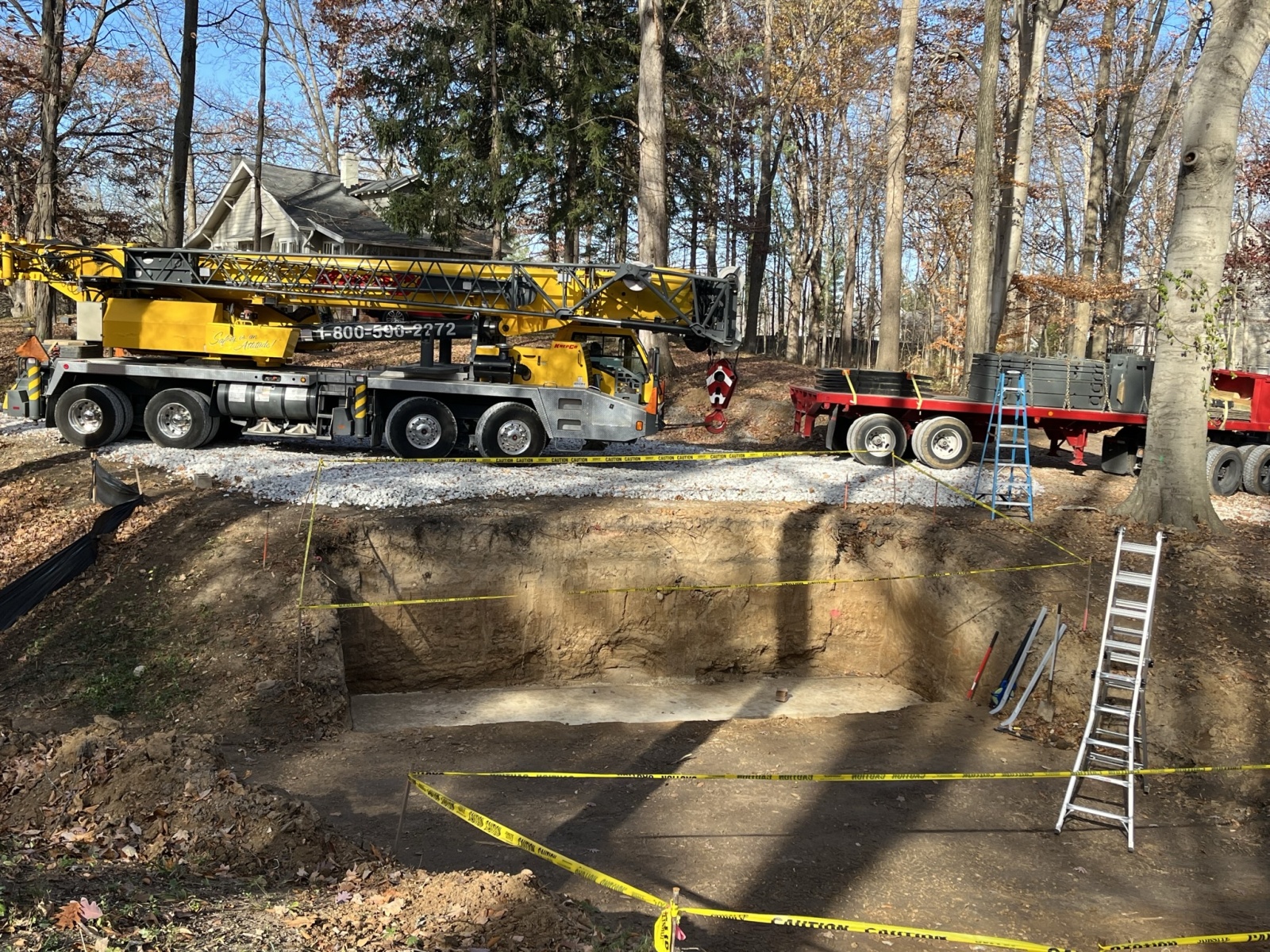

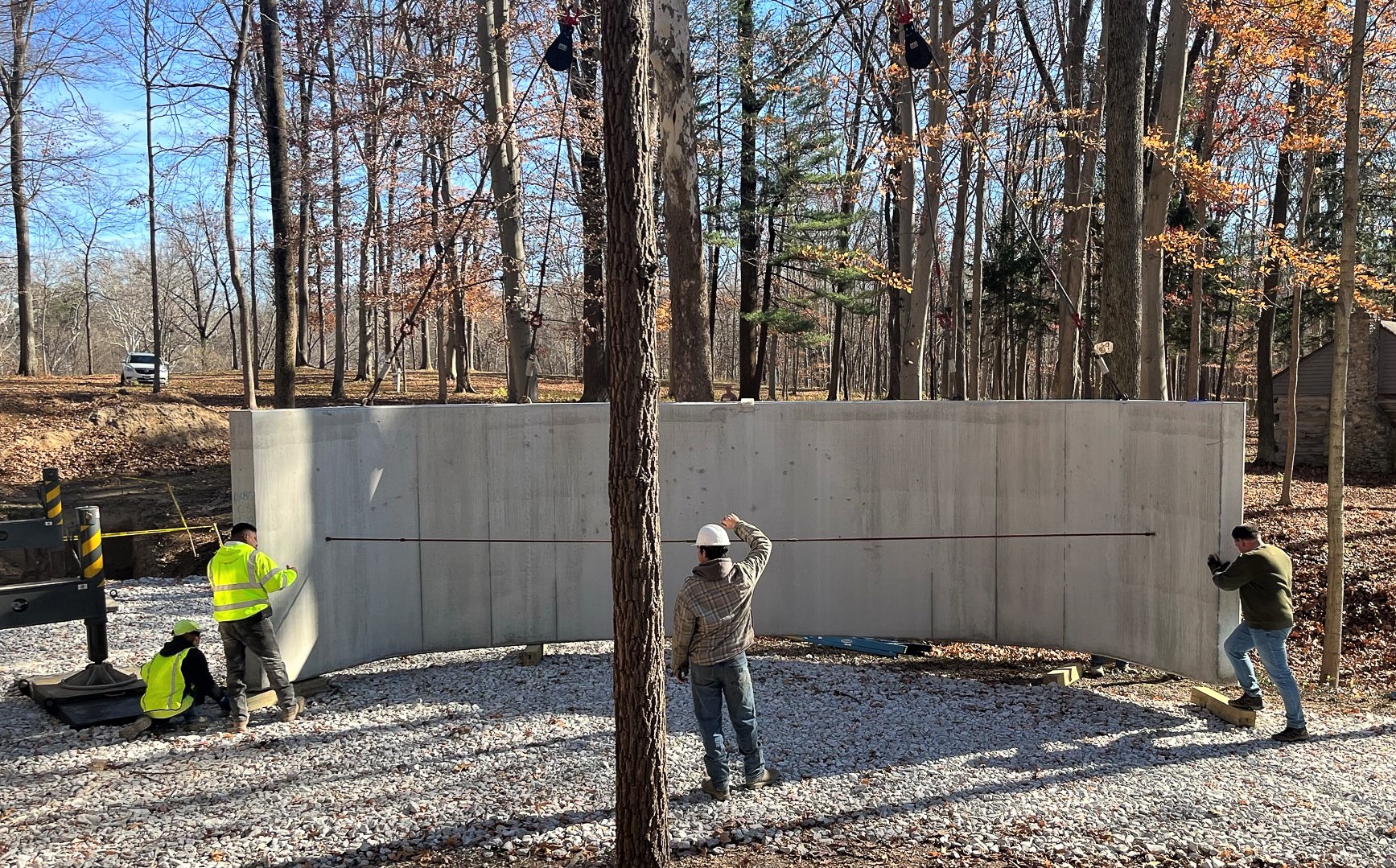

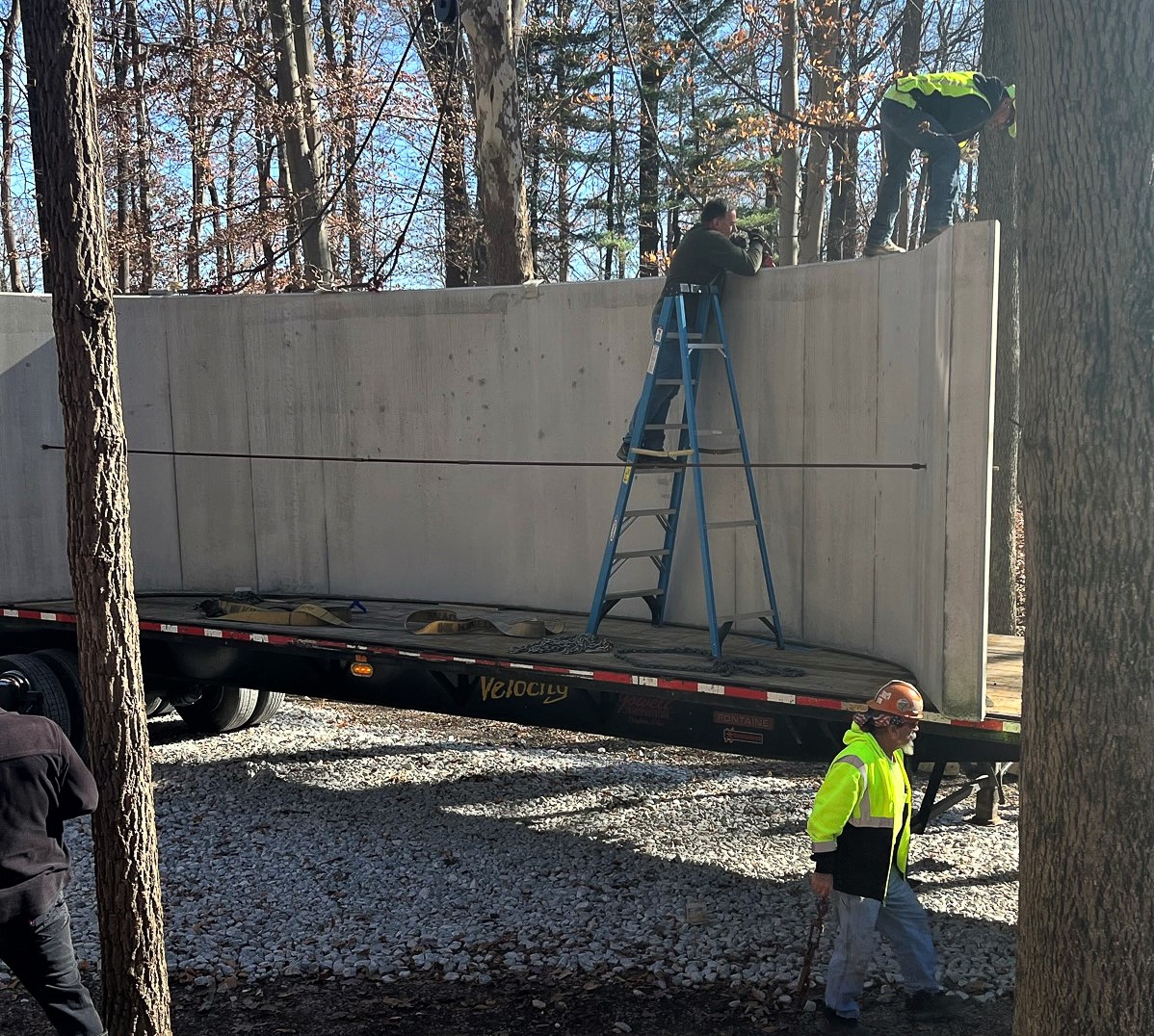

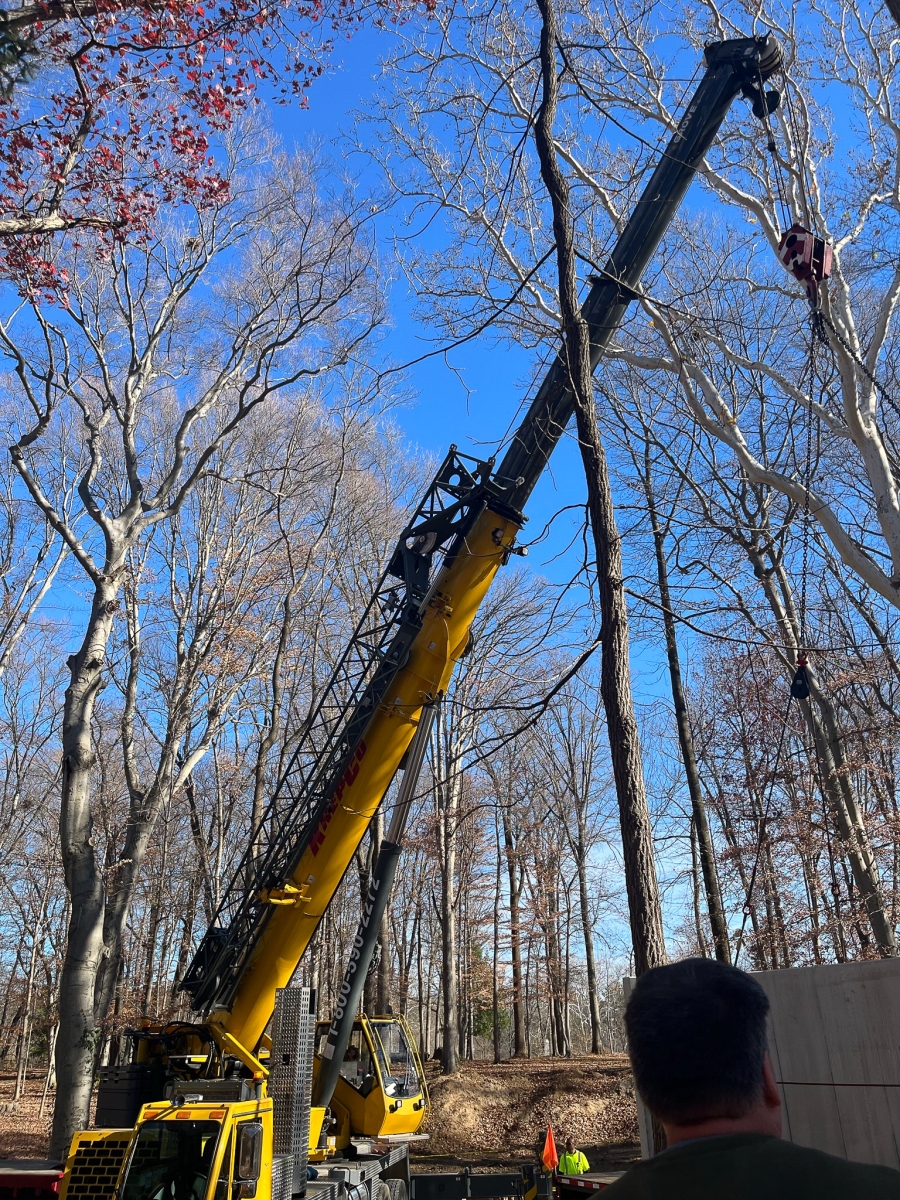

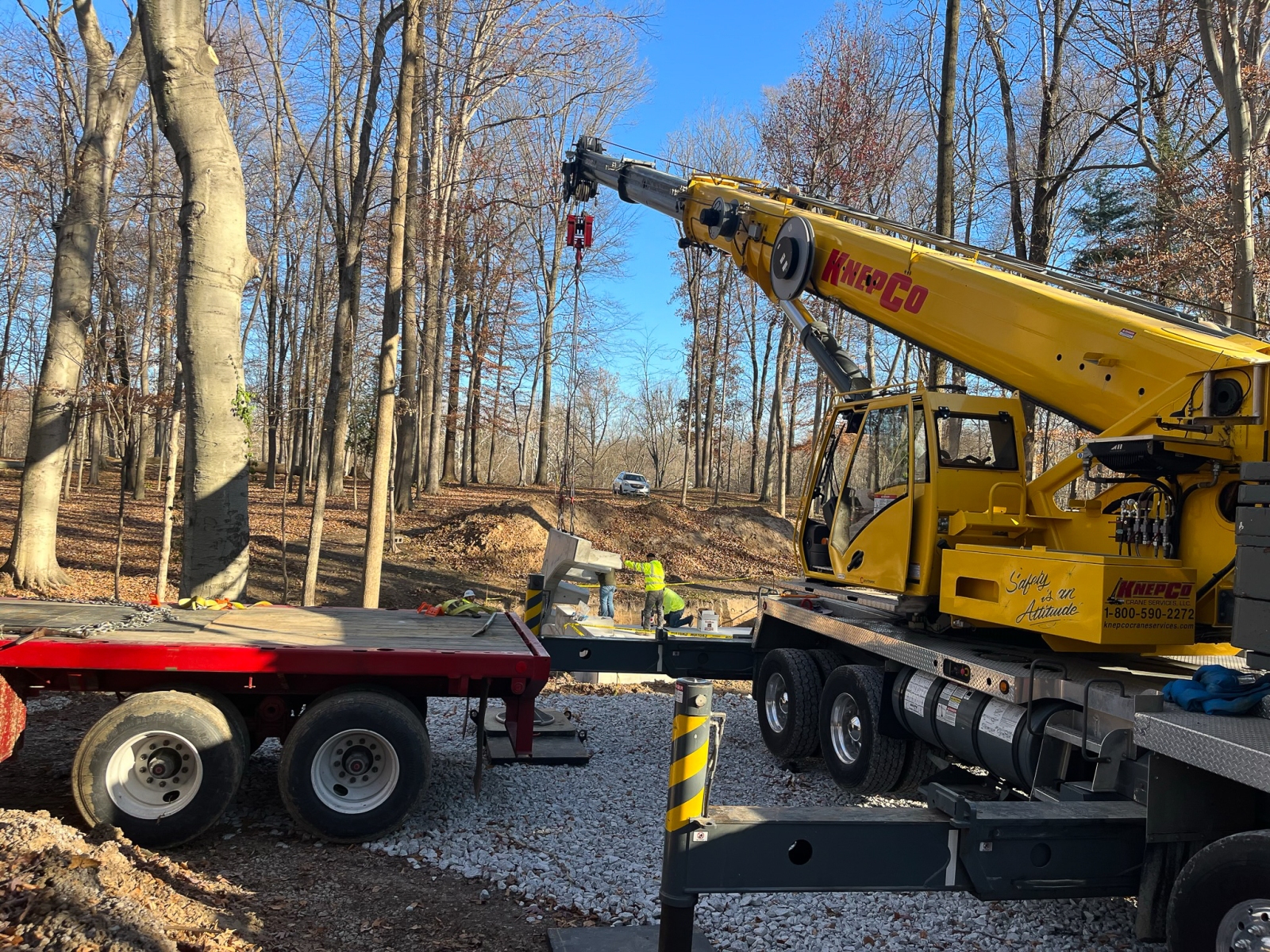

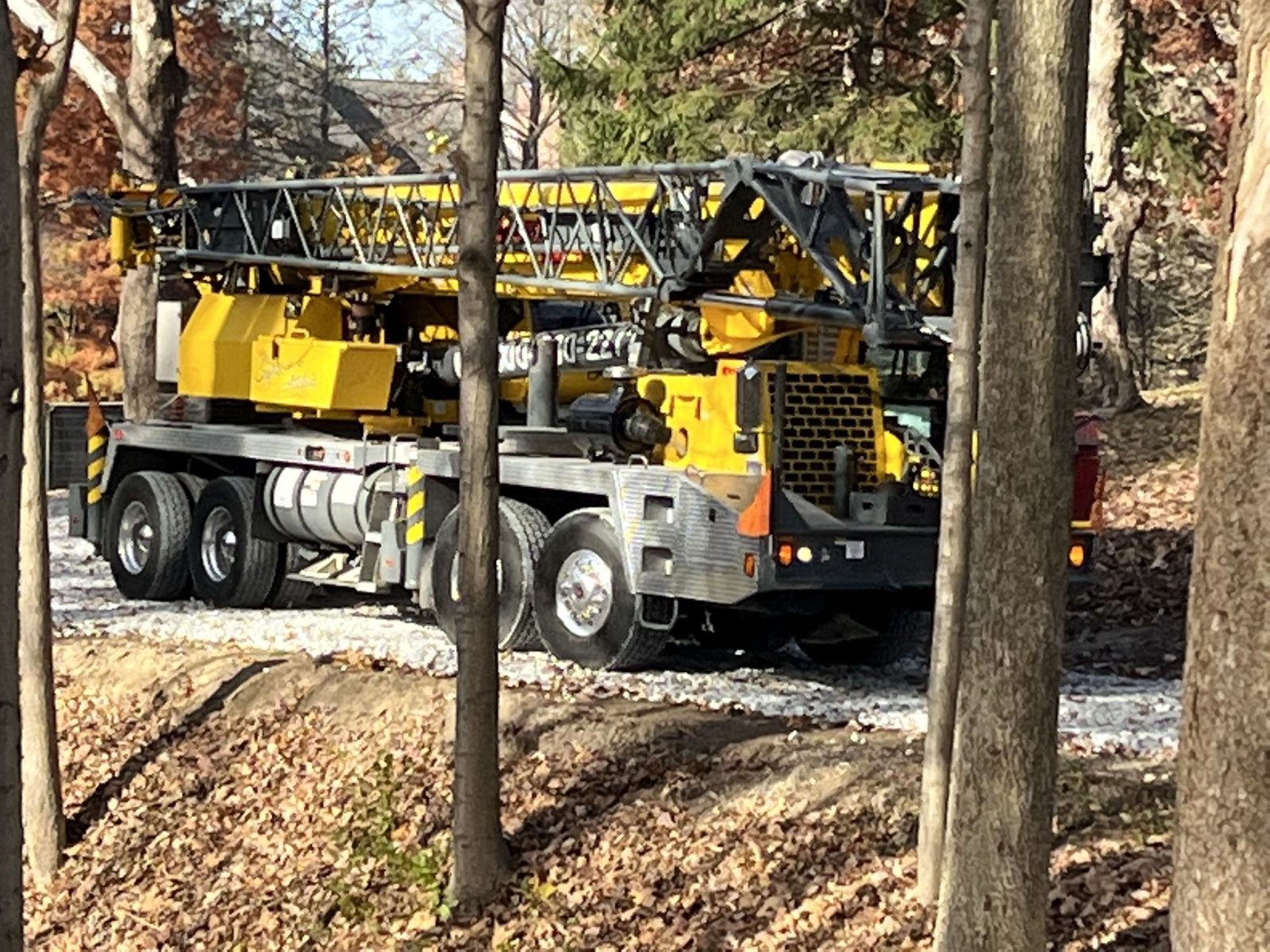

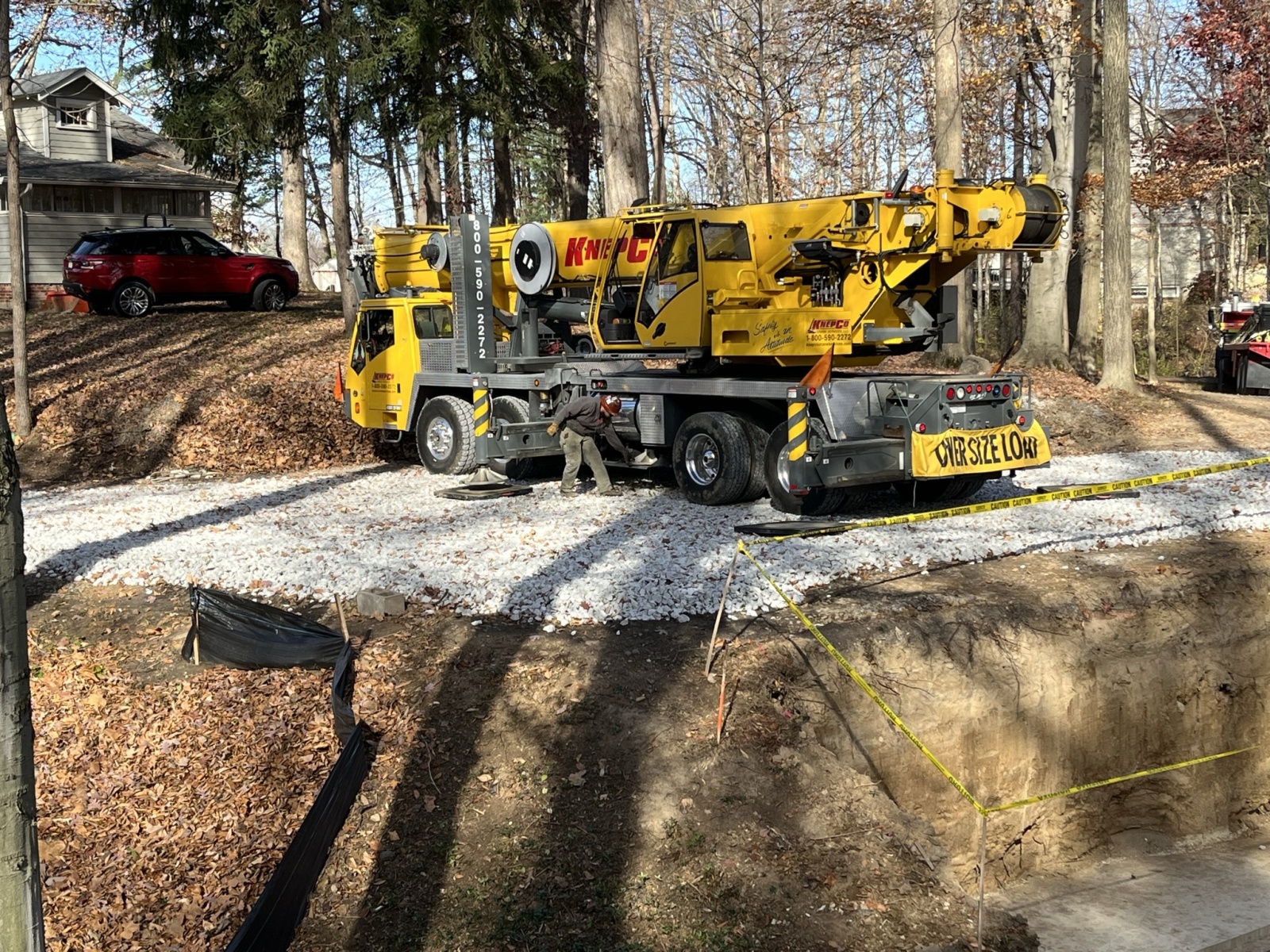

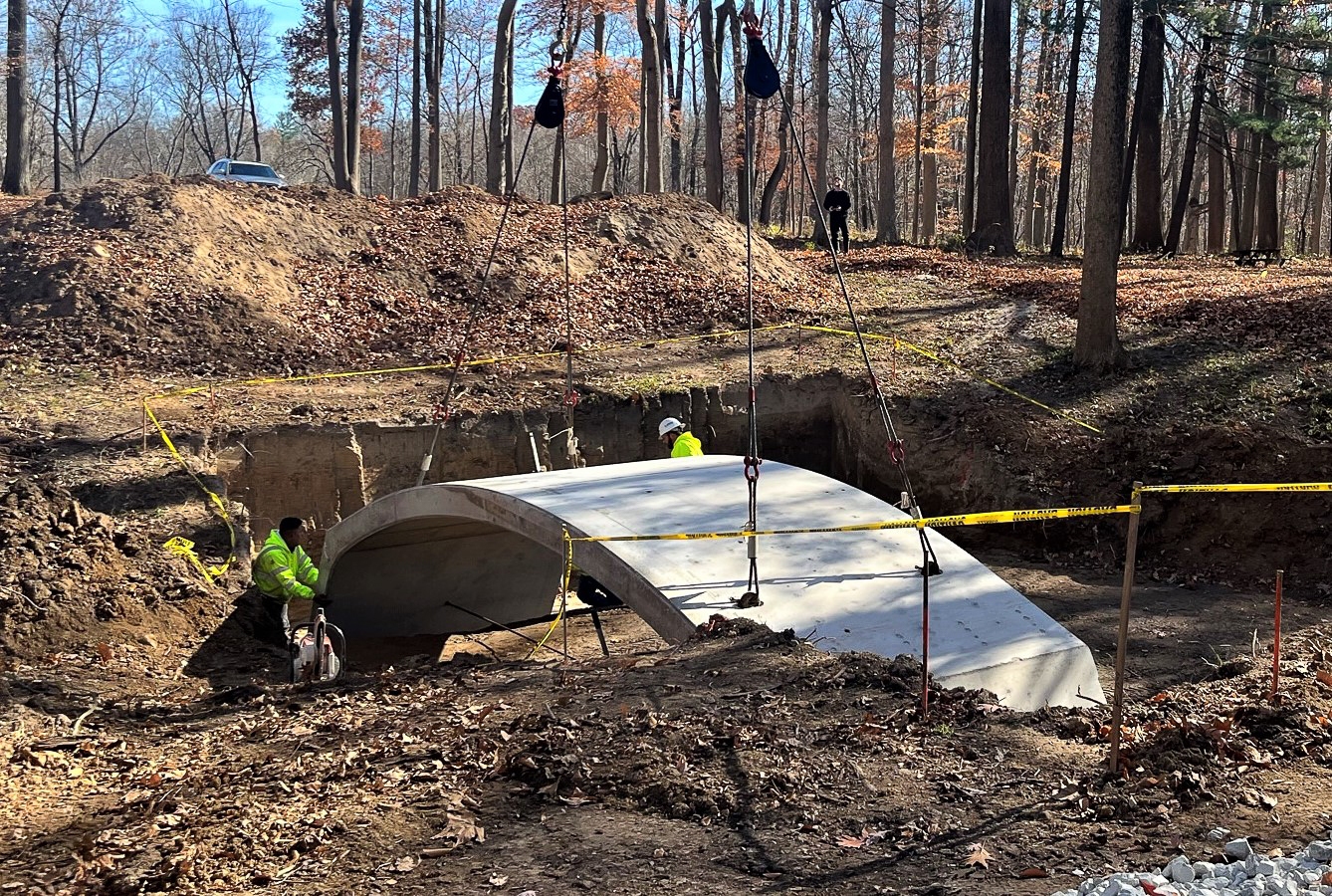

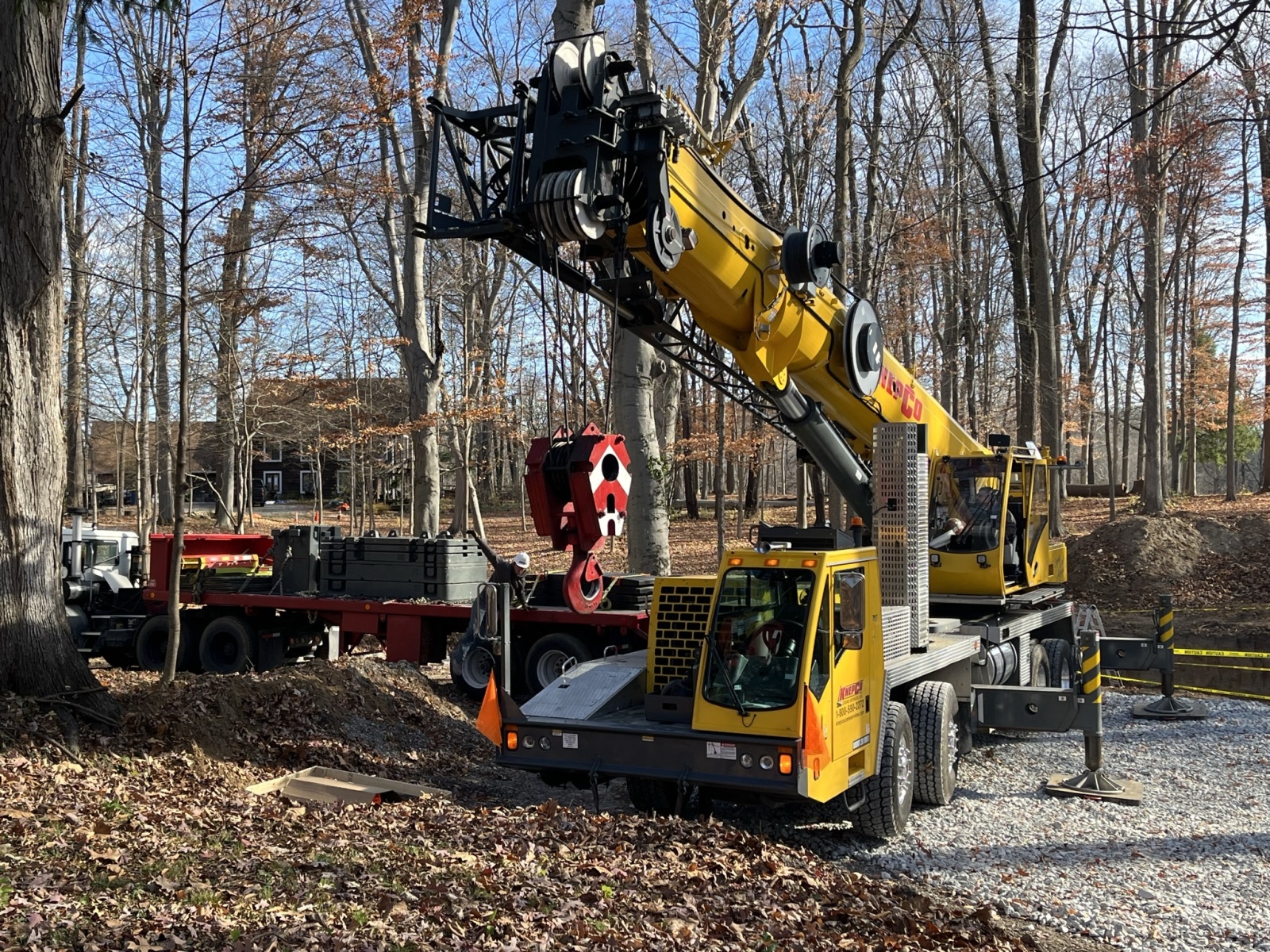

“First bridge section being set into place.”

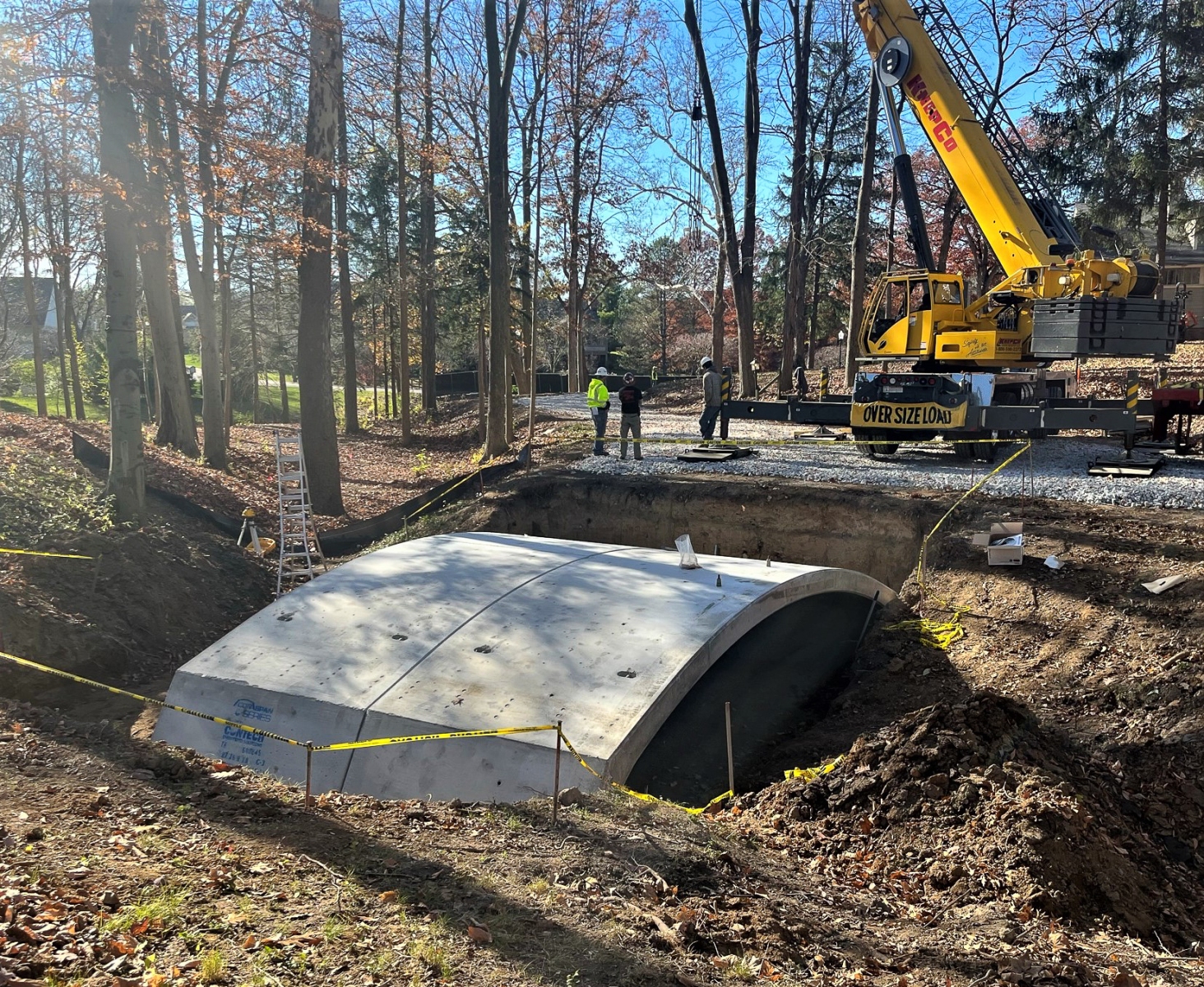

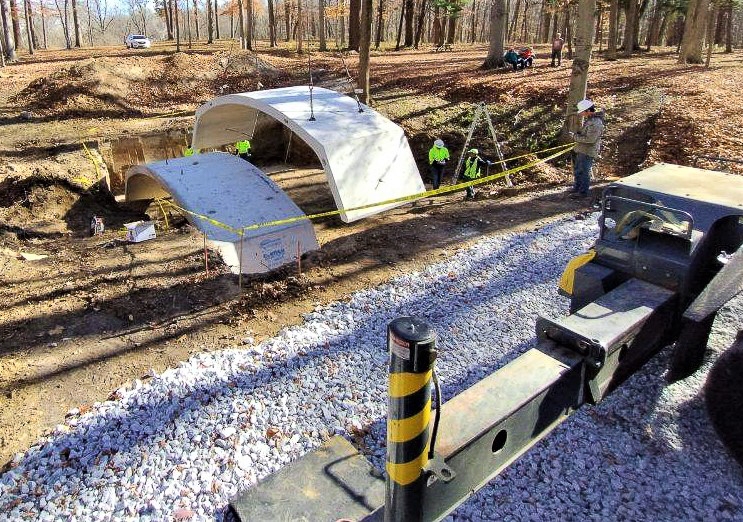

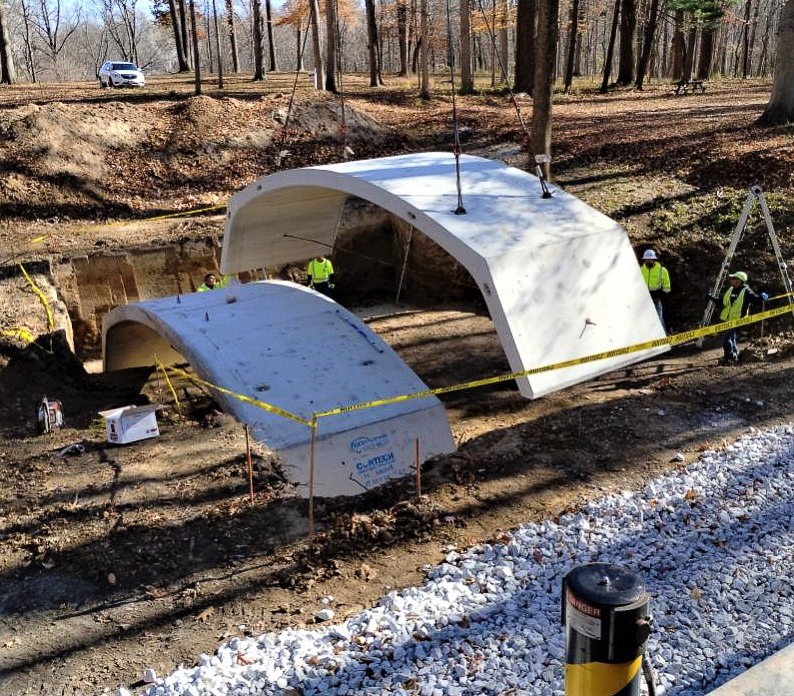

“Section #2 going in.”

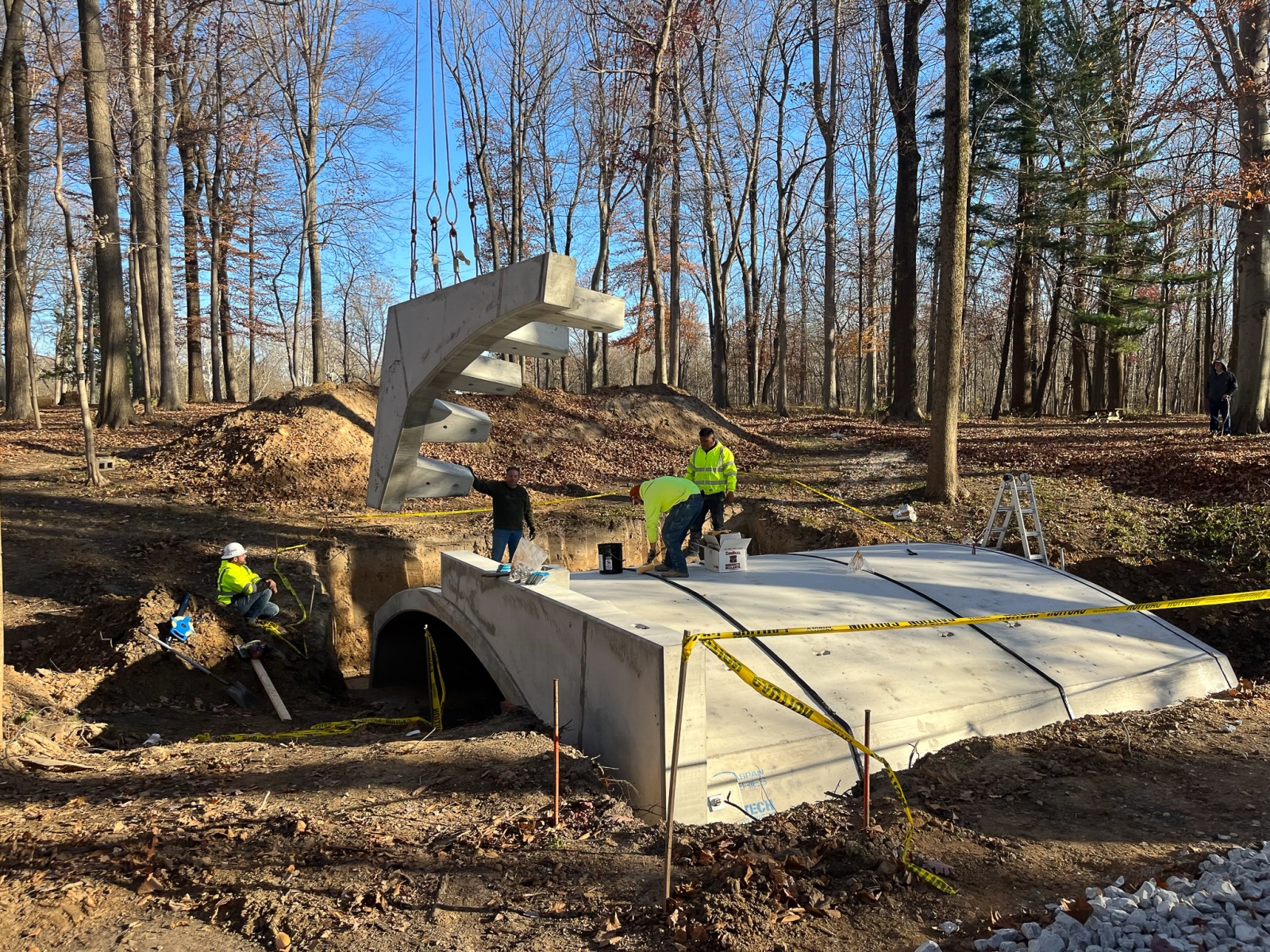

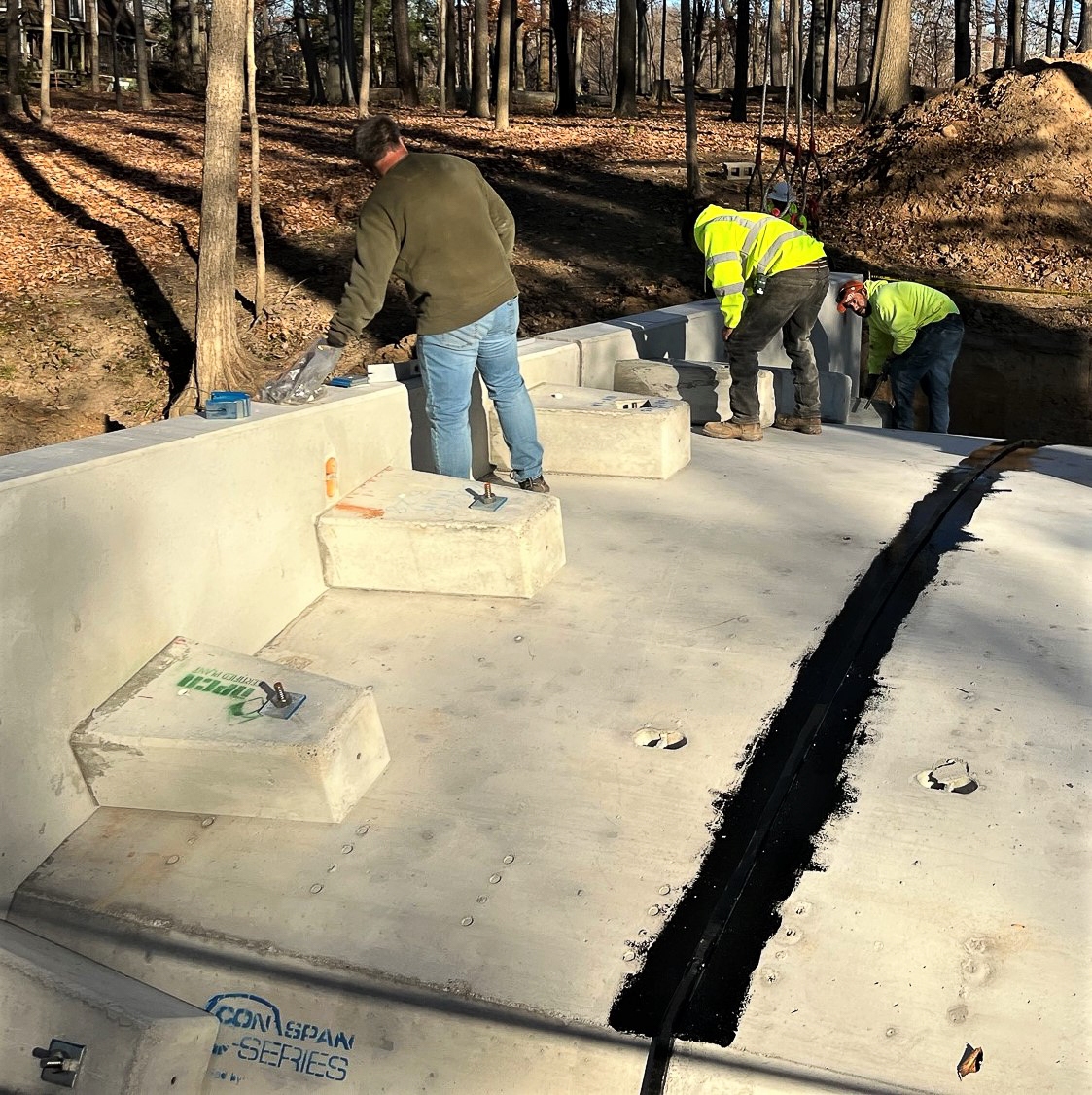

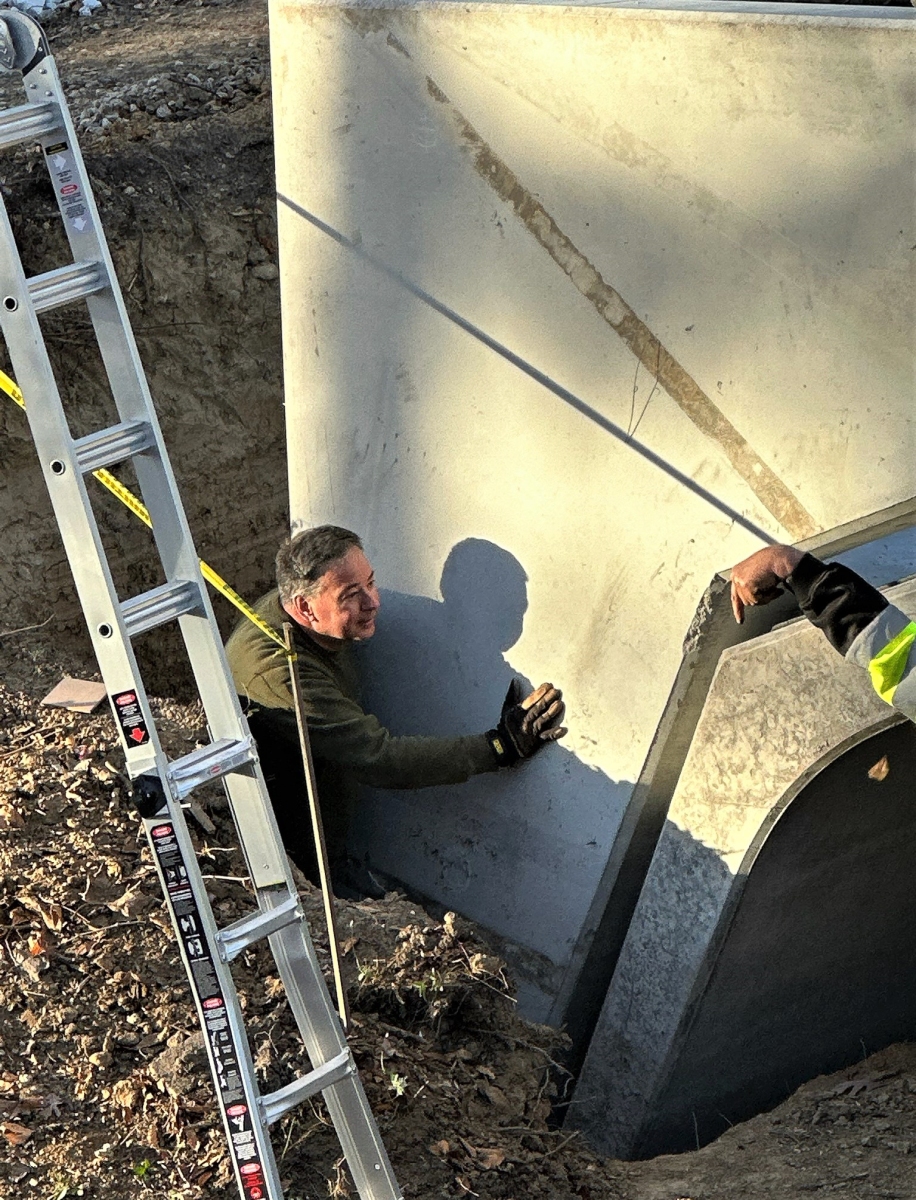

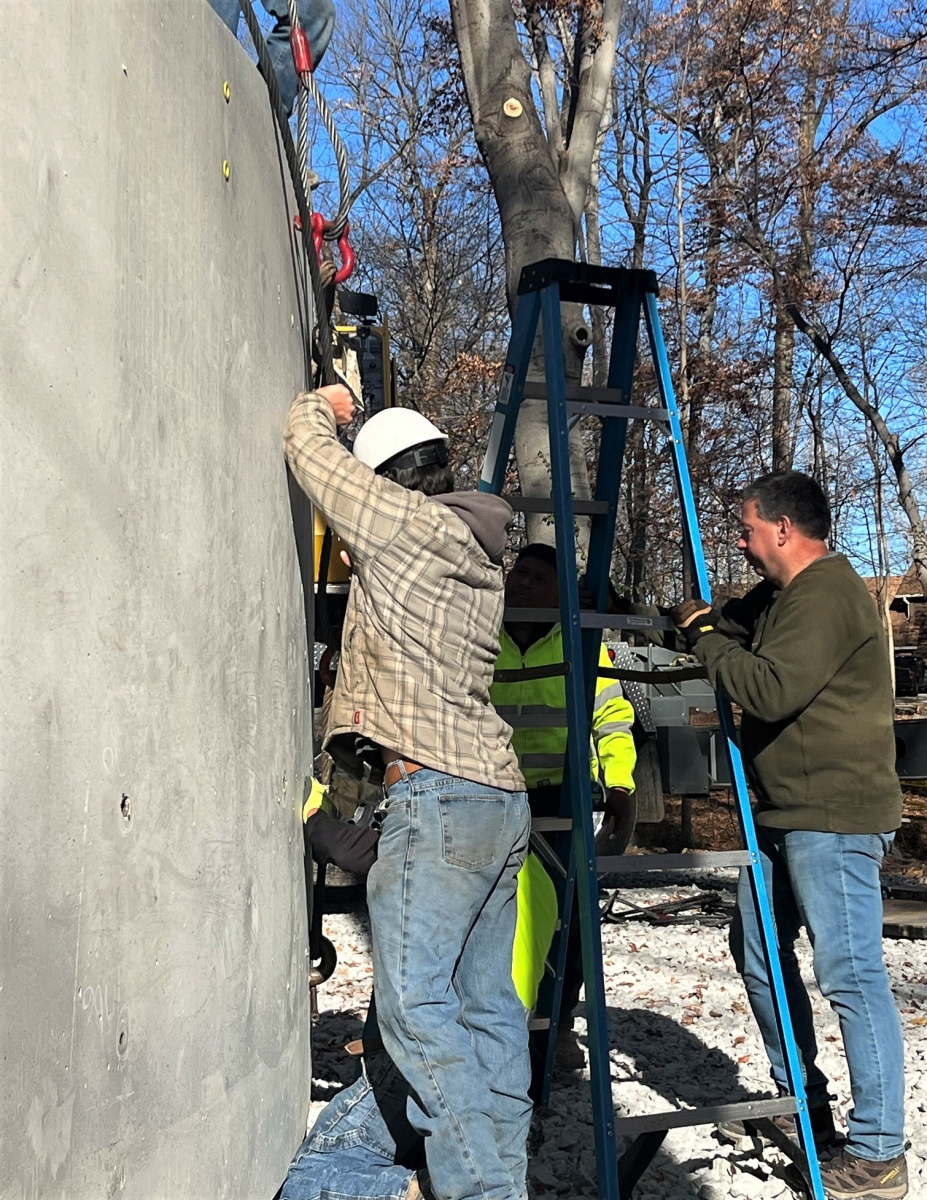

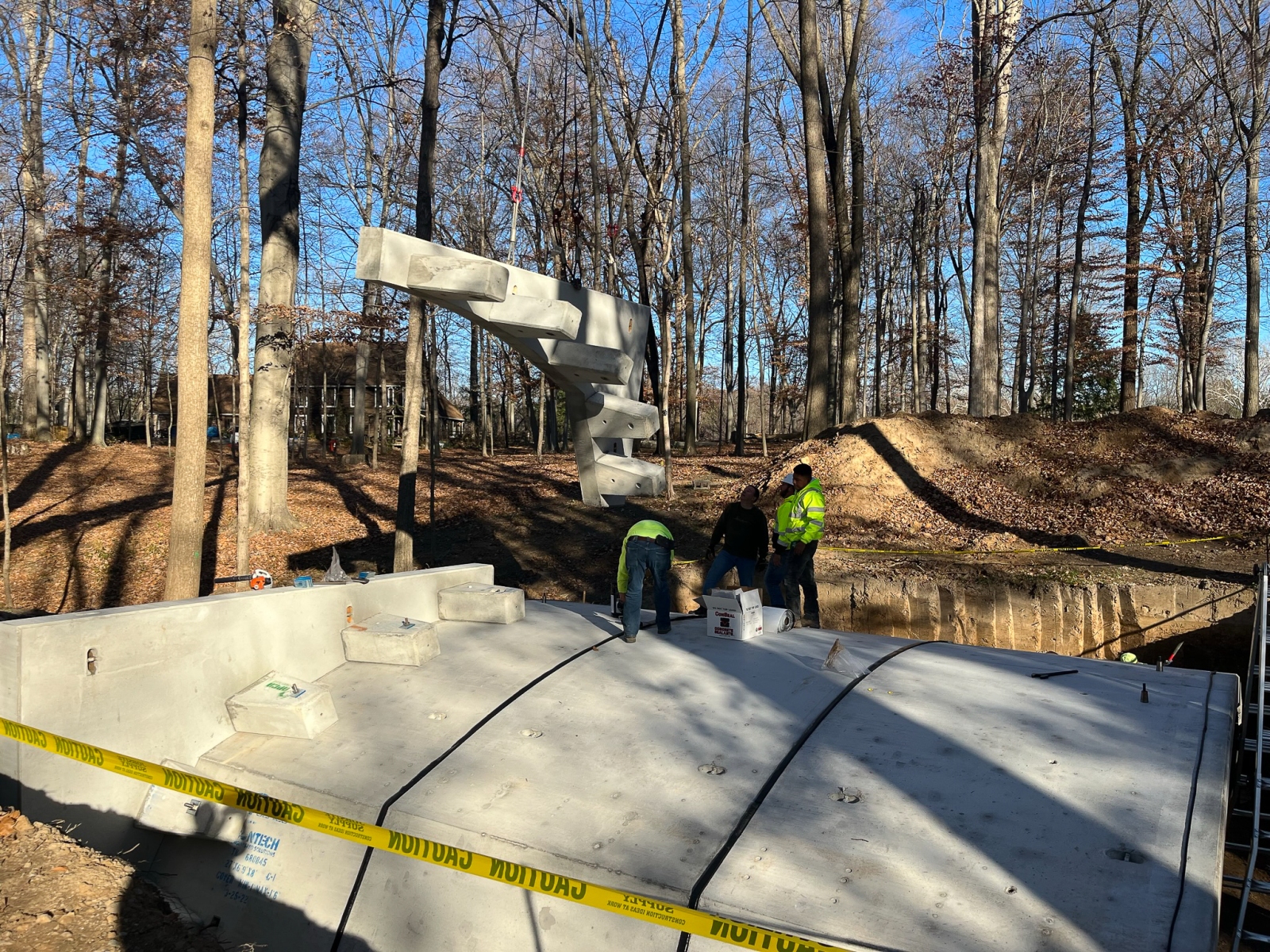

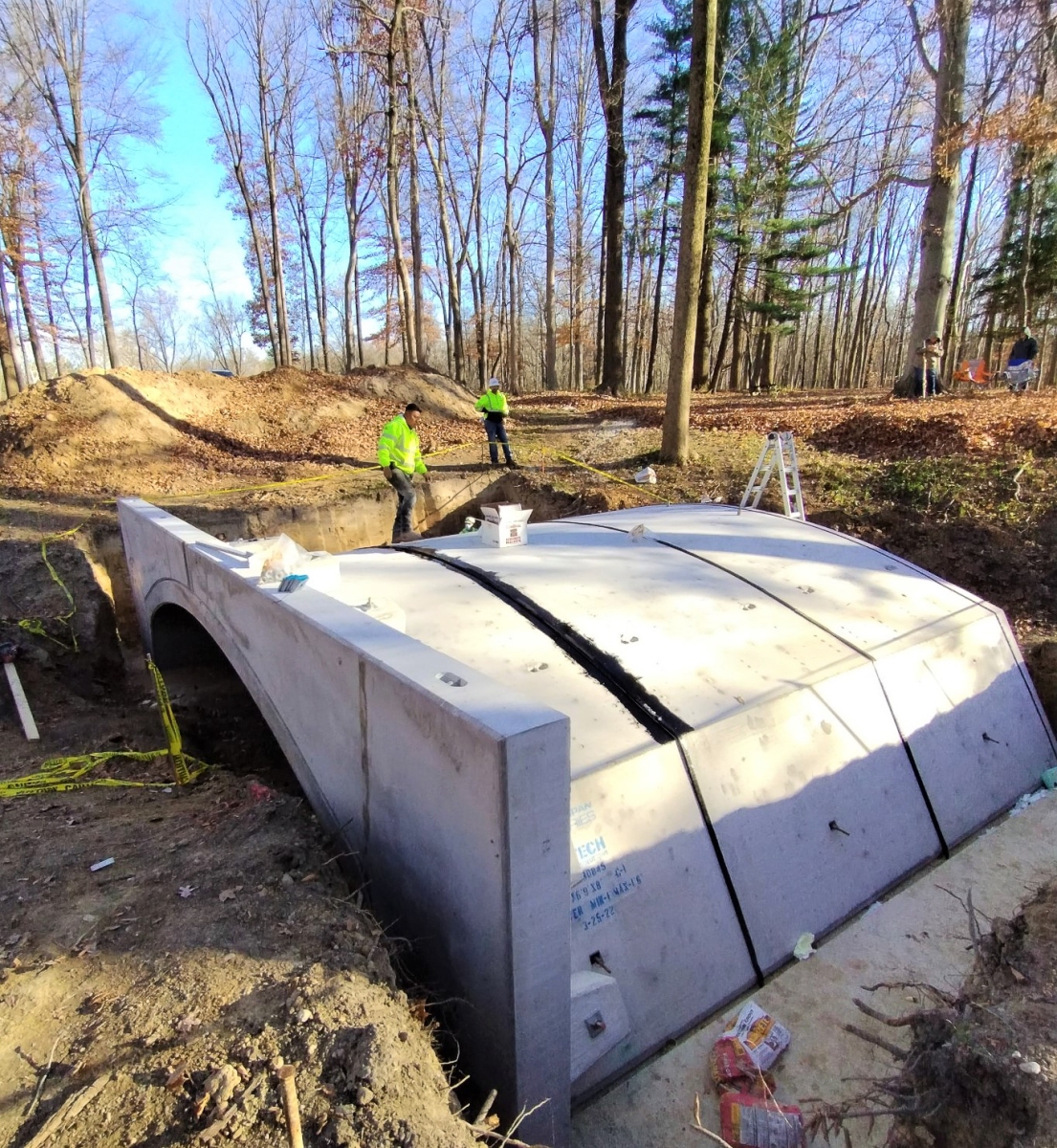

“Third section, and then the head-walls. Each section weighs 18 tons, the head walls are 7 tons apiece.”

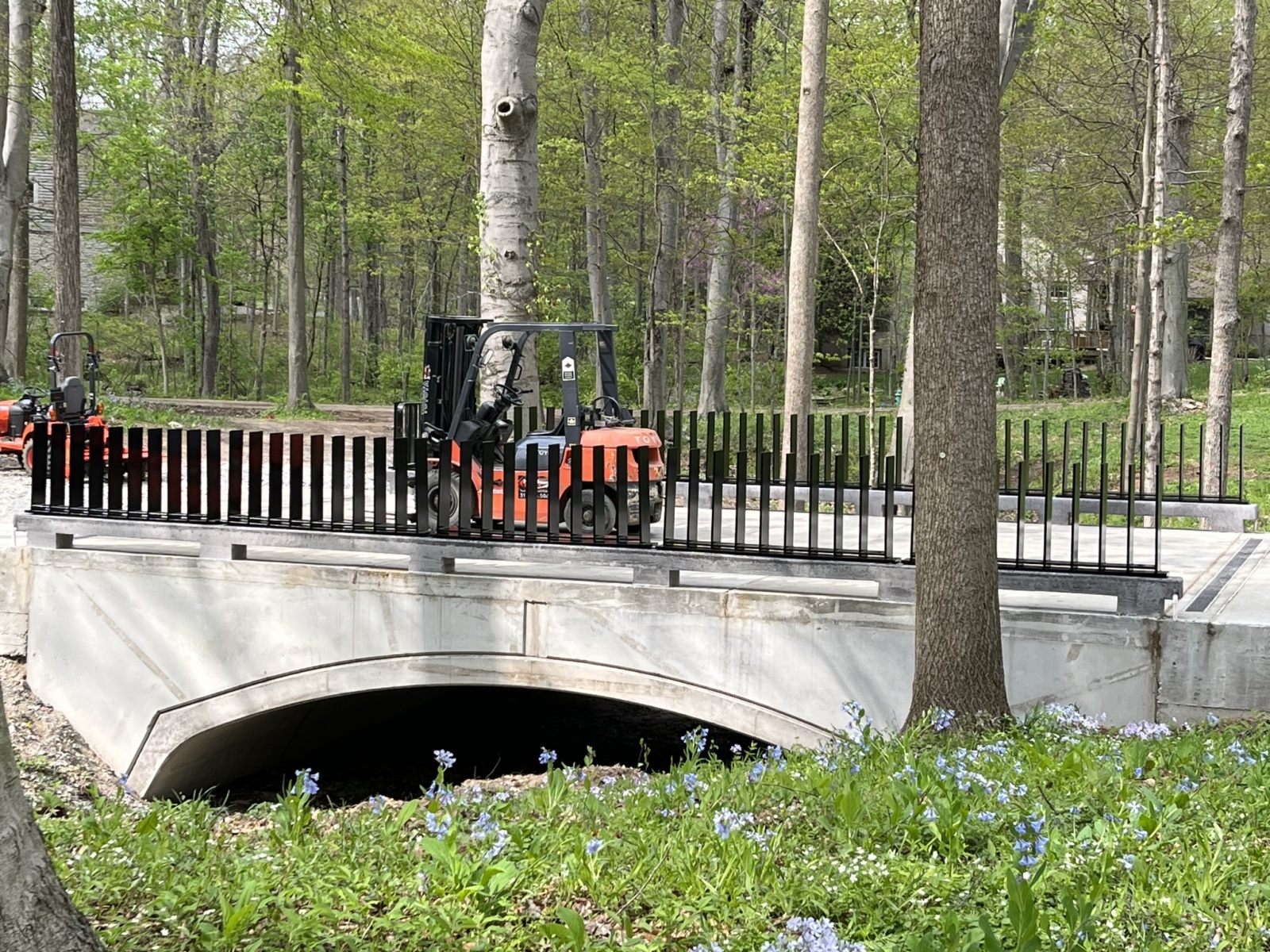

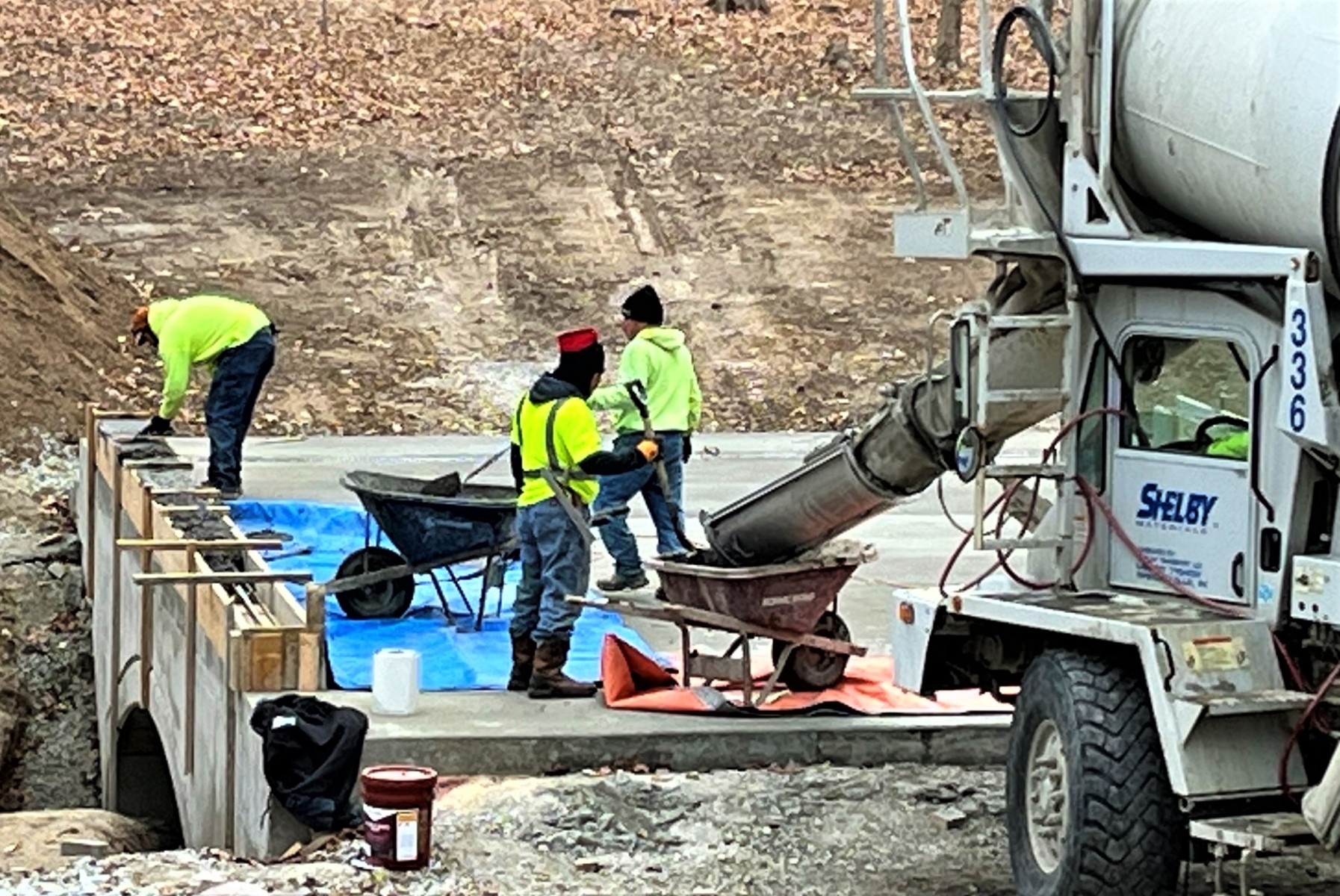

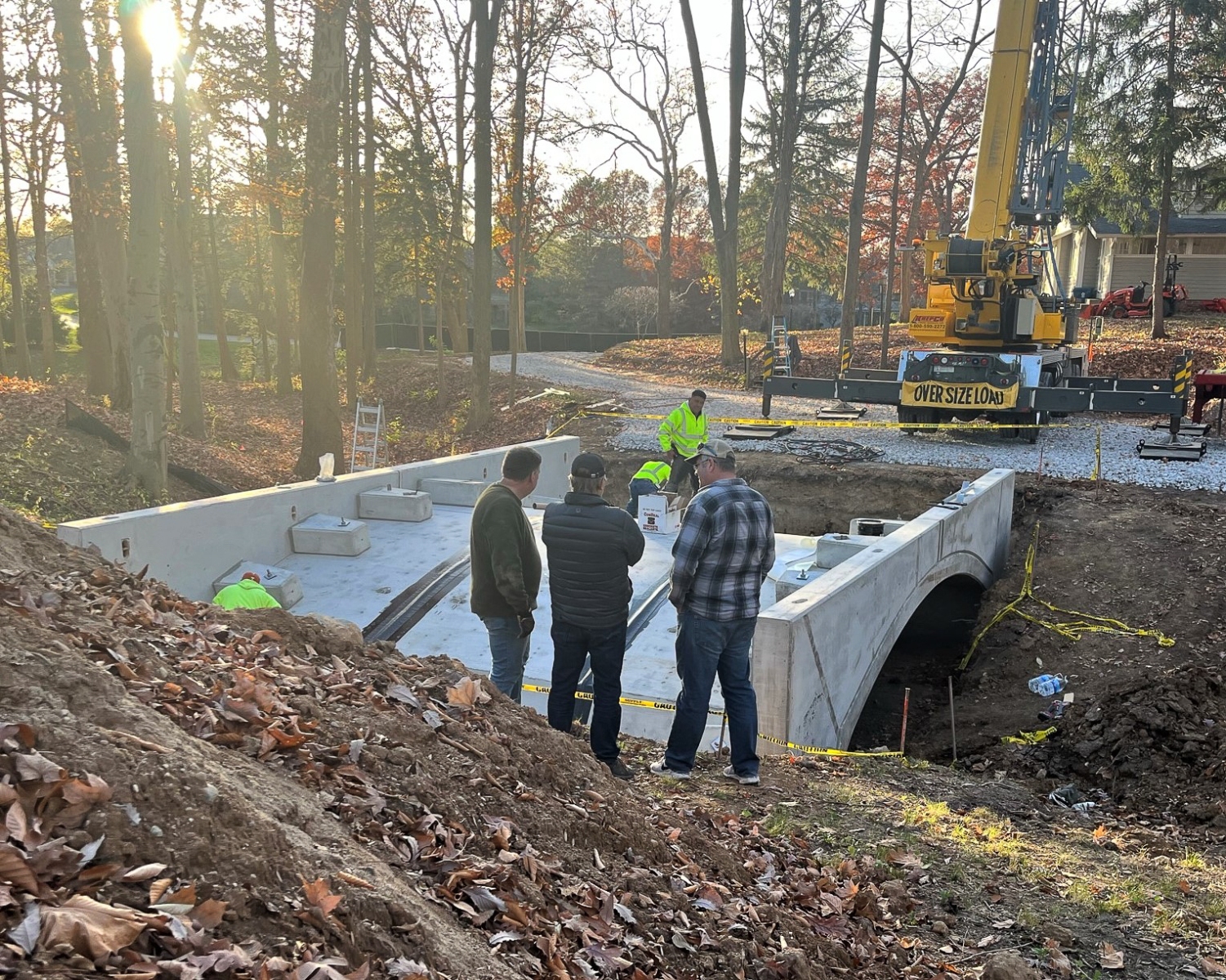

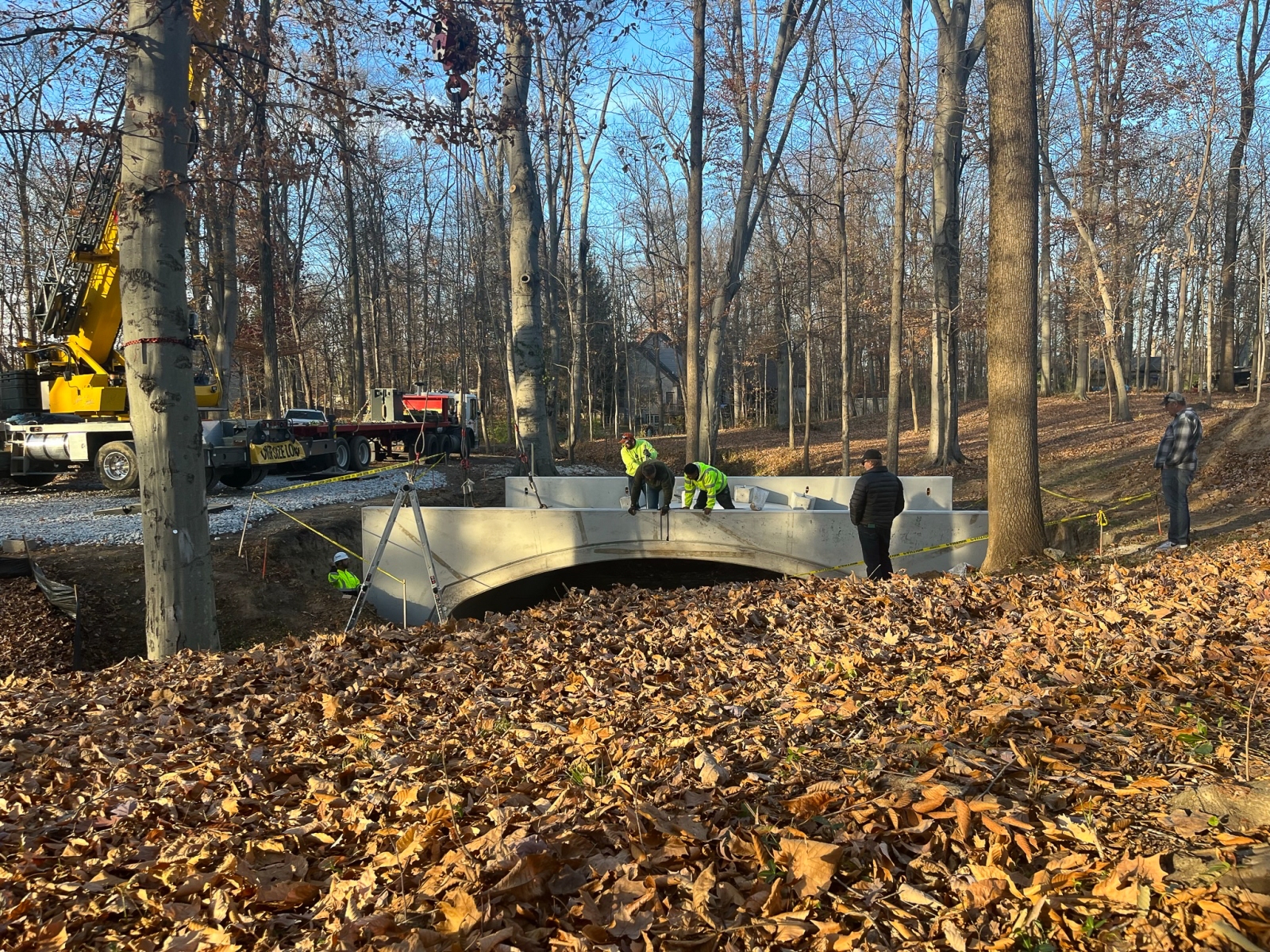

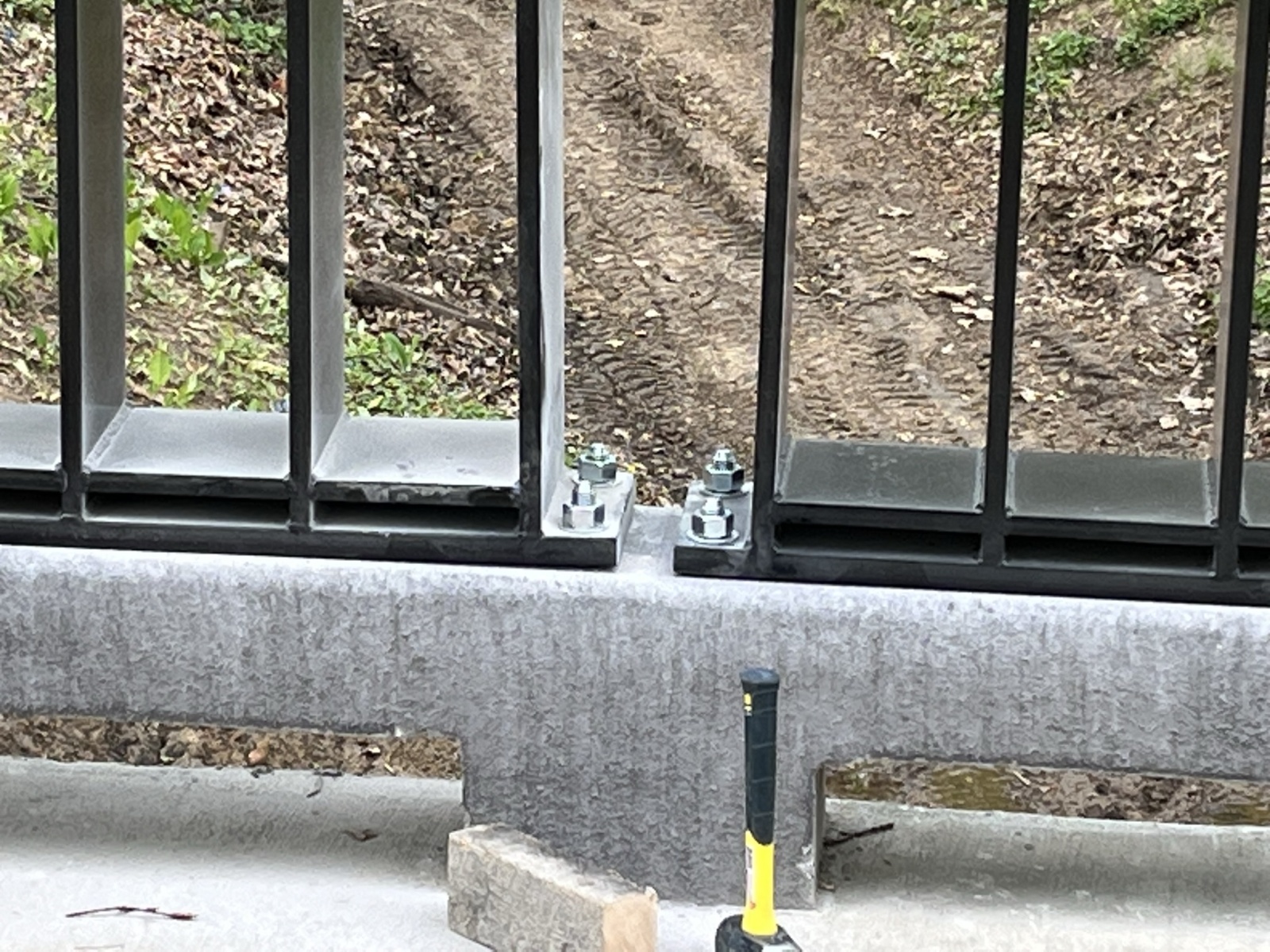

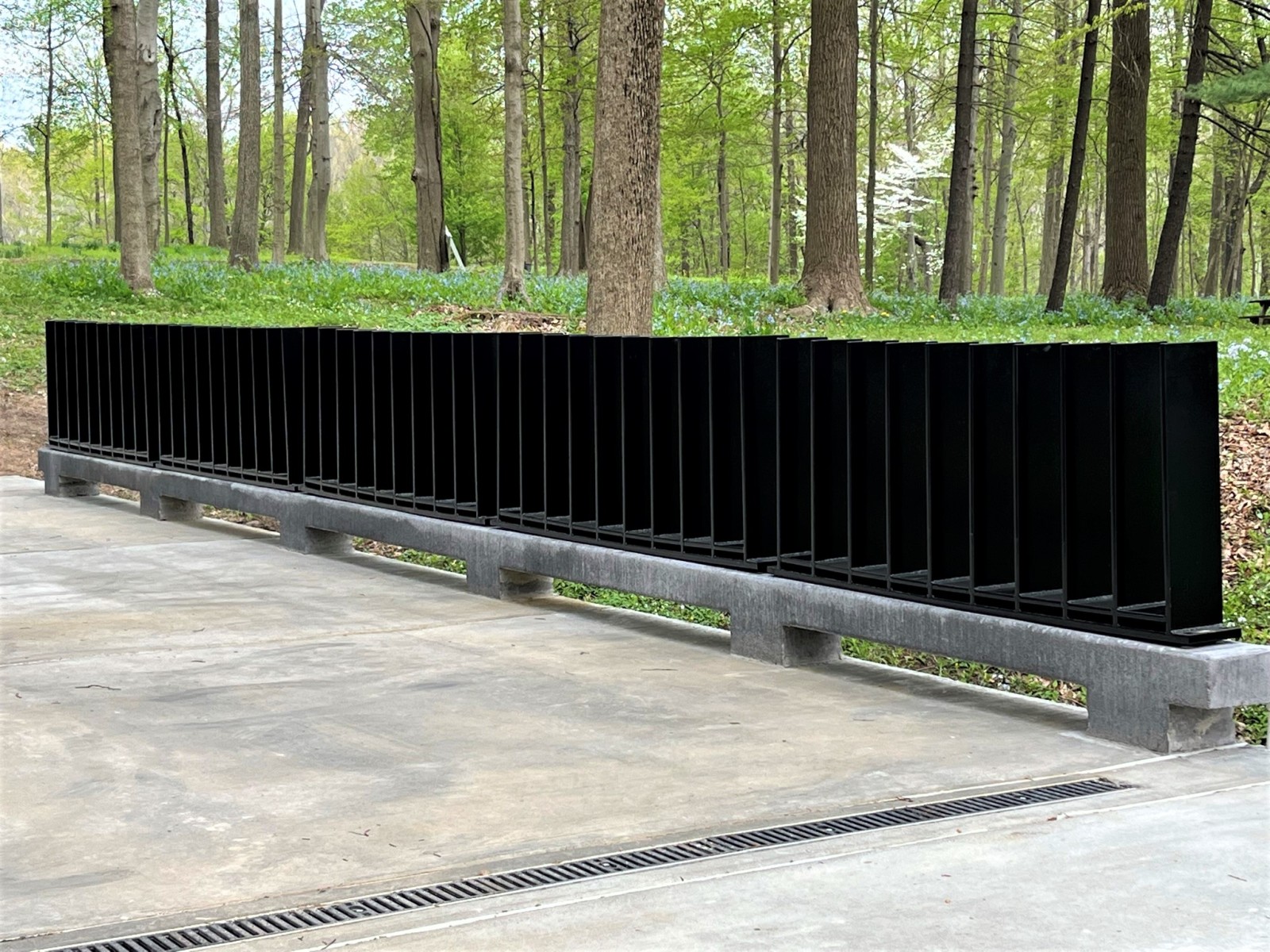

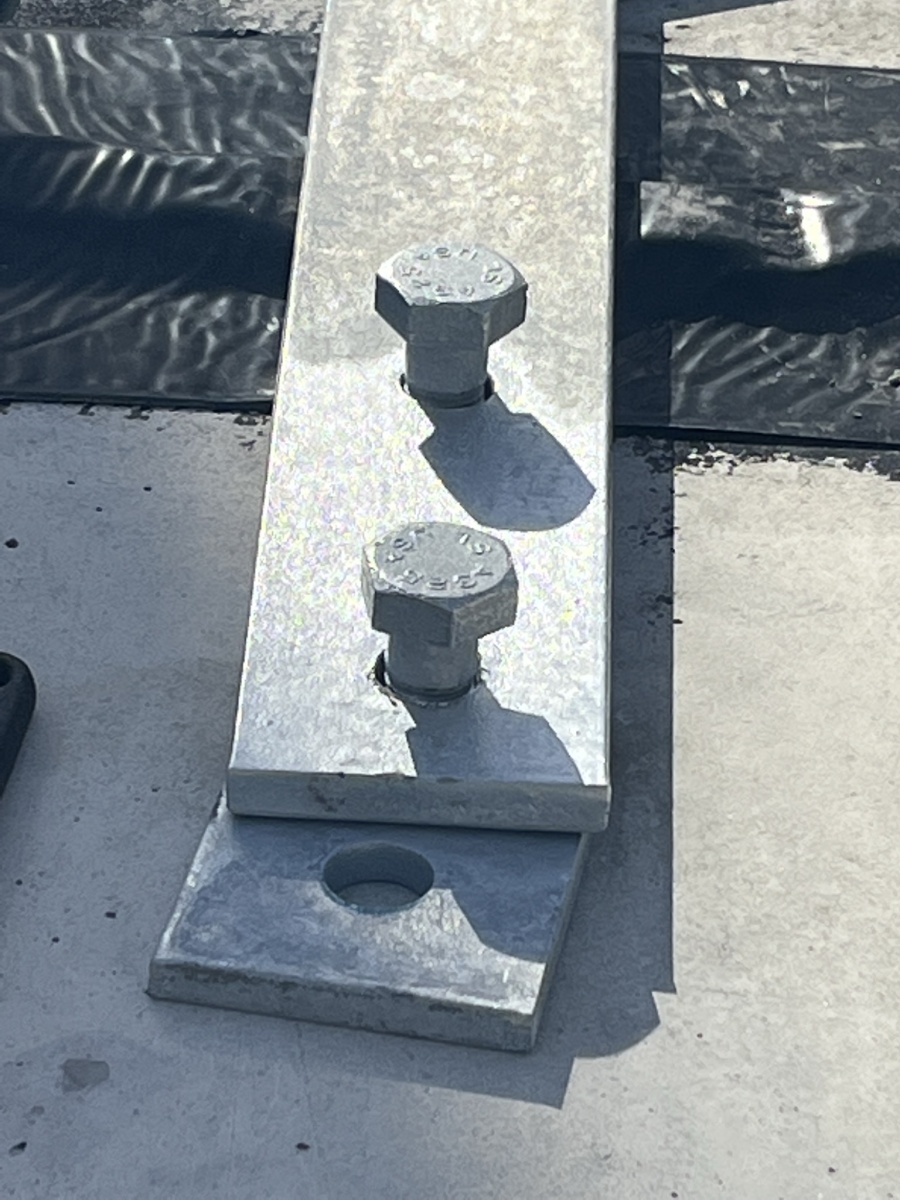

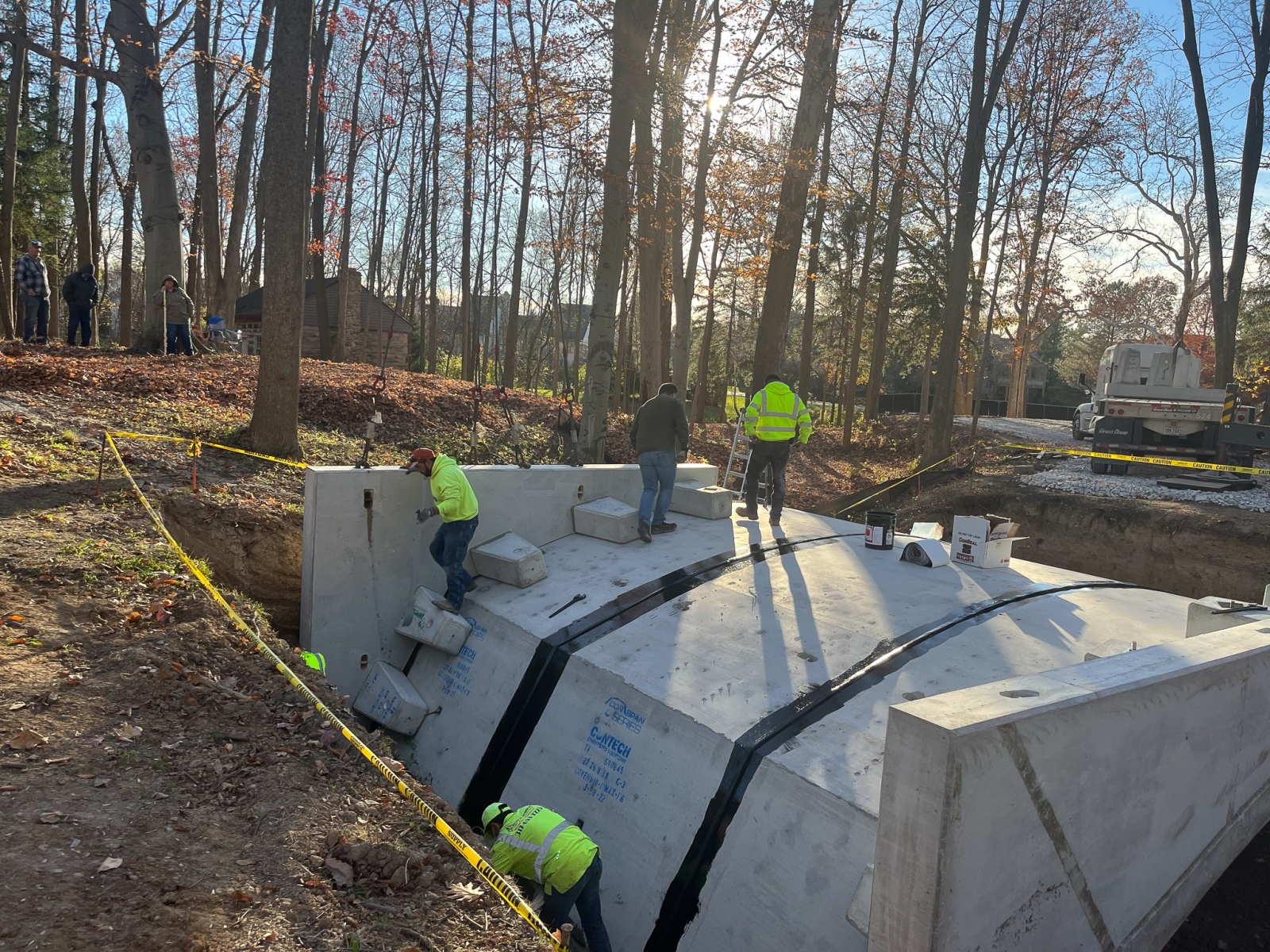

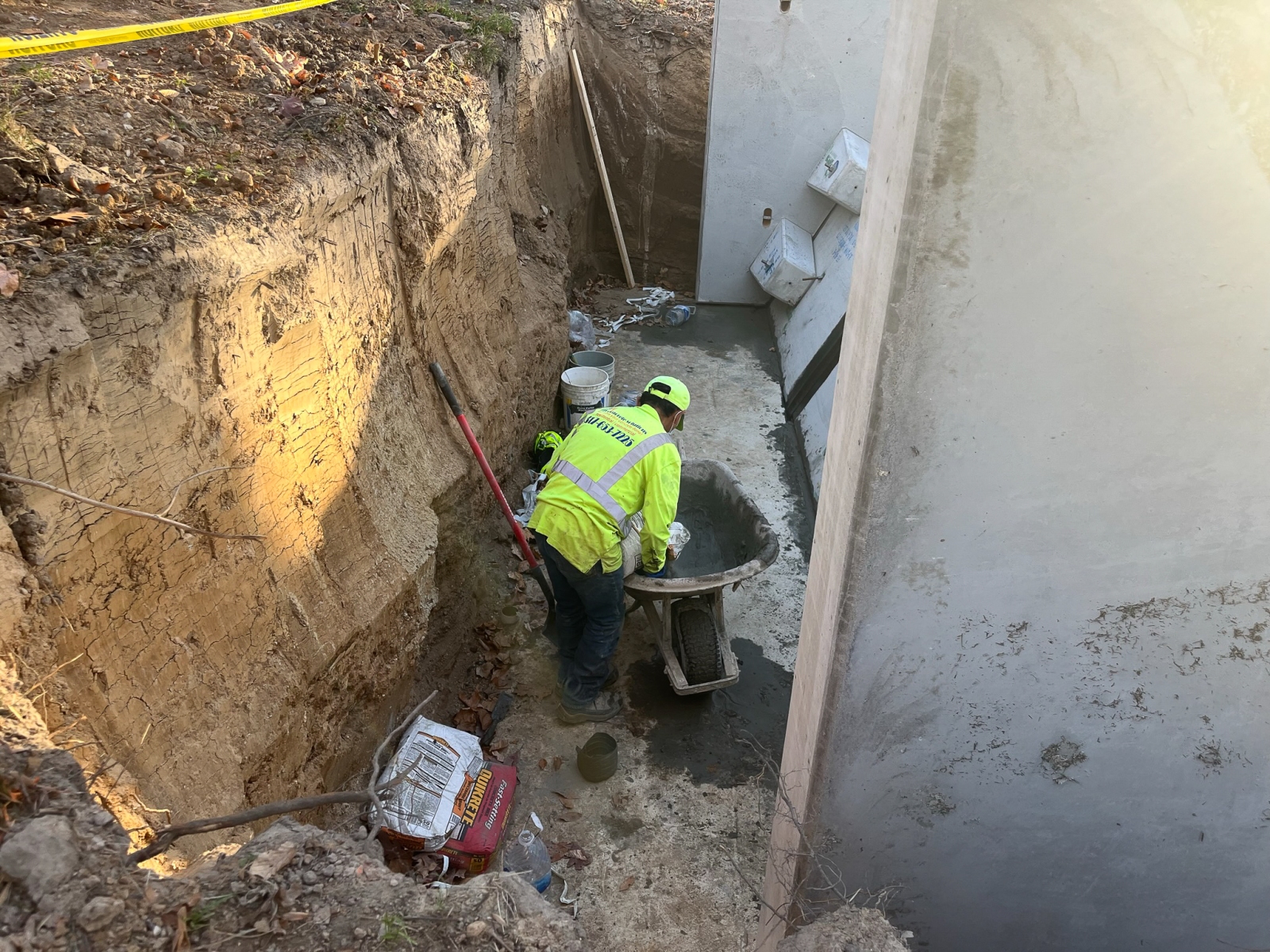

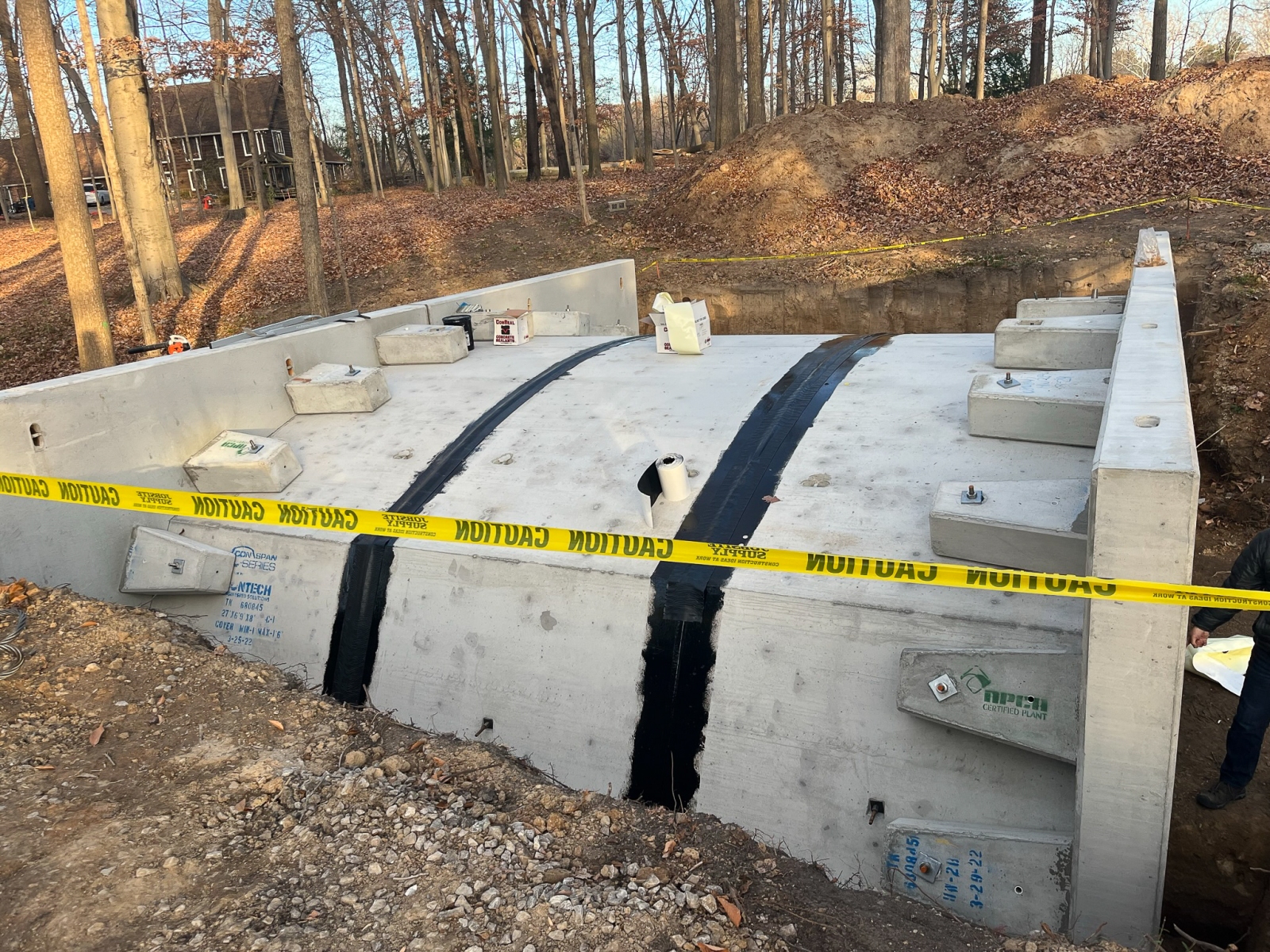

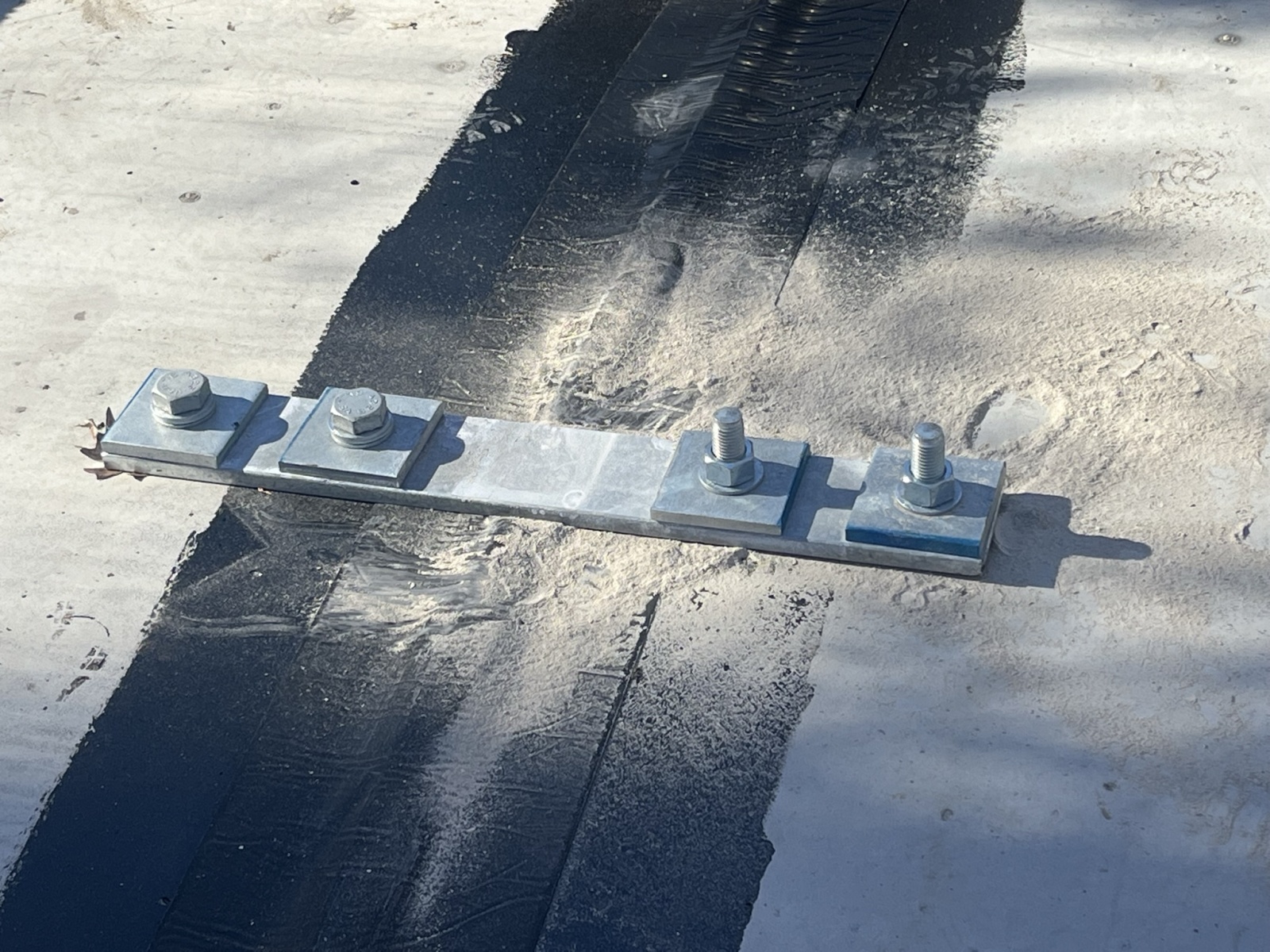

“Sealing and grouting the sections together, and to the foundations.”

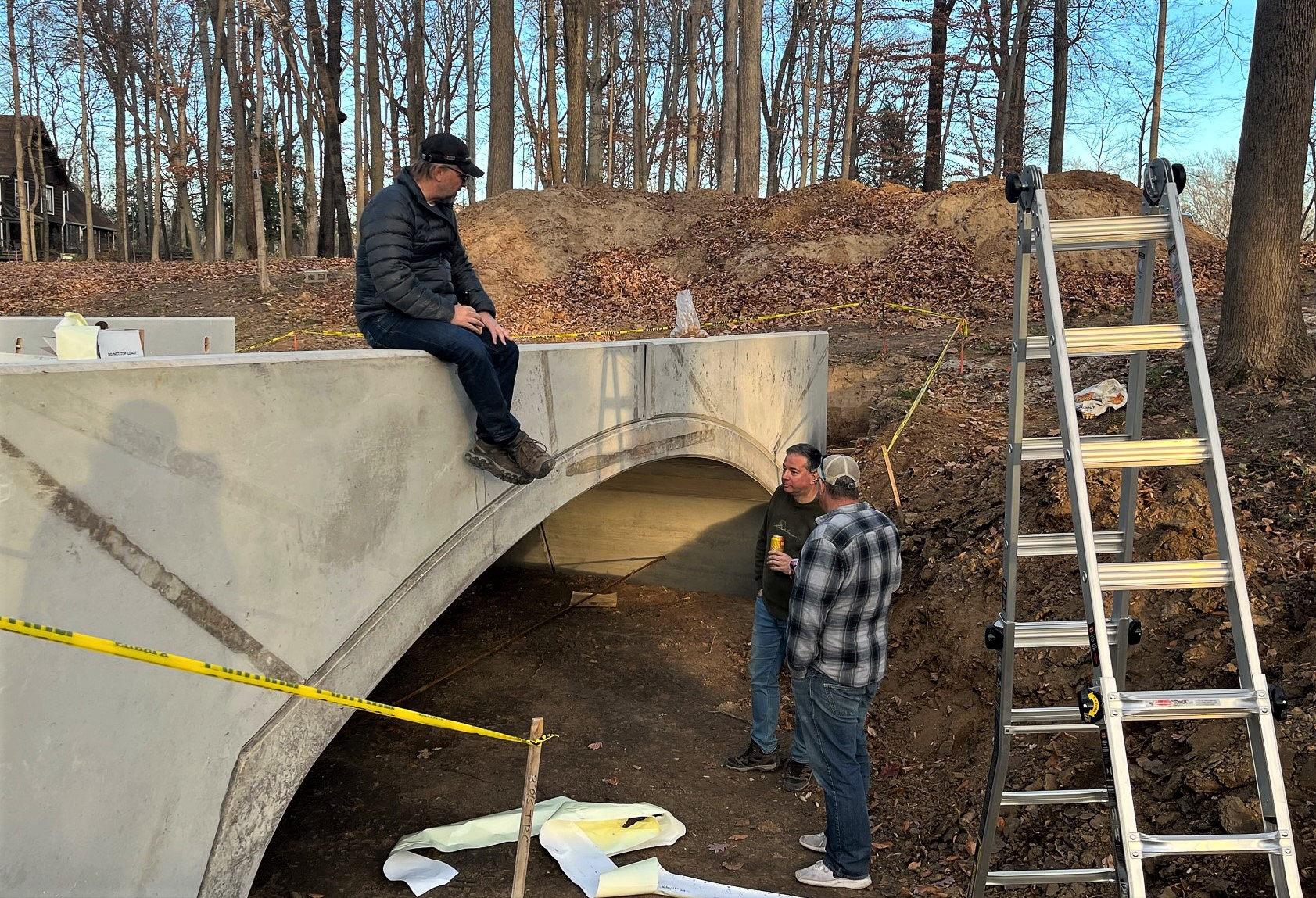

“Whew, time for a beer.”

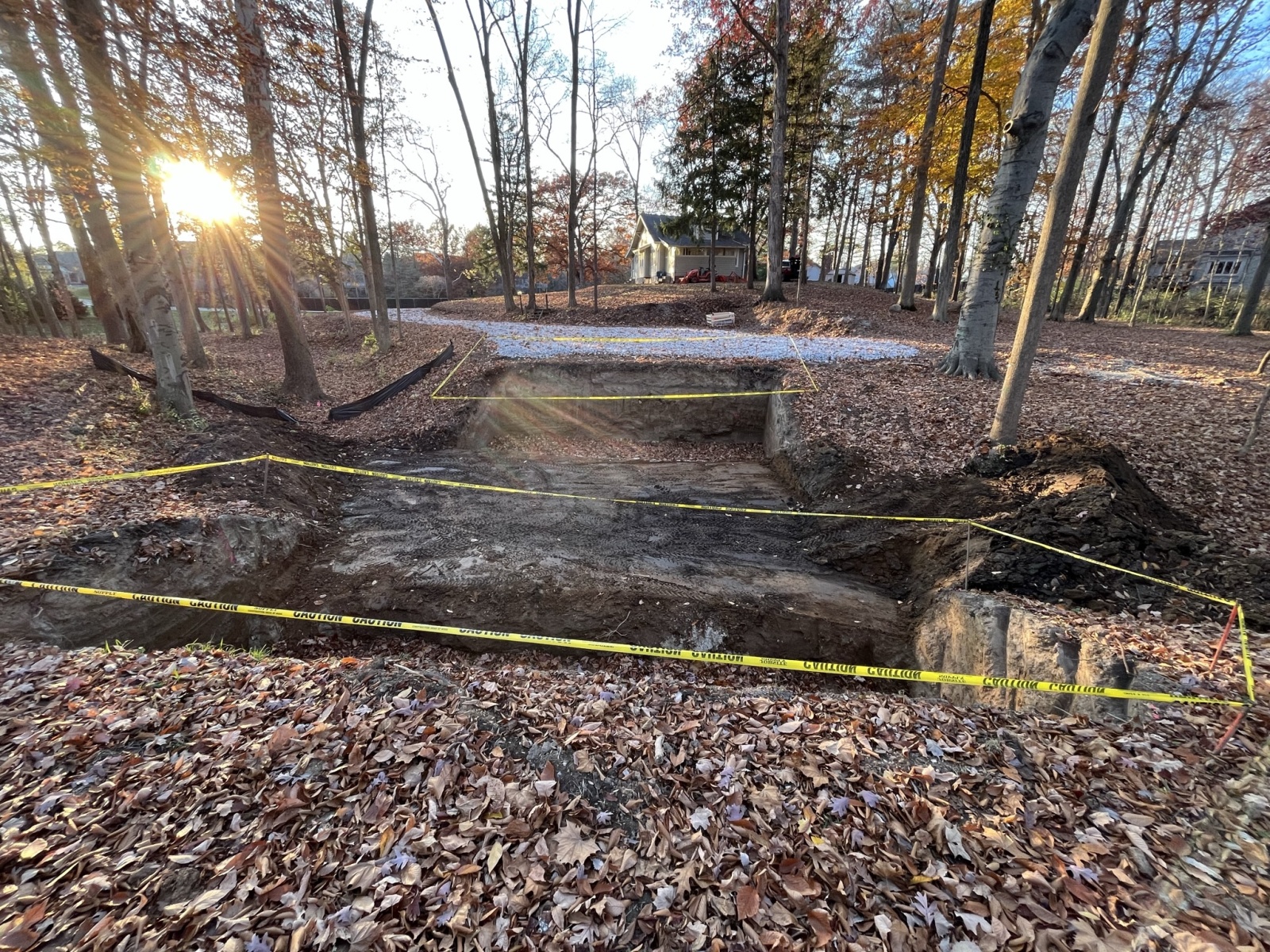

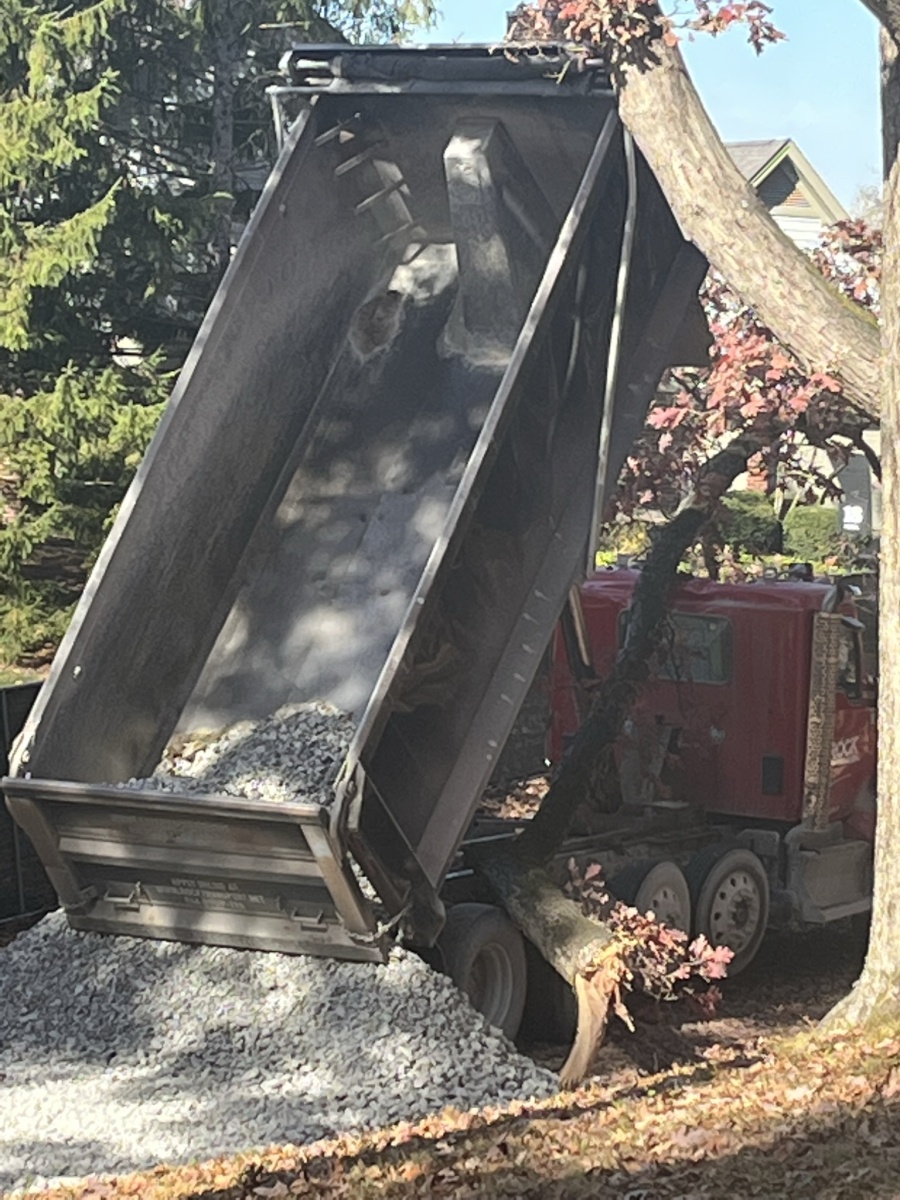

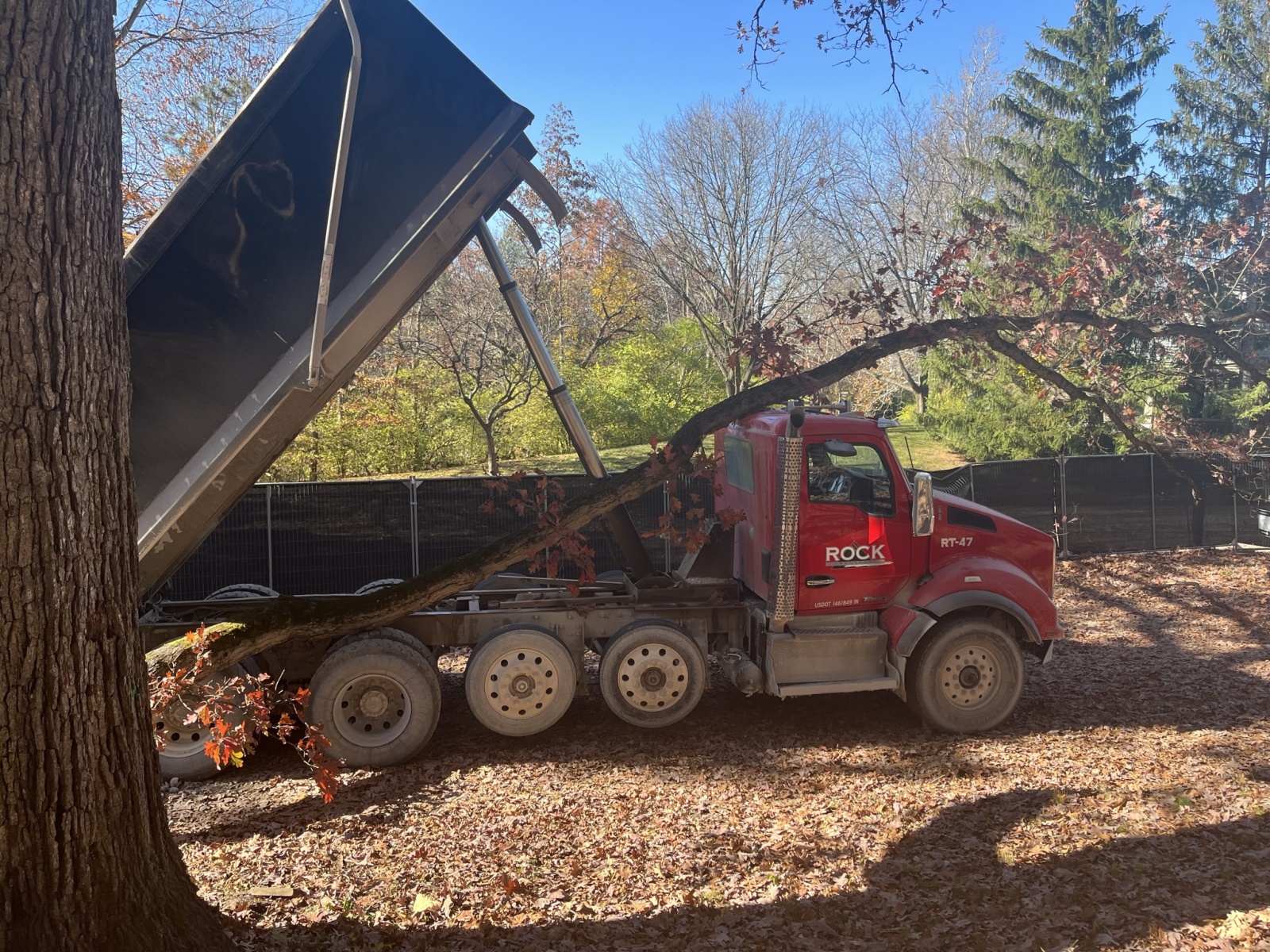

A large pile of new rock is ready to be used in the construction of the bridge. The rock is placed in a large open area, surrounded by some trees and shrubs. The sky is bright and clear, & the construction process is about to begin. The new rock glitters in the sunlight, hinting at the bright future ahead for this project.

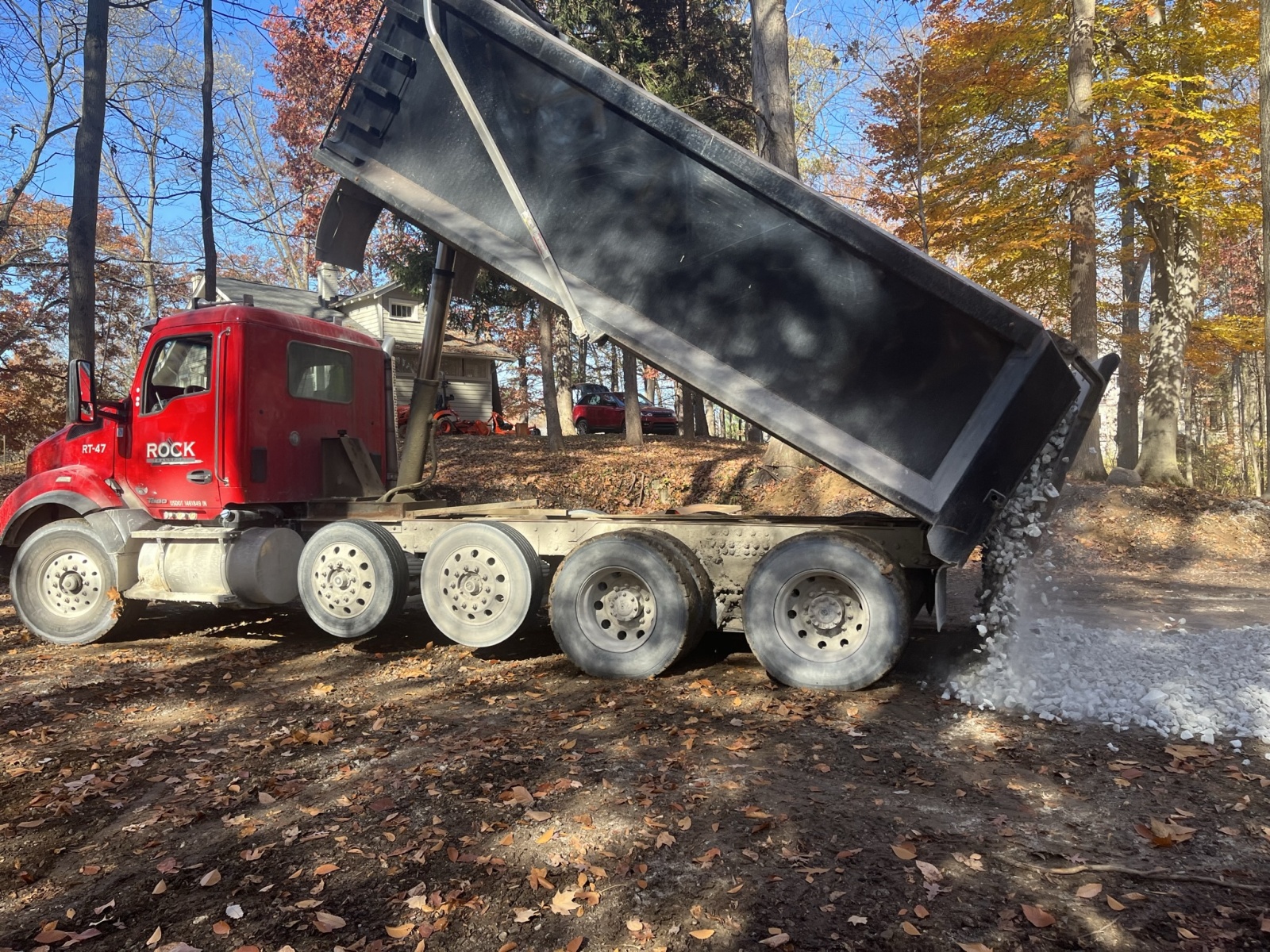

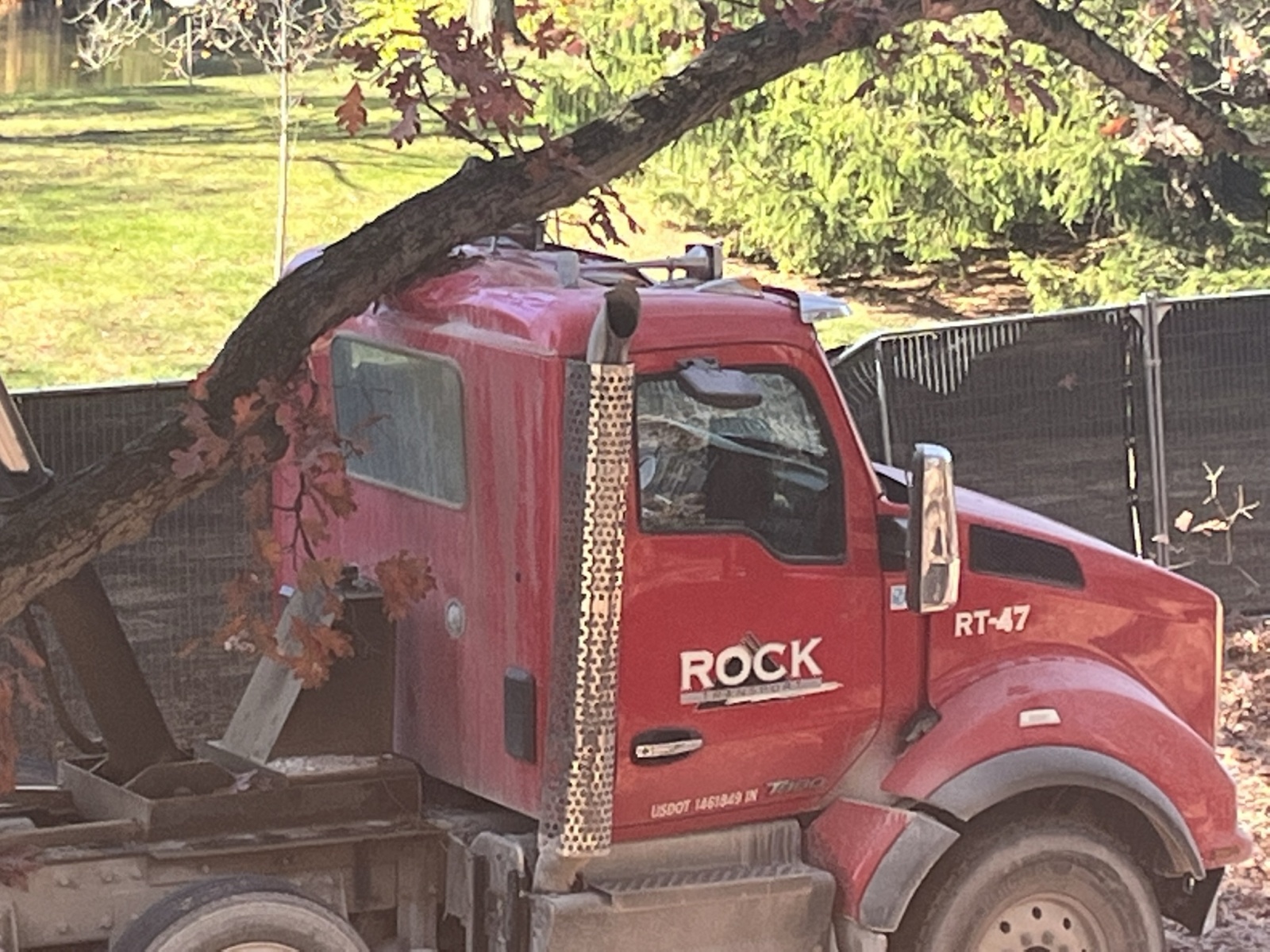

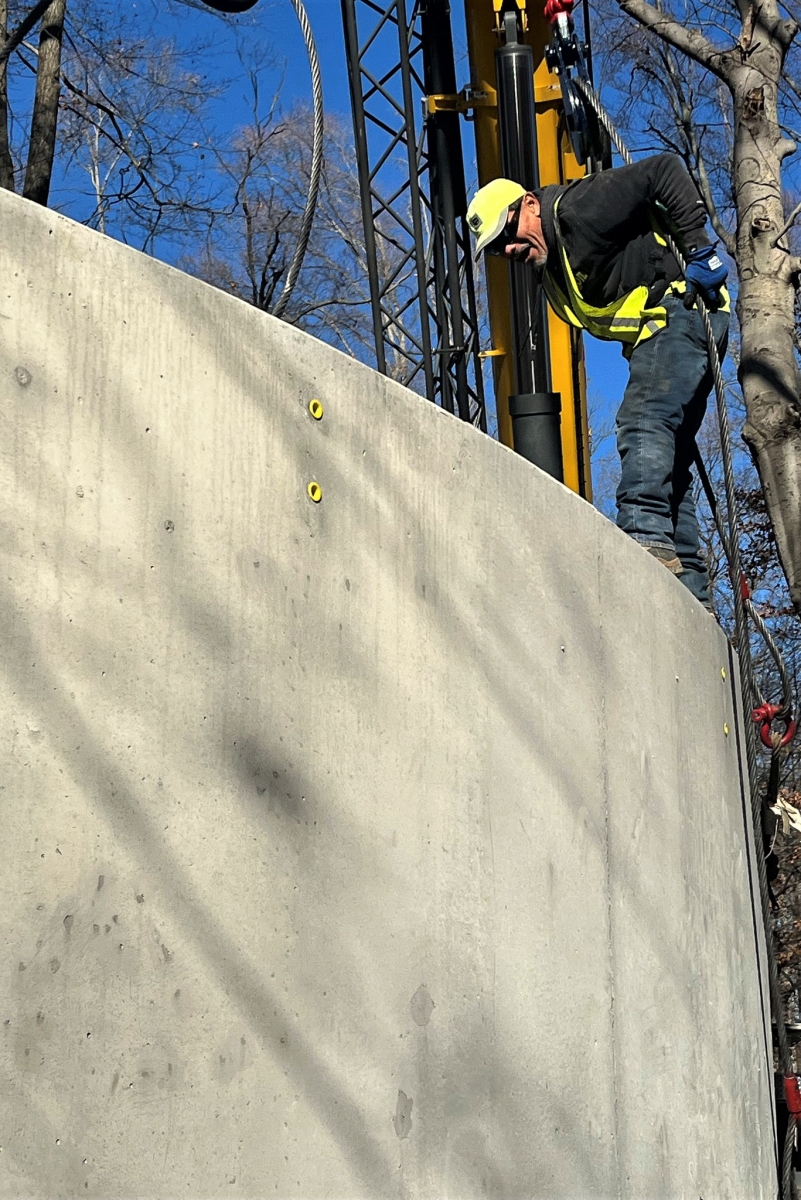

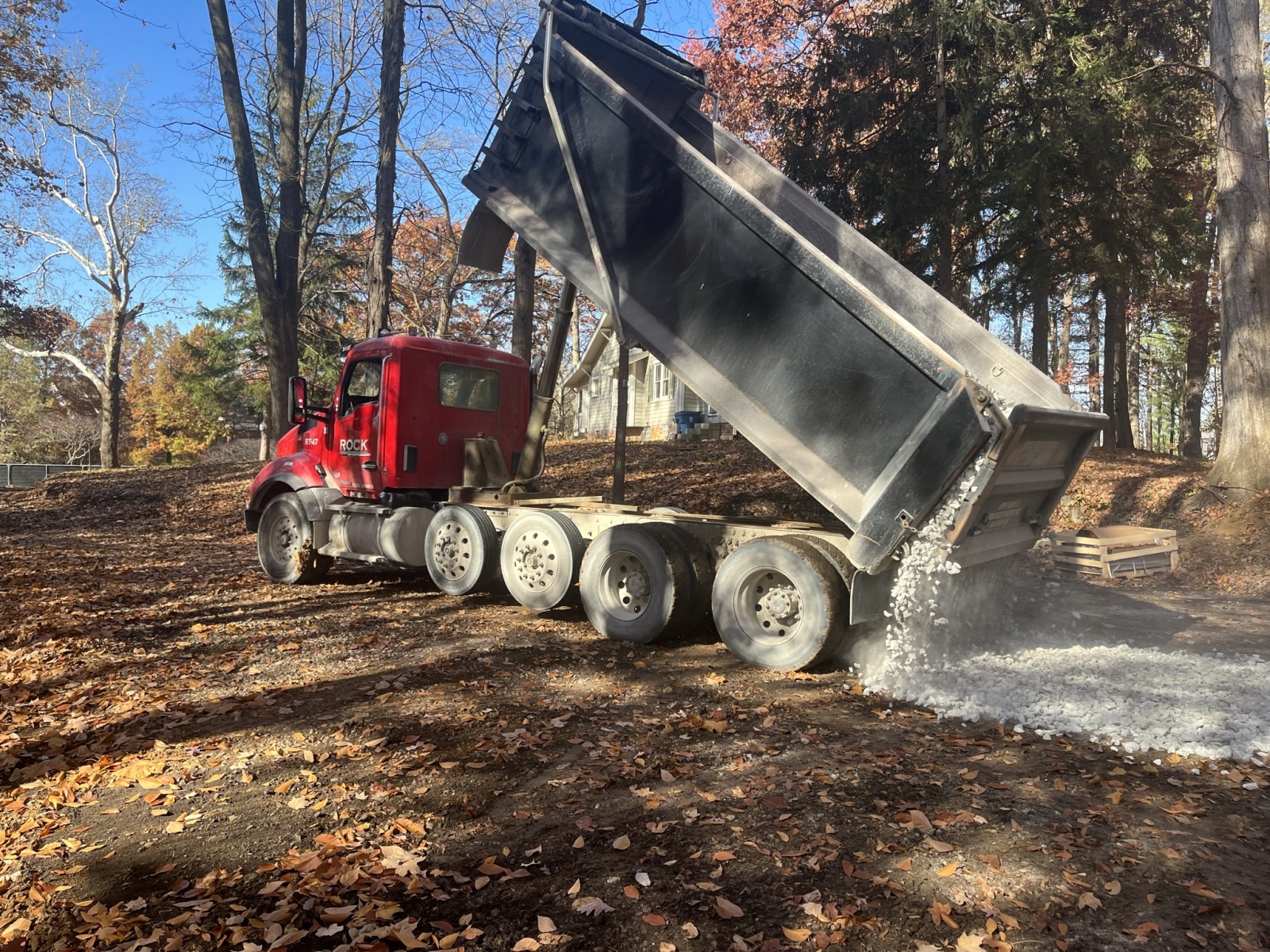

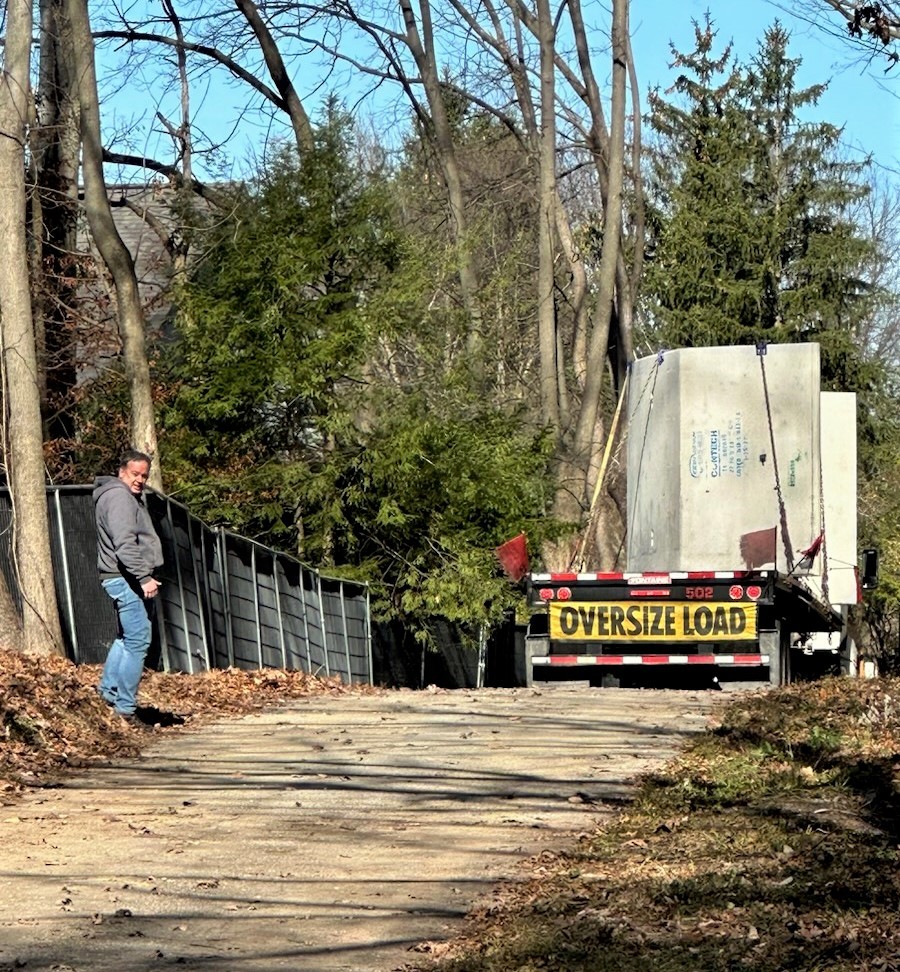

“Hey, I think that truck bed may be a little too high…”

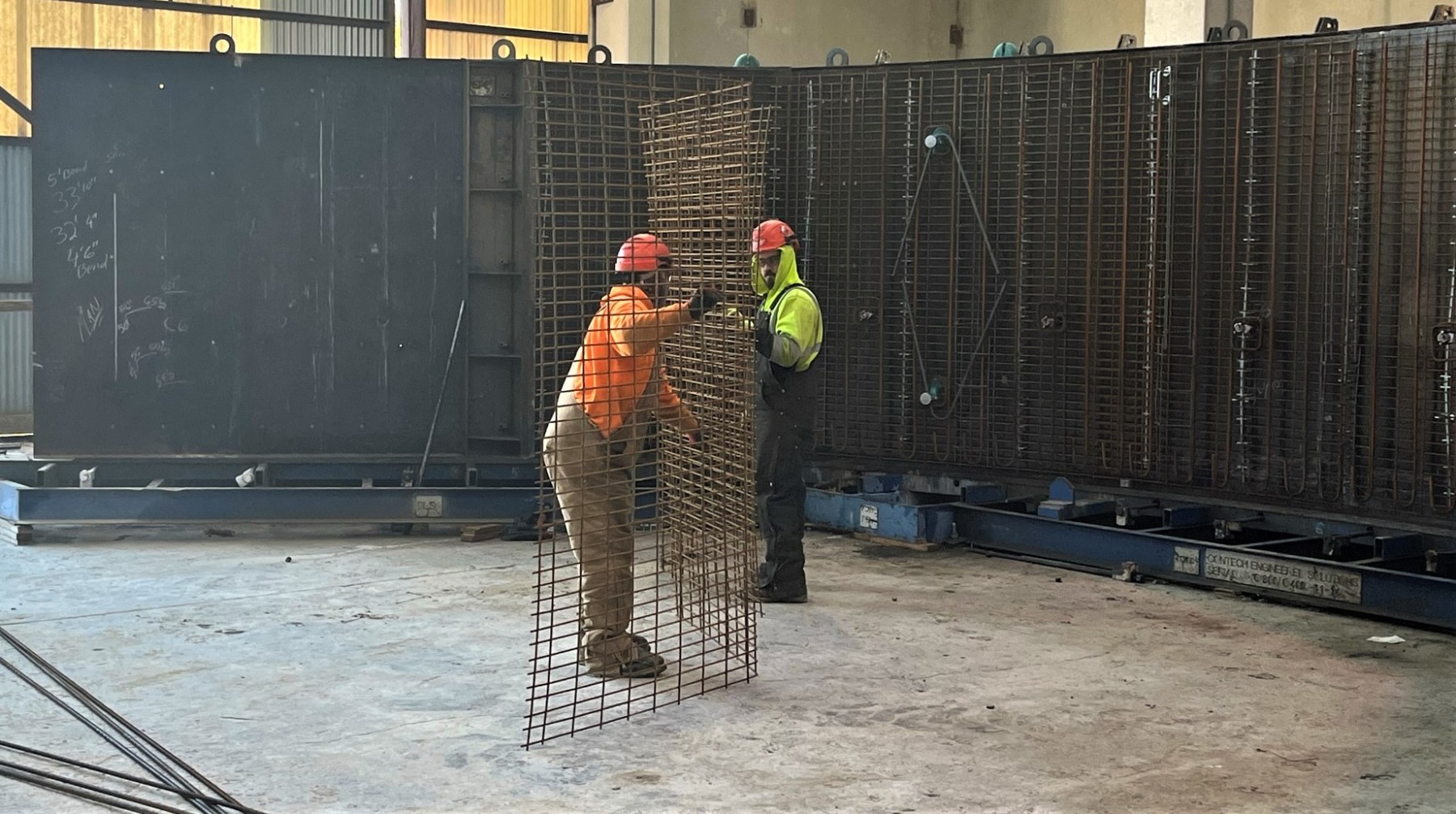

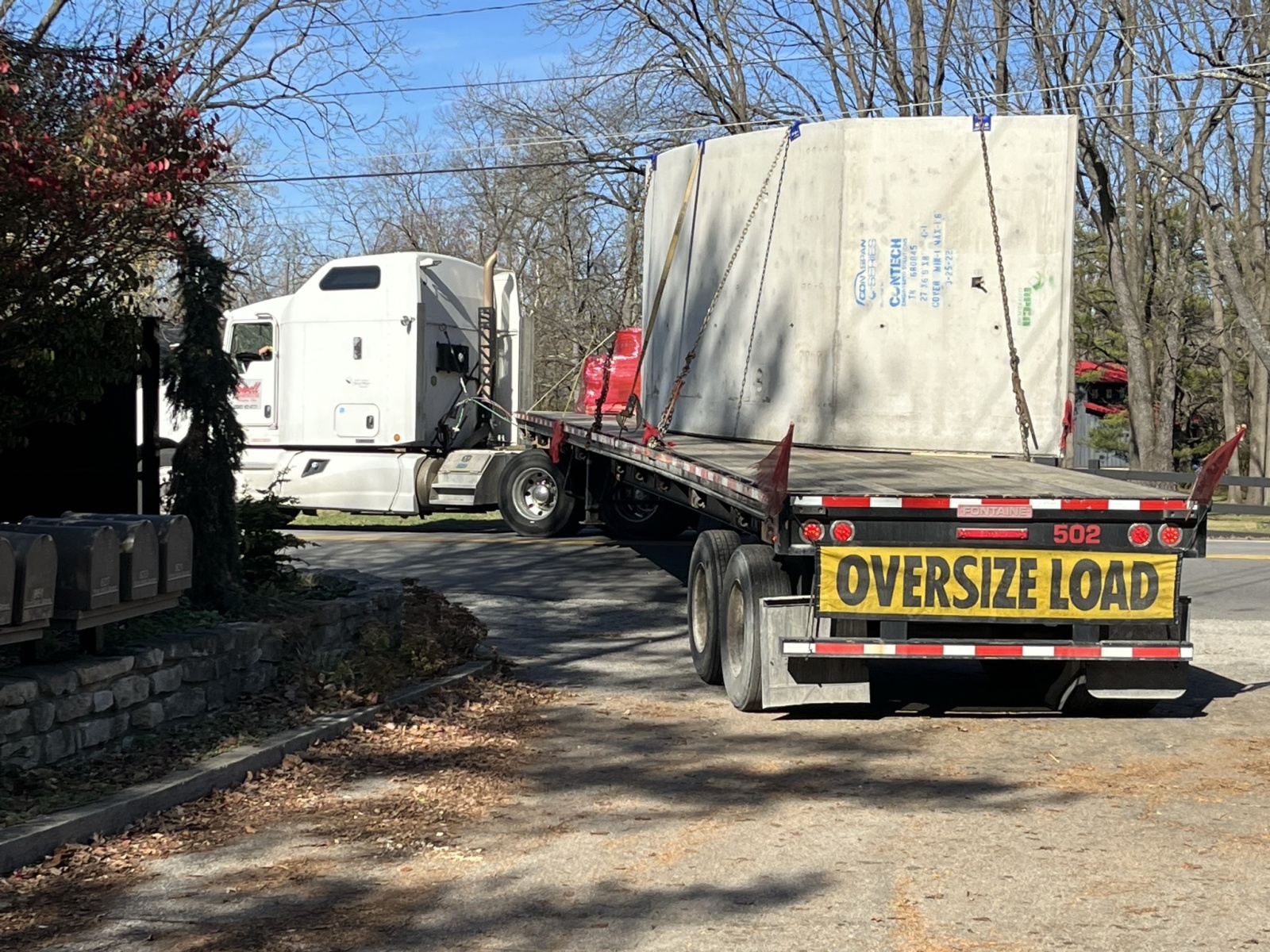

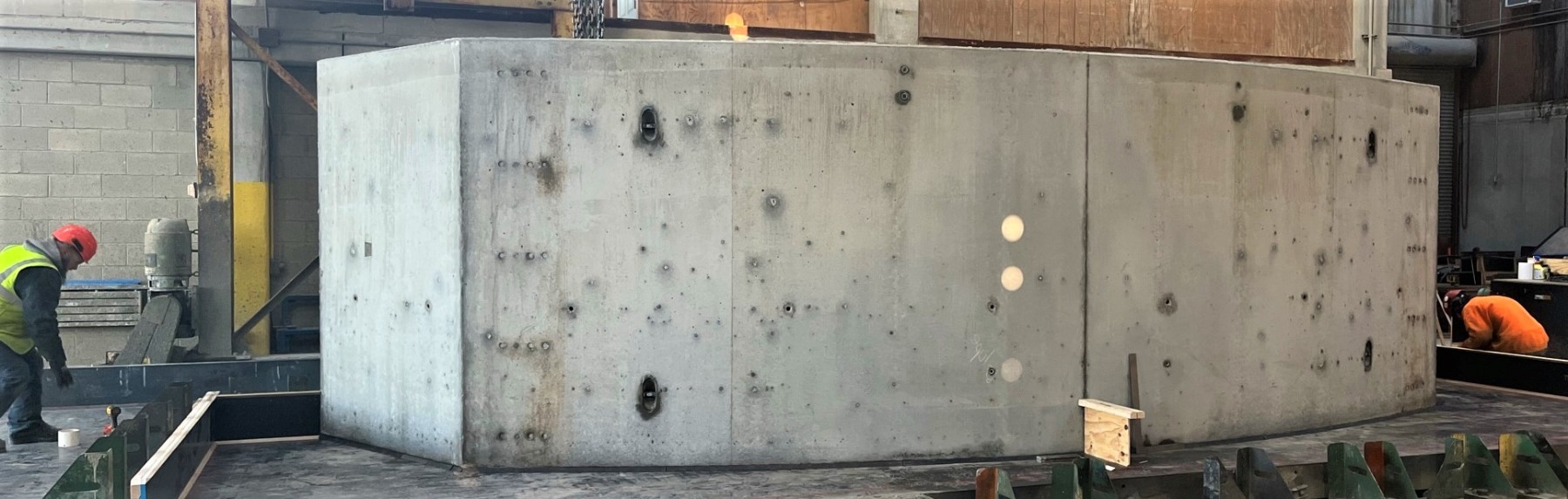

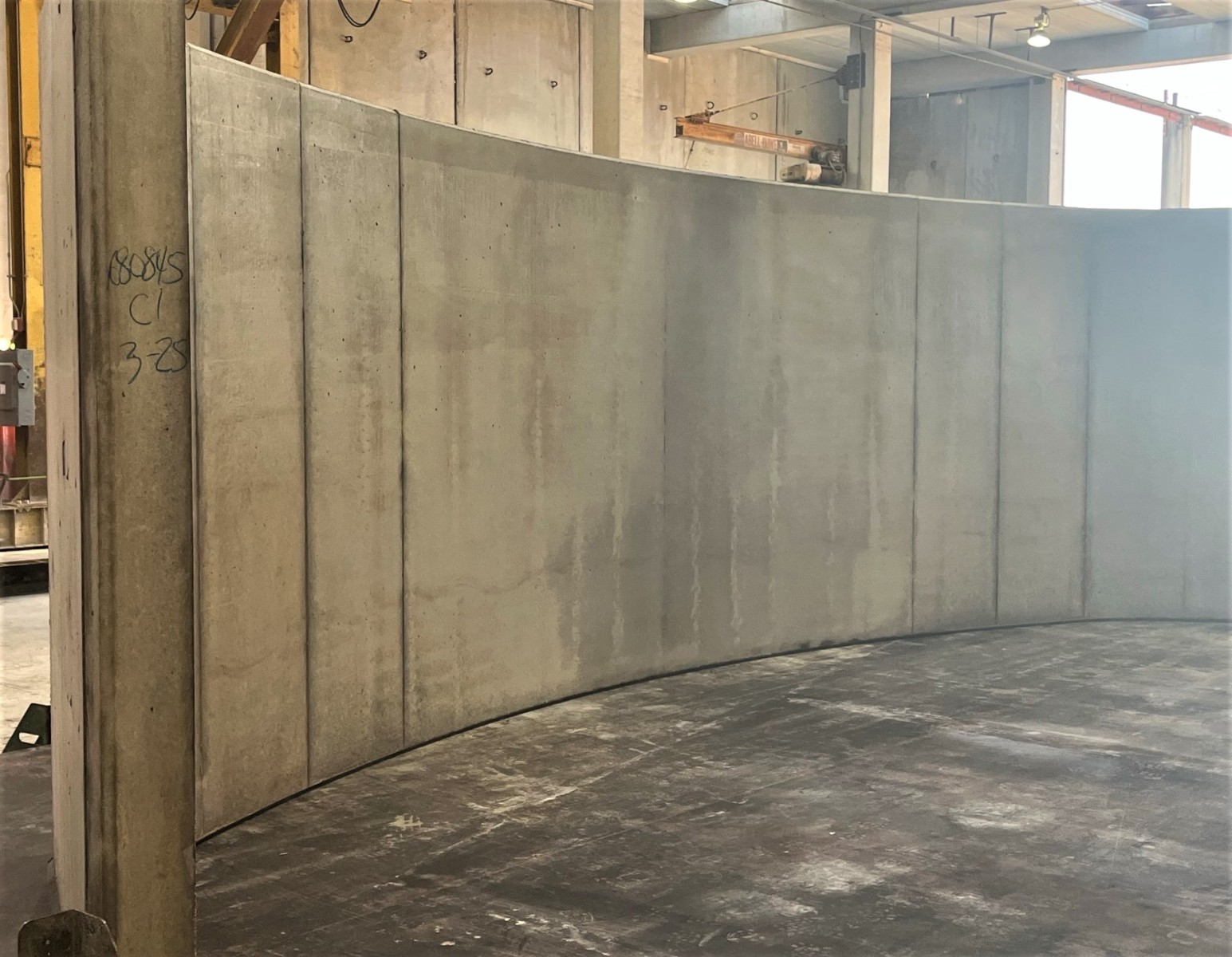

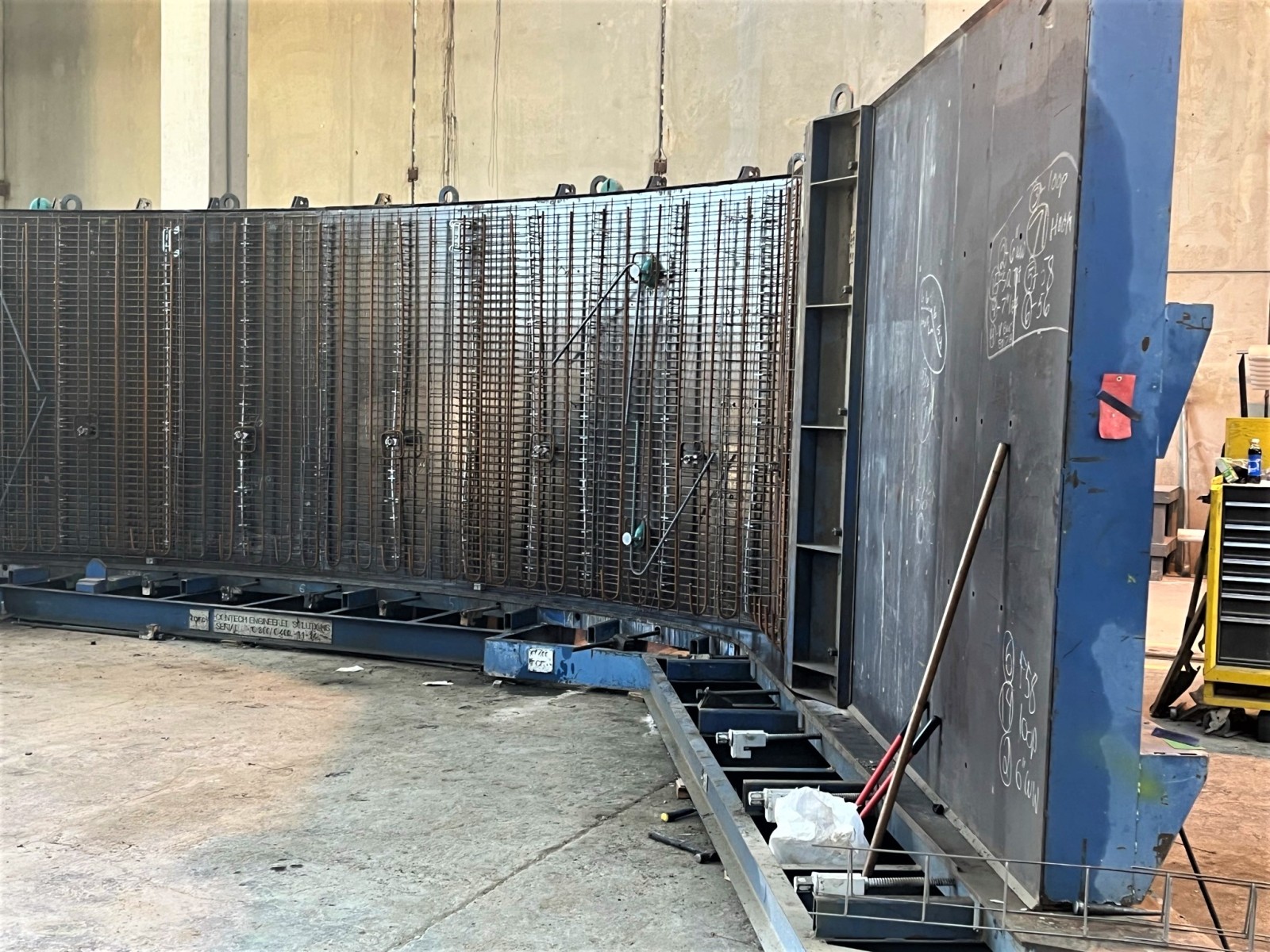

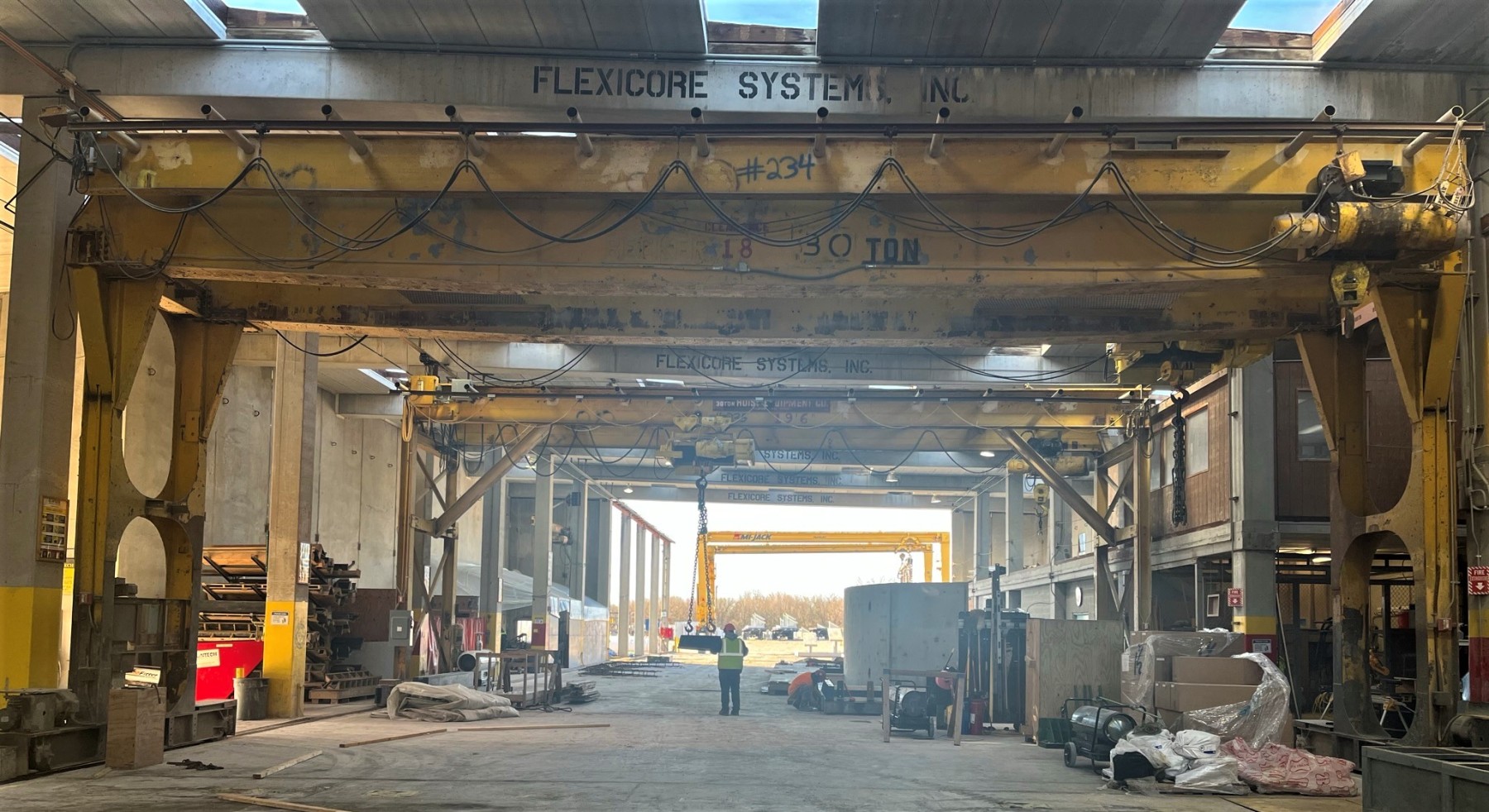

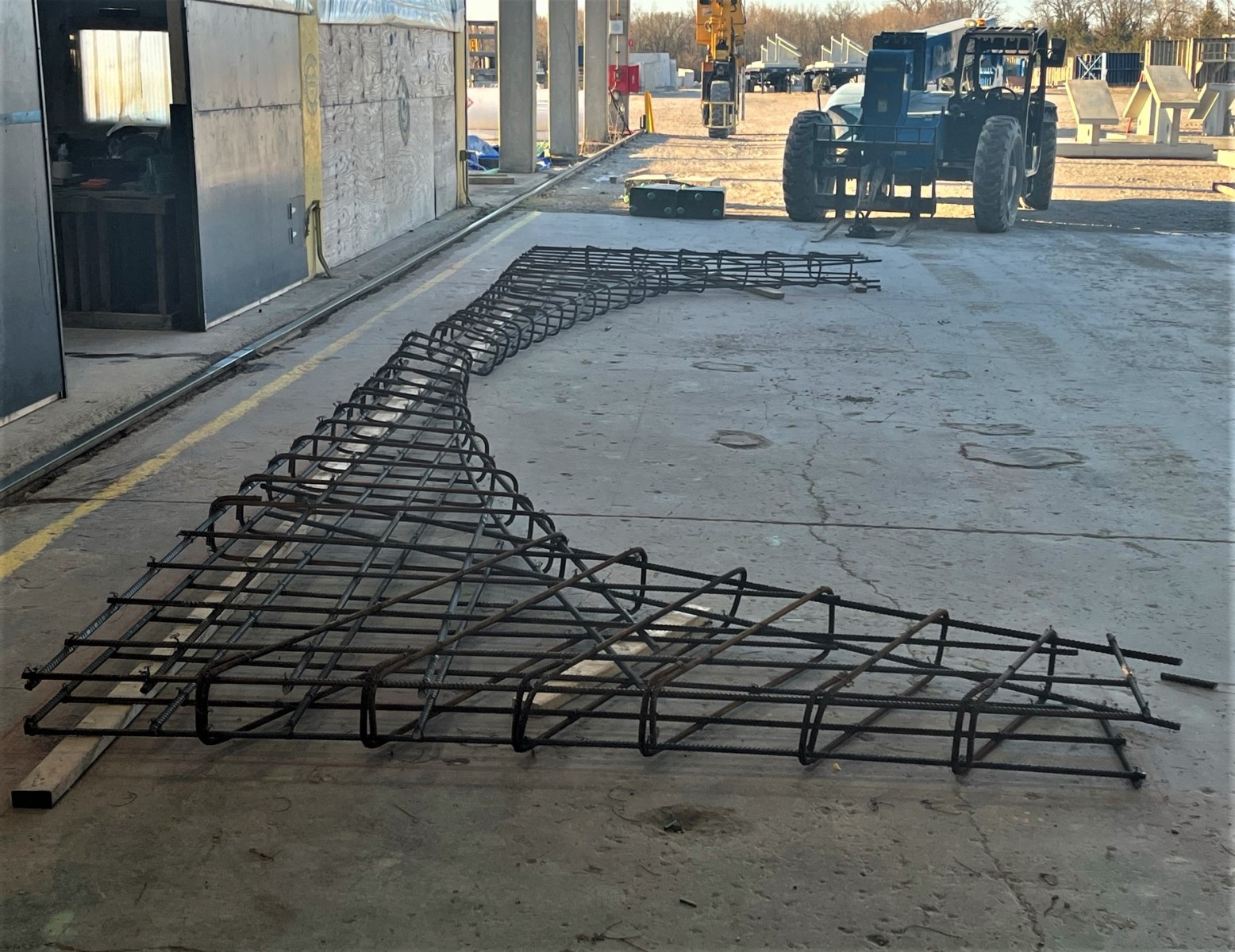

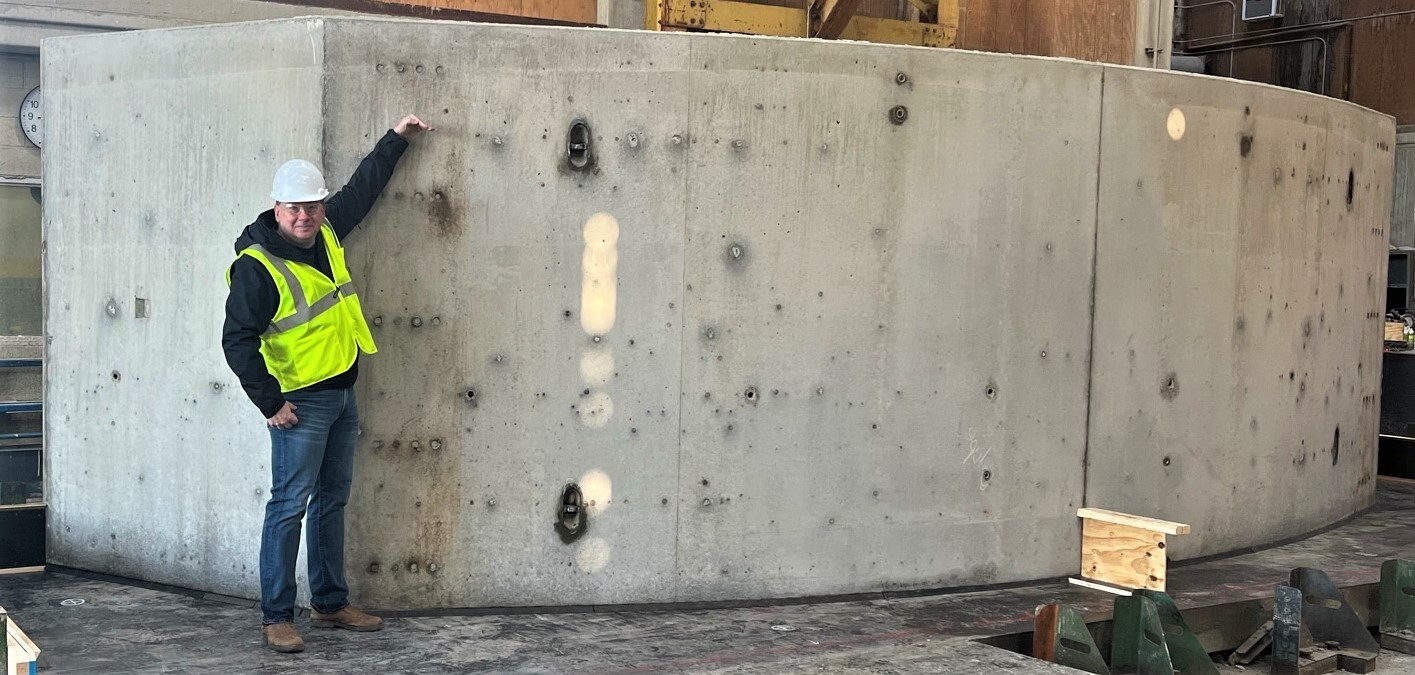

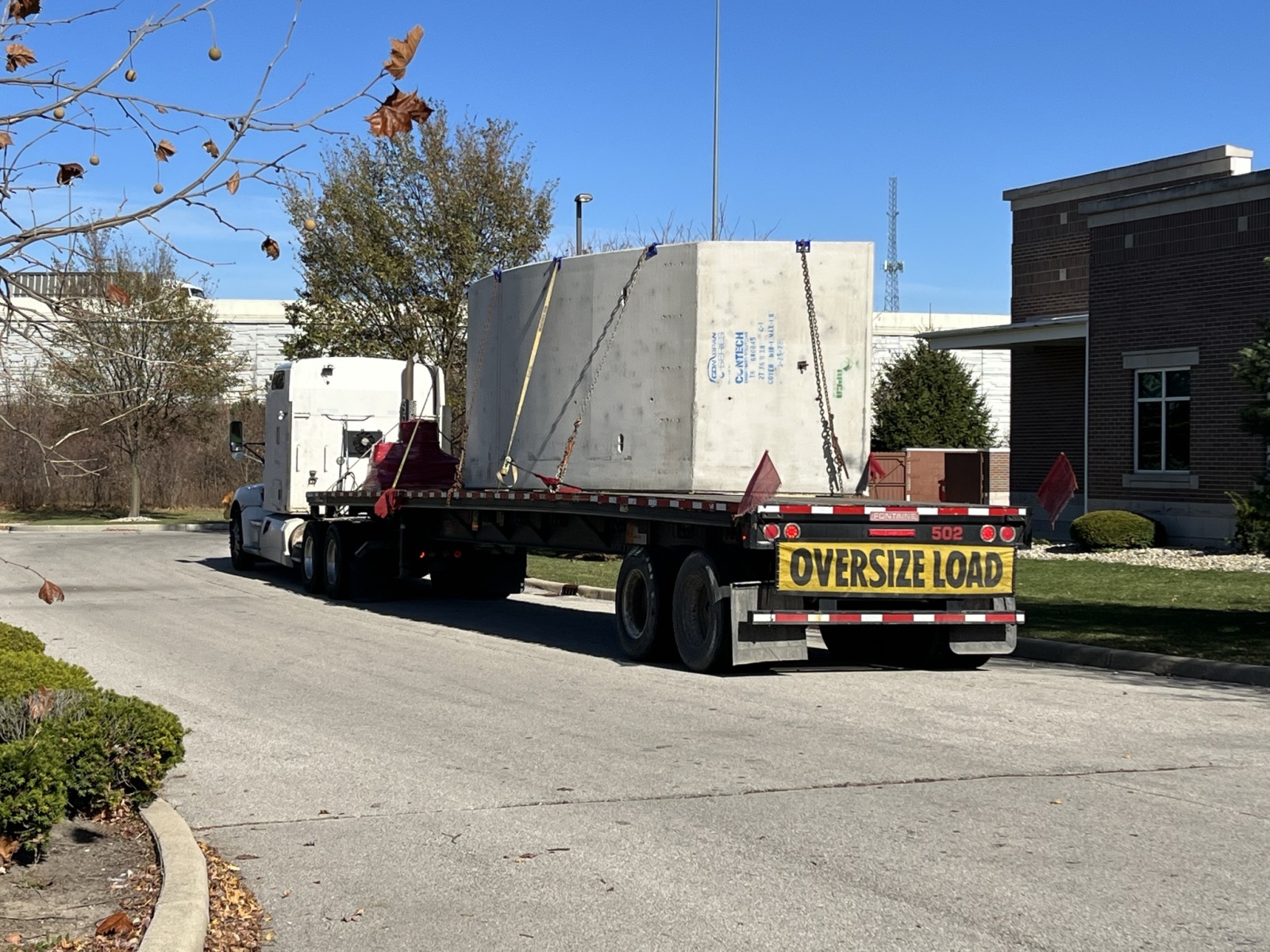

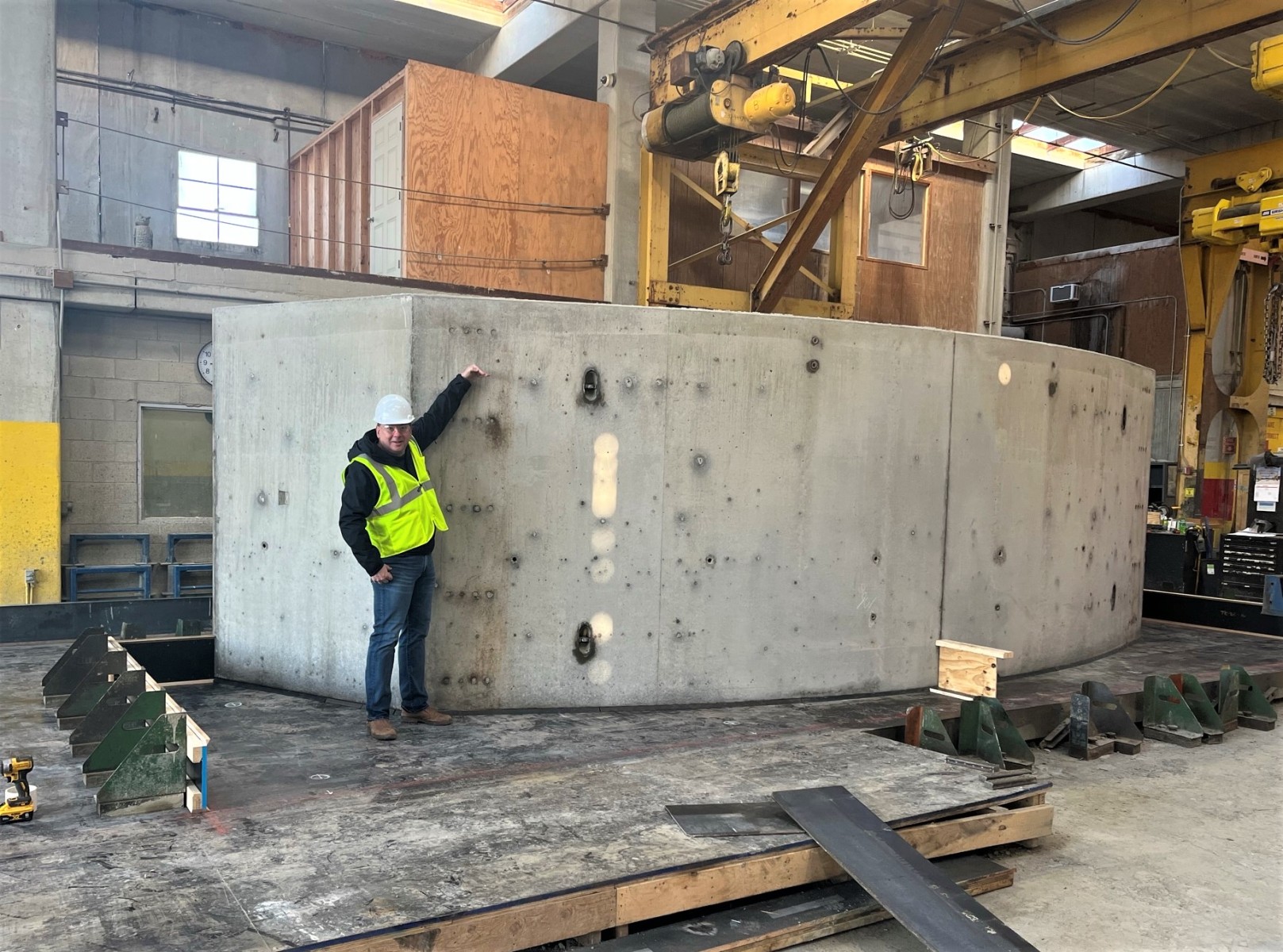

Where I visit the manufacturing facility and inspect the first piece of our cast concrete bridge today (it’s huge!) and get an inside look at the prep work for section #2. Special thanks to John Barth and Chris Bettum at Contech Engineered Solutions, in Dayton, Ohio.

Forgotten Creek Drive has formally been approved by the USPS.

Download PDF of The Ridge on Williams Creek USPS Approval with Addresses

A little digging reveals the property’s original owner as Alexander Taggart, who brought the original log cabin (still standing today) to the property around 1903, develops Wonder Bread in 1921, and then builds their family home there in 1939. A guest house, which is also still standing, would follow in the 50’s.
Me: (jokingly) “My builder friend Brad thinks I should develop my own subdivision.”

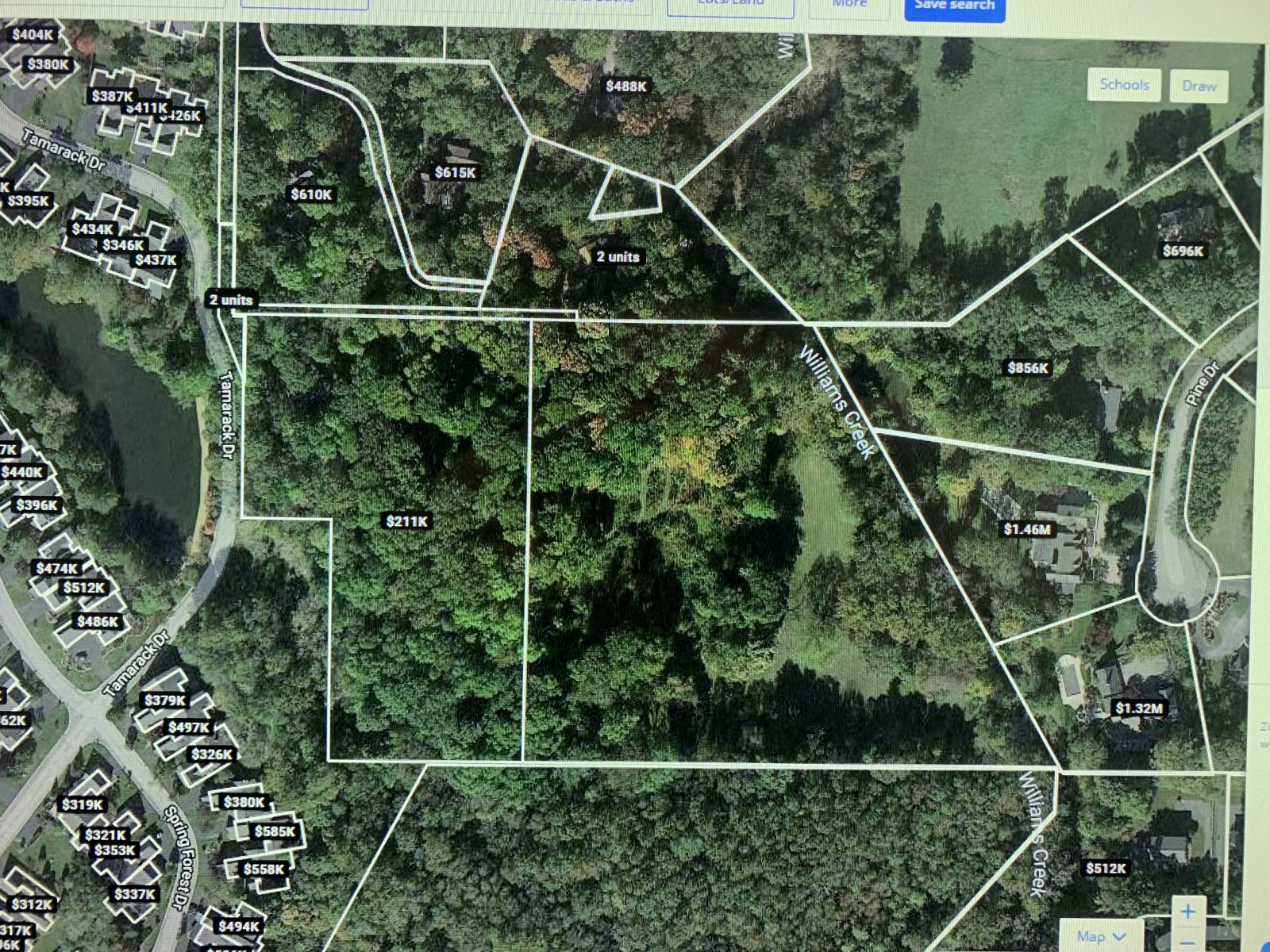

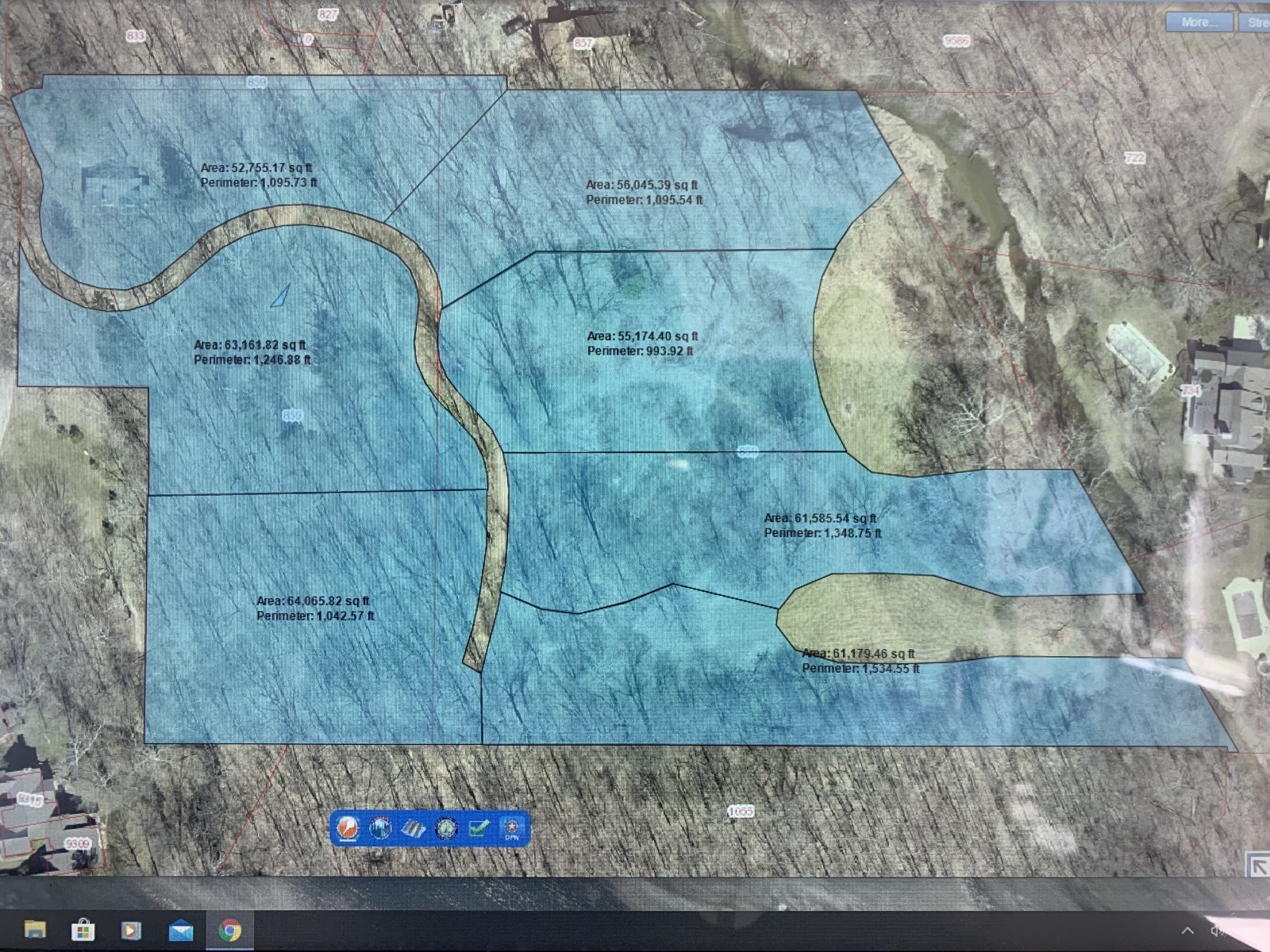

Paul: (my realtor) “Have you seen the 12 acres for sale on 96th Street?”
Me: “I didn’t think there was any land left in Marion County?”
Paul: “It’s been for sale for years. It’s on Williams Creek.”
Me: “What?”
Paul: “You busy? Lets take a drive over there.”
My wife Jackie: (later that evening) “You want to do what??”
